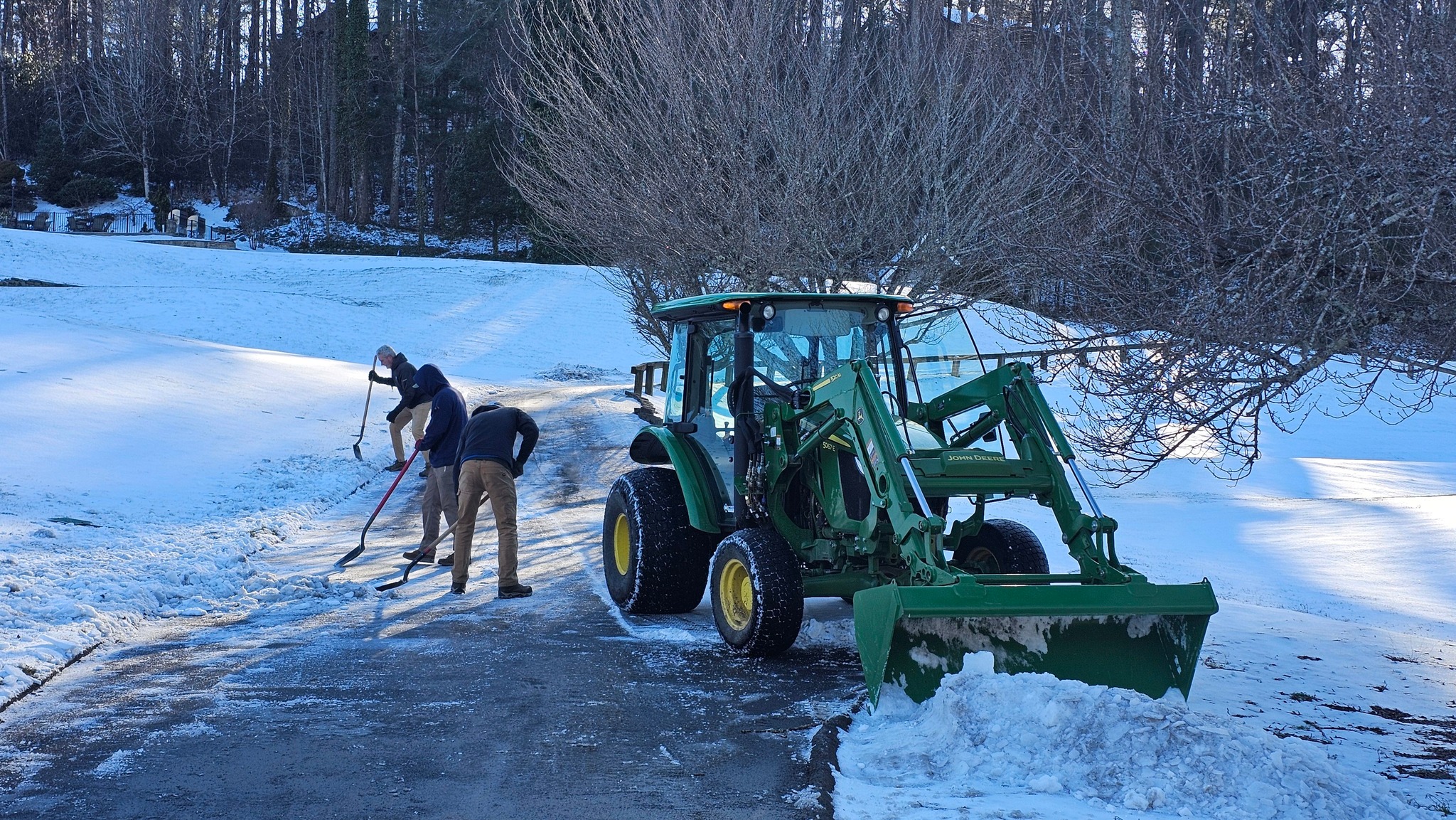

Each year, I submit a winter maintenance plan that is reviewed with the General Manager and serves as our outline for offseason projects. This year, I am pleased to report that all tasks on our project list have been completed.
Debris Cleanup

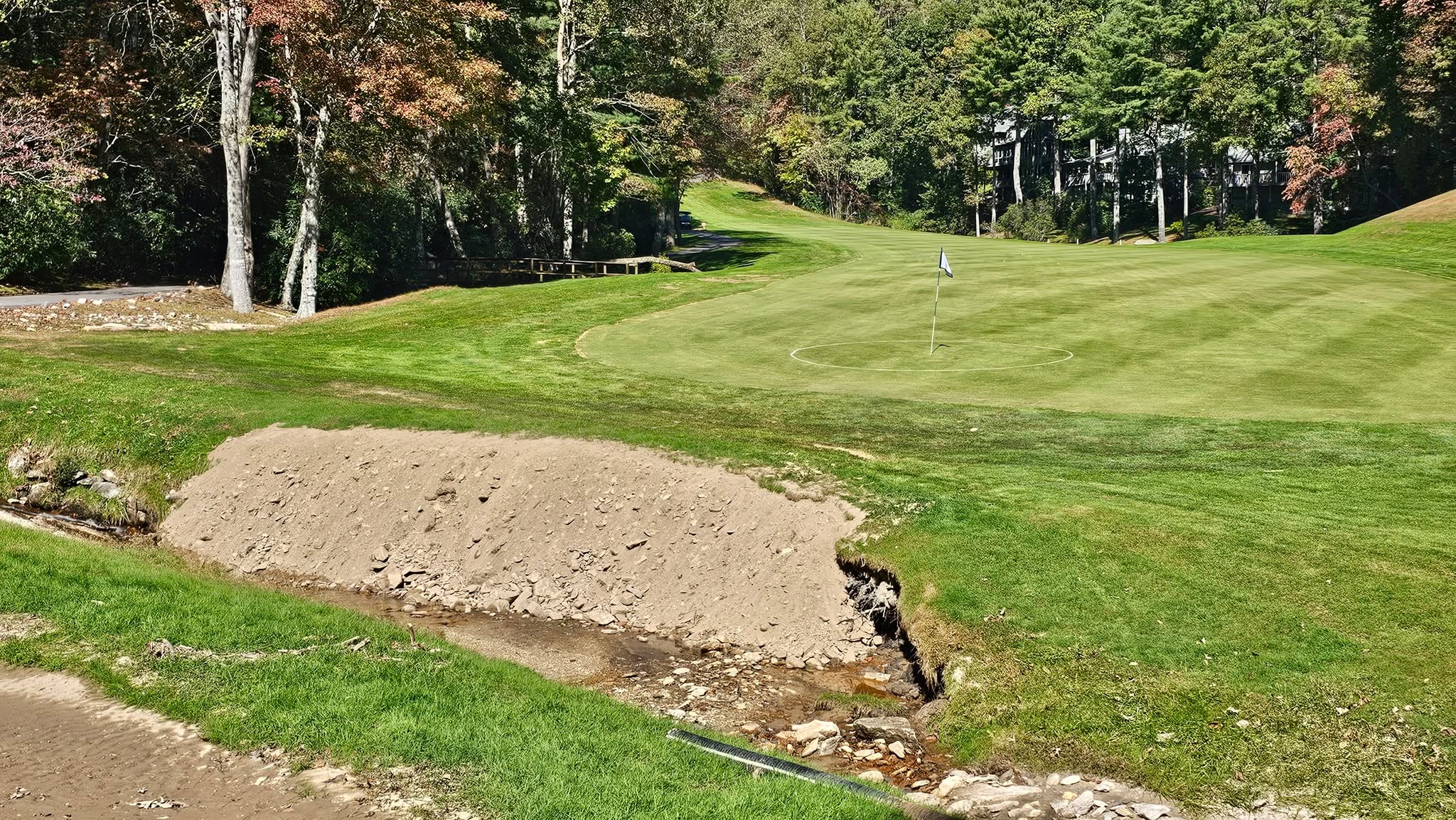

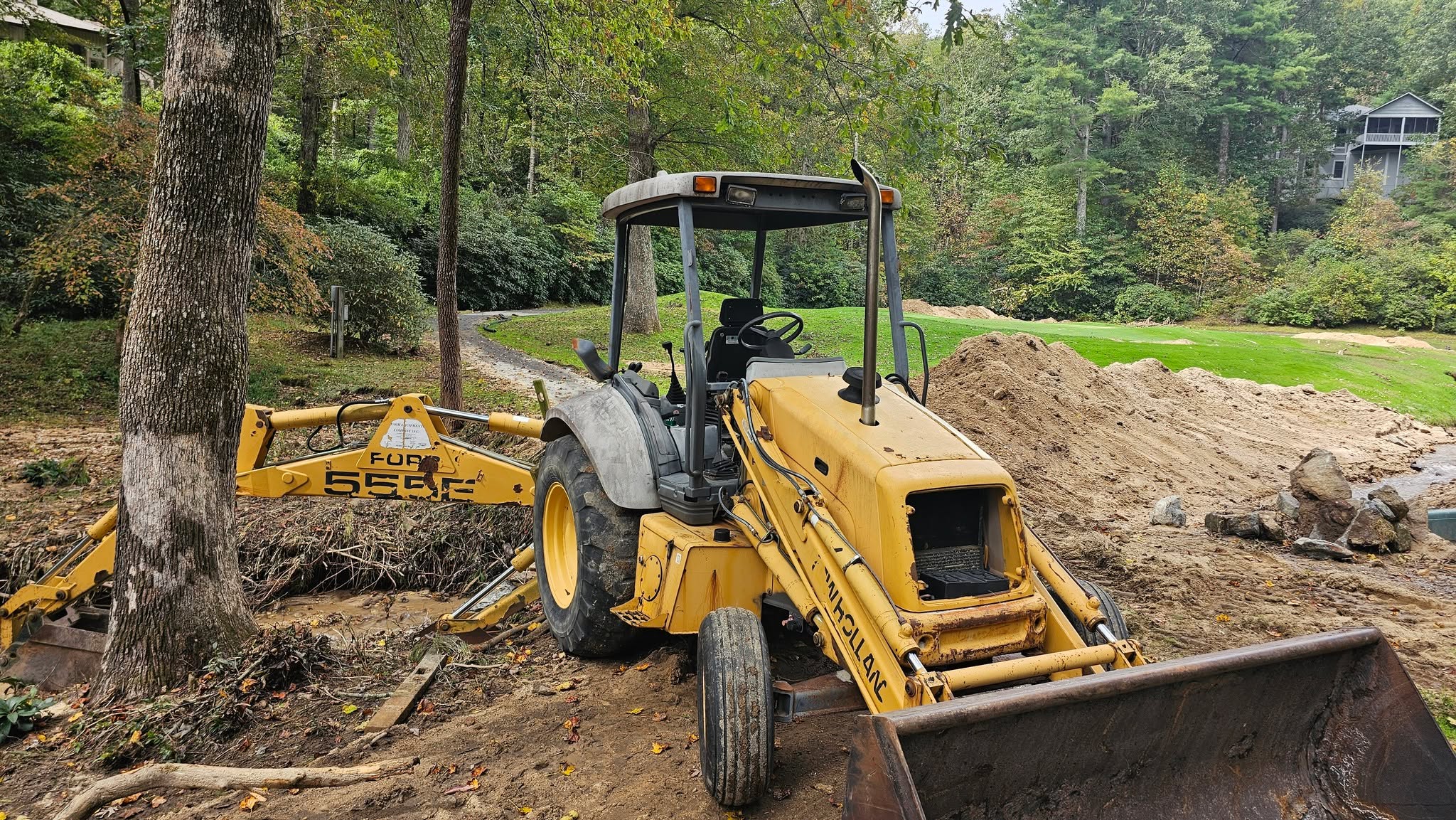

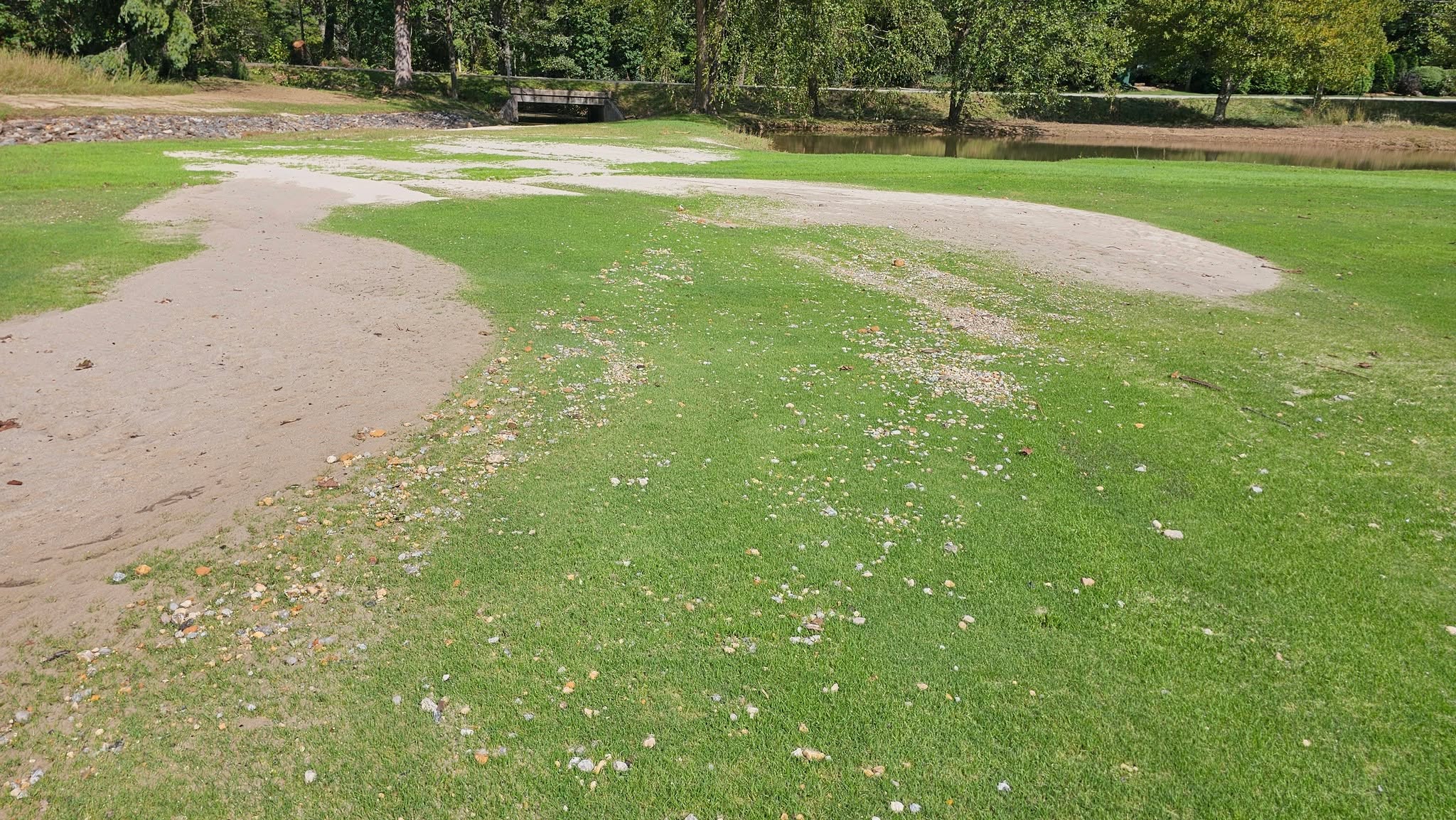

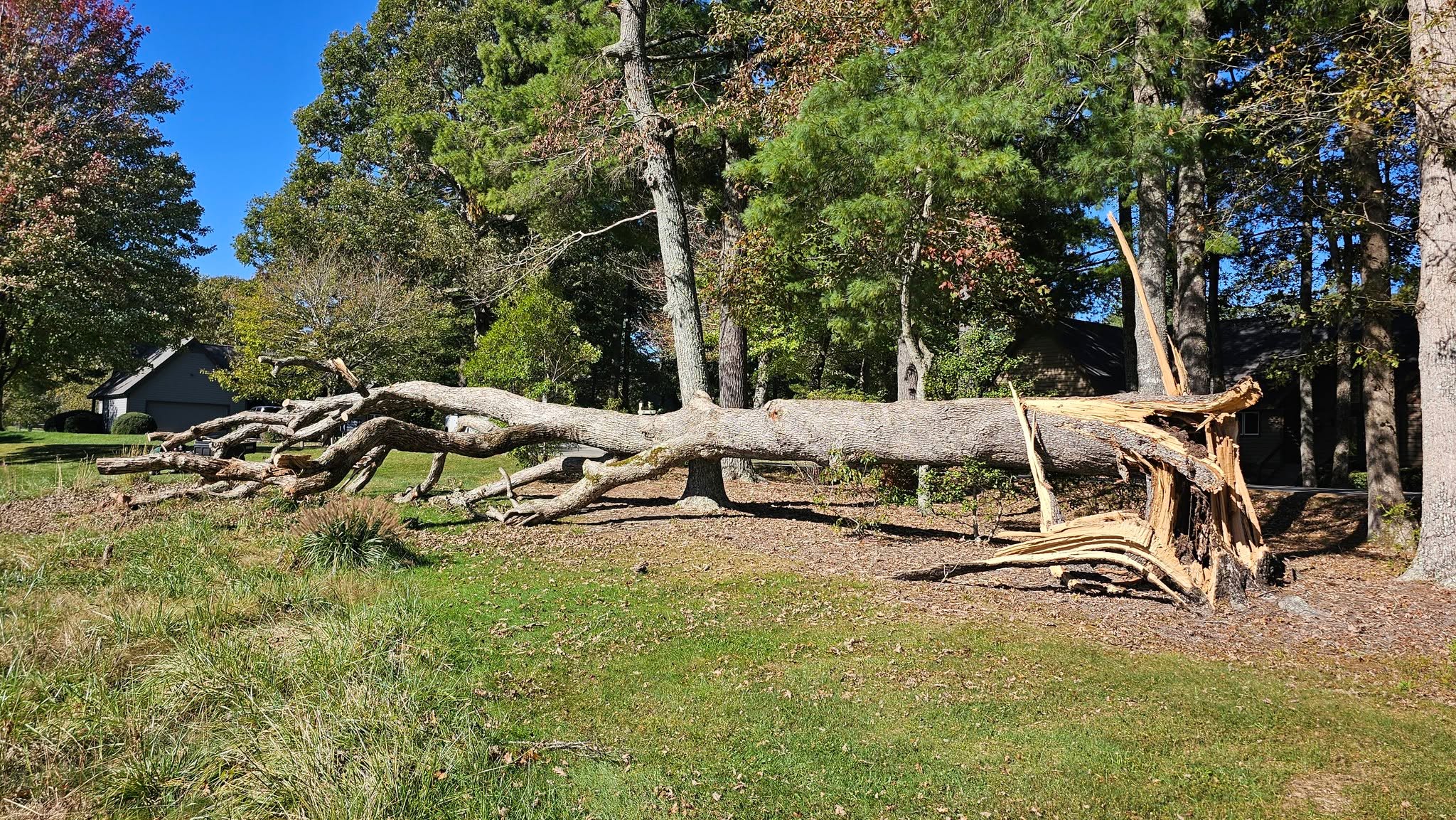

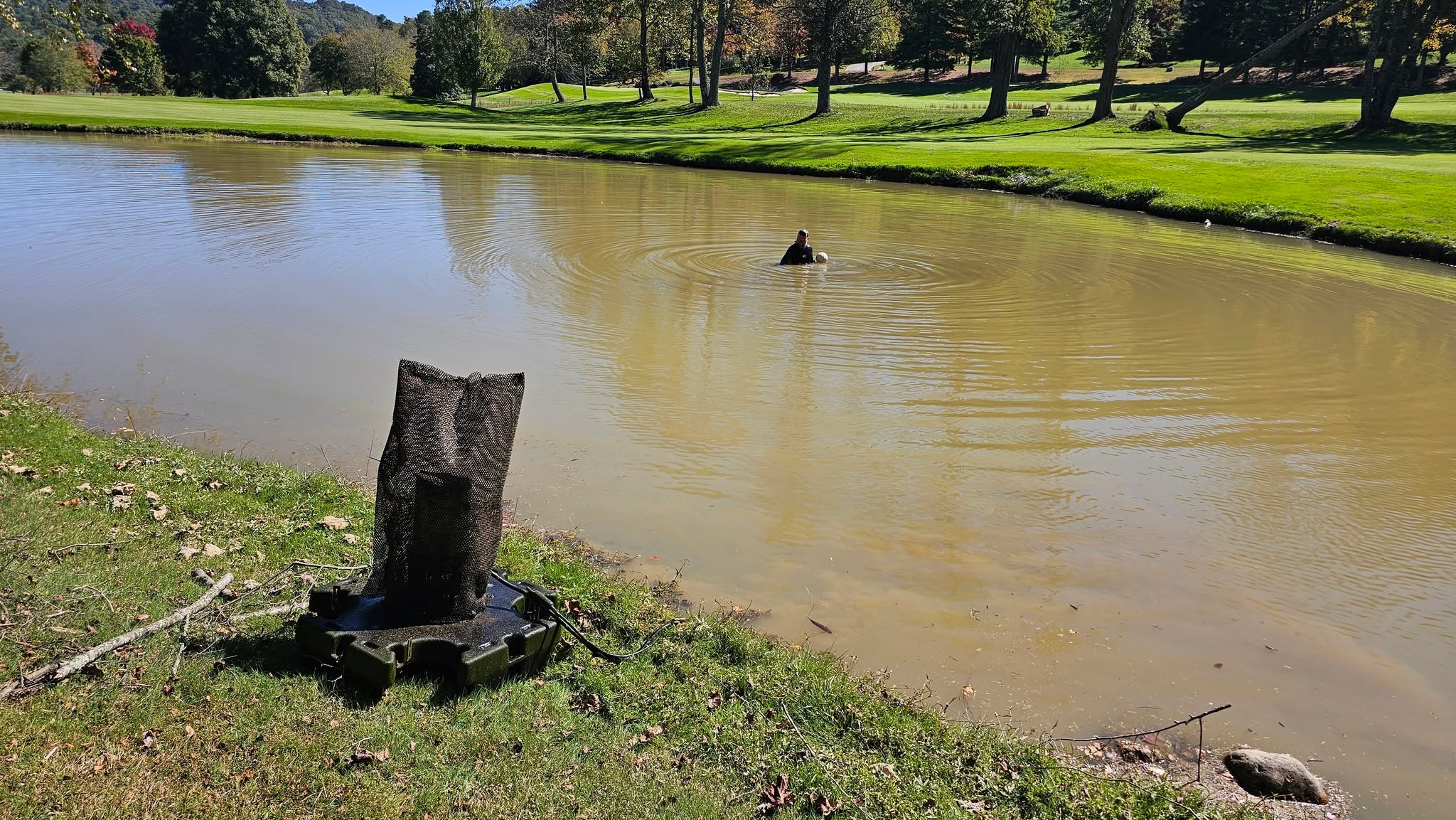

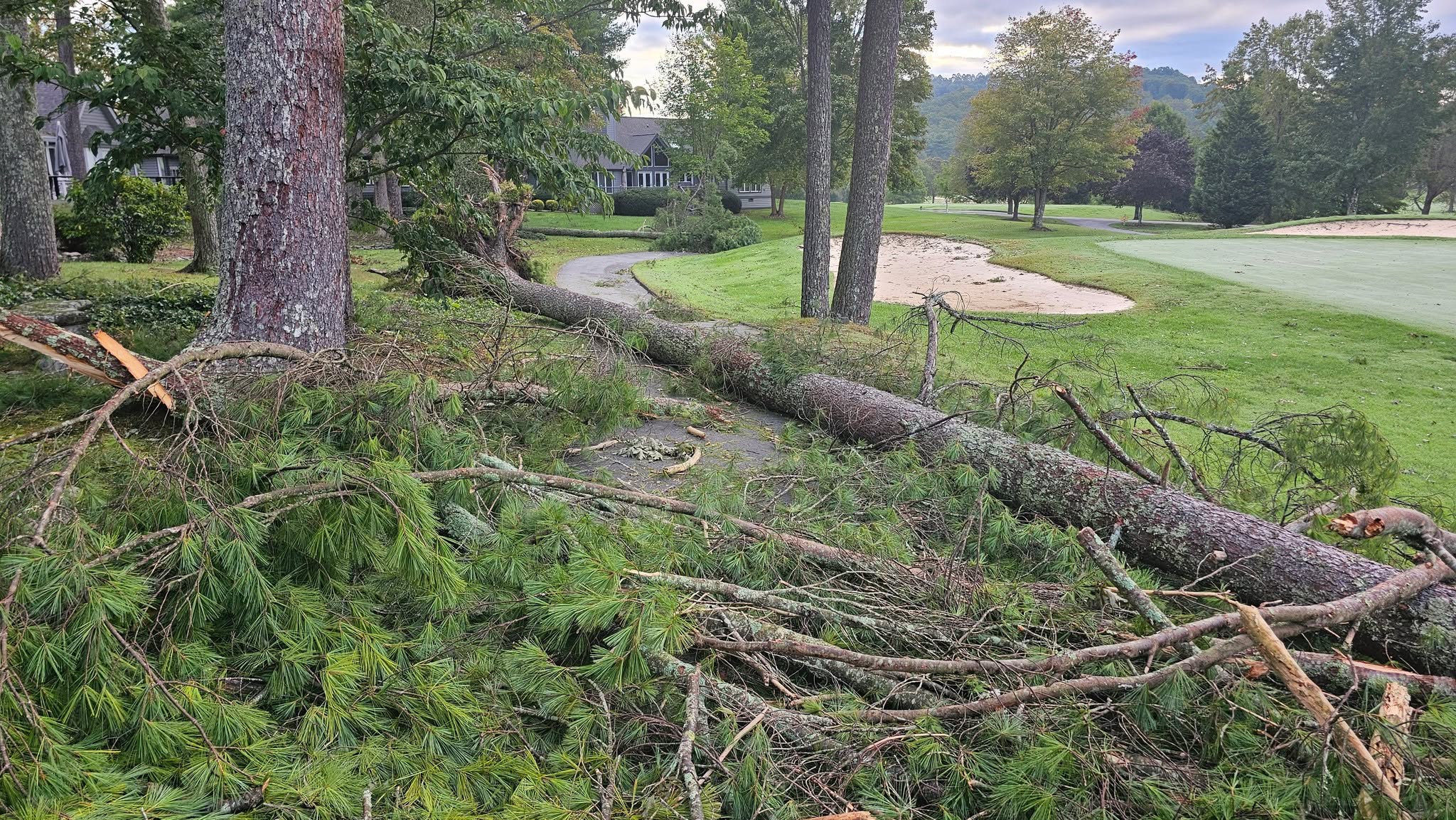

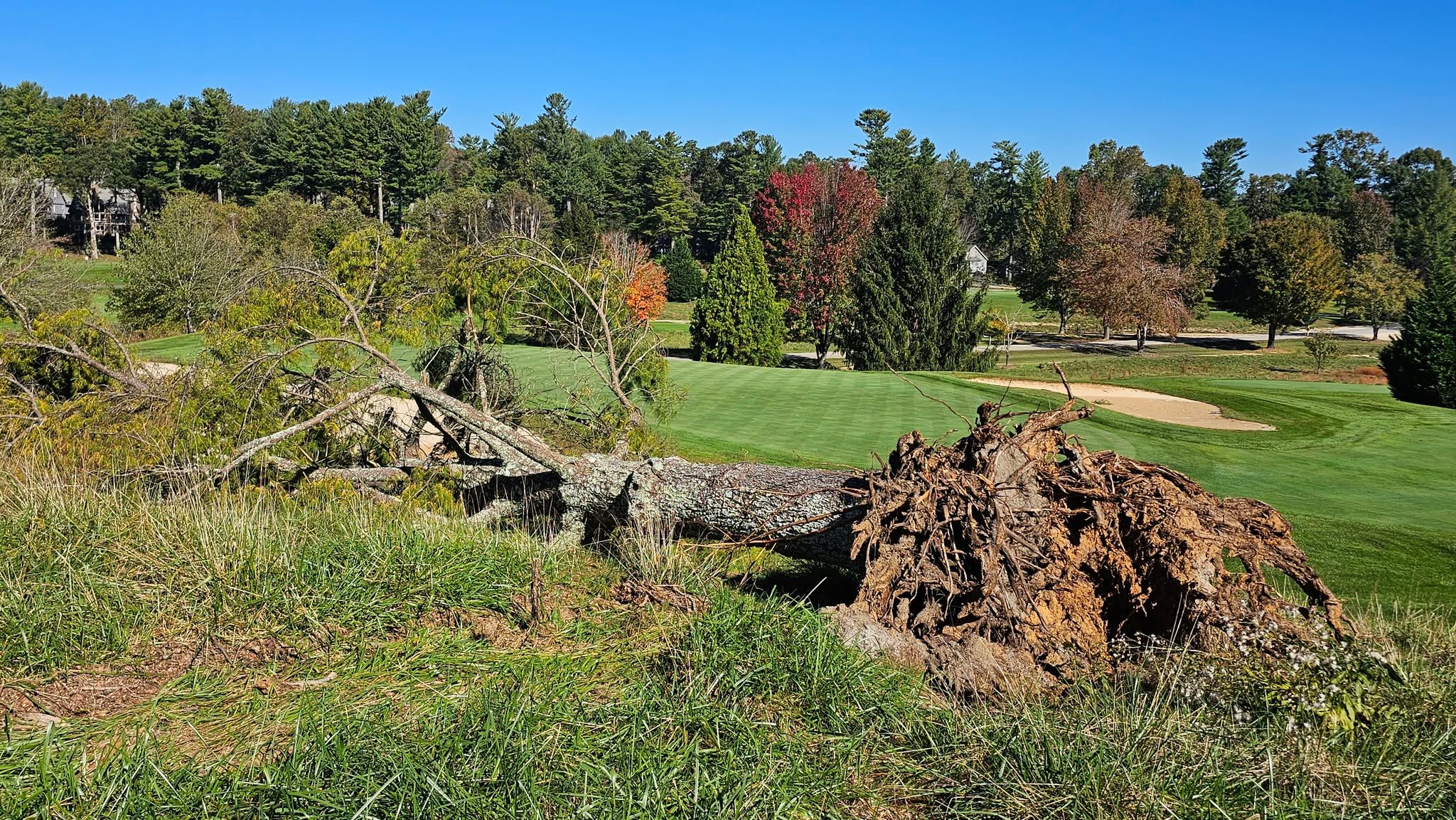

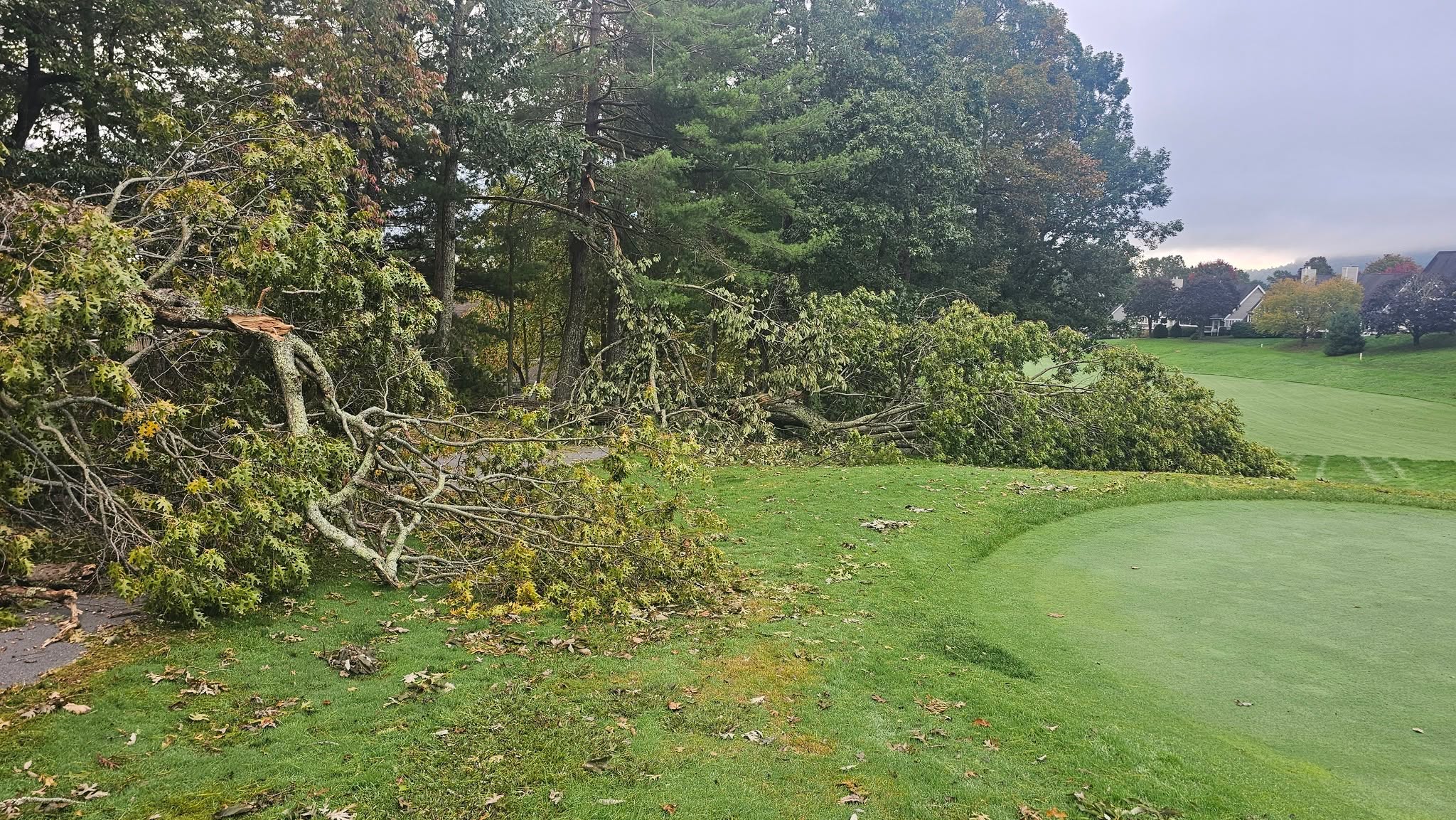

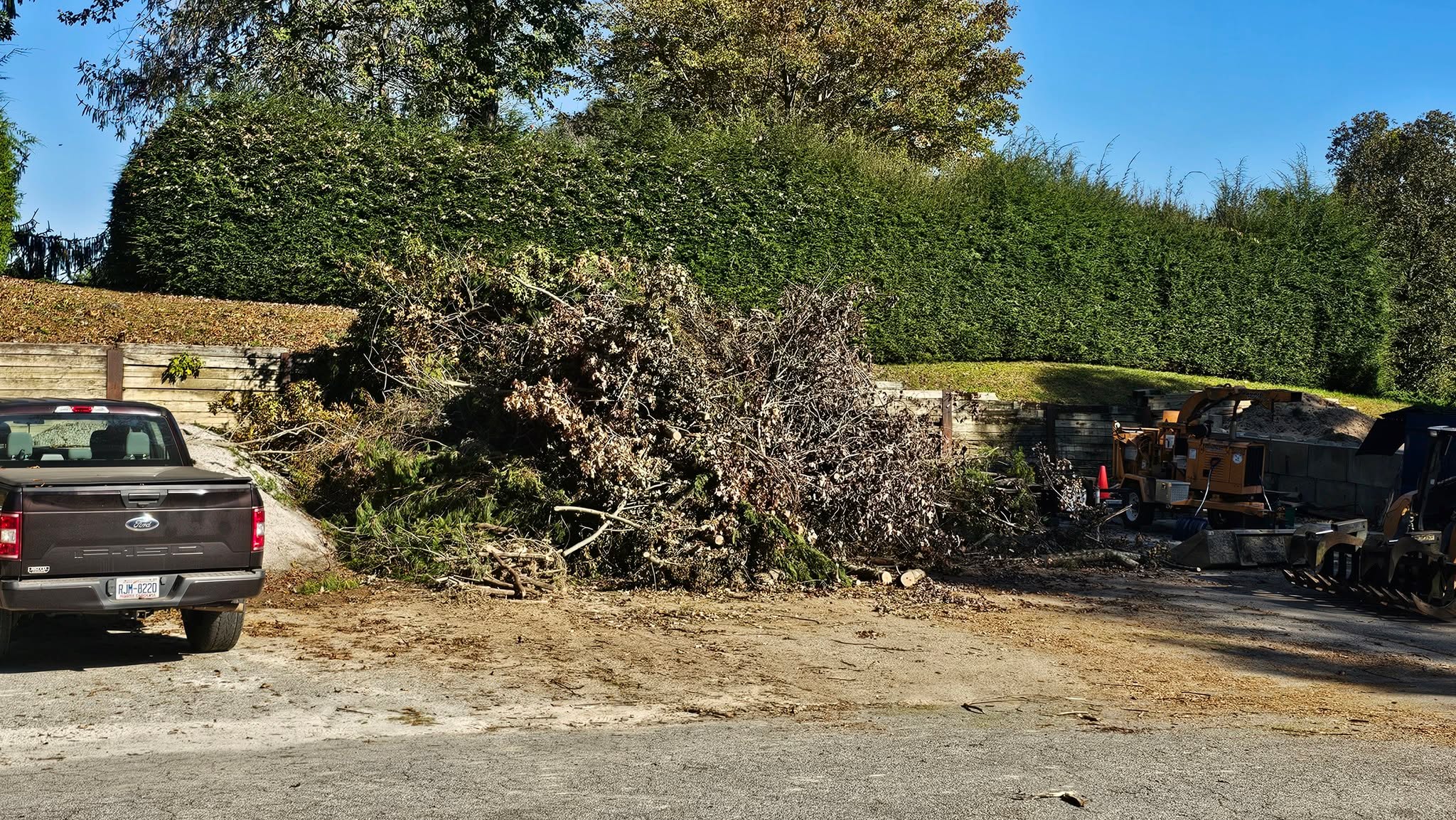

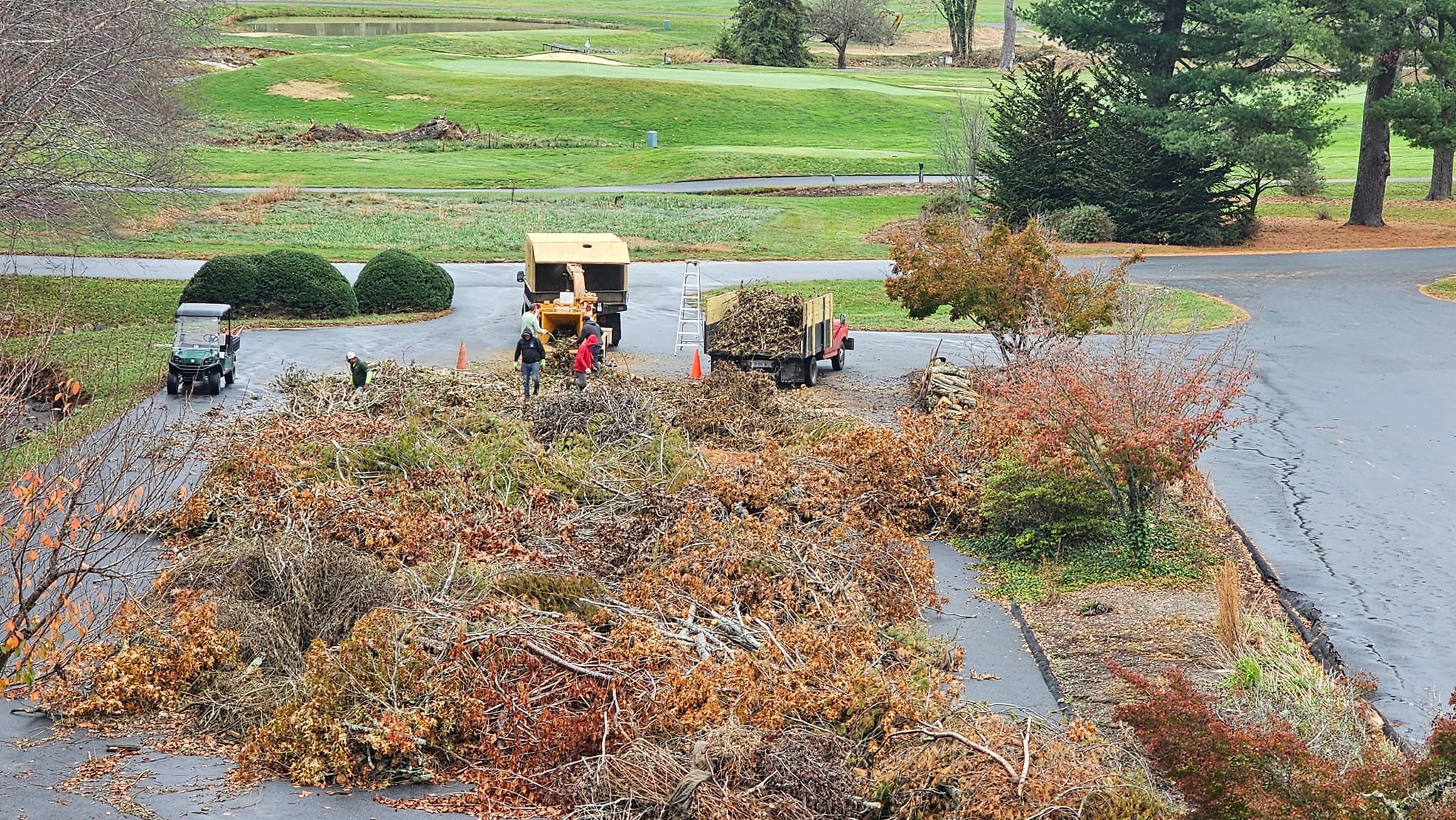

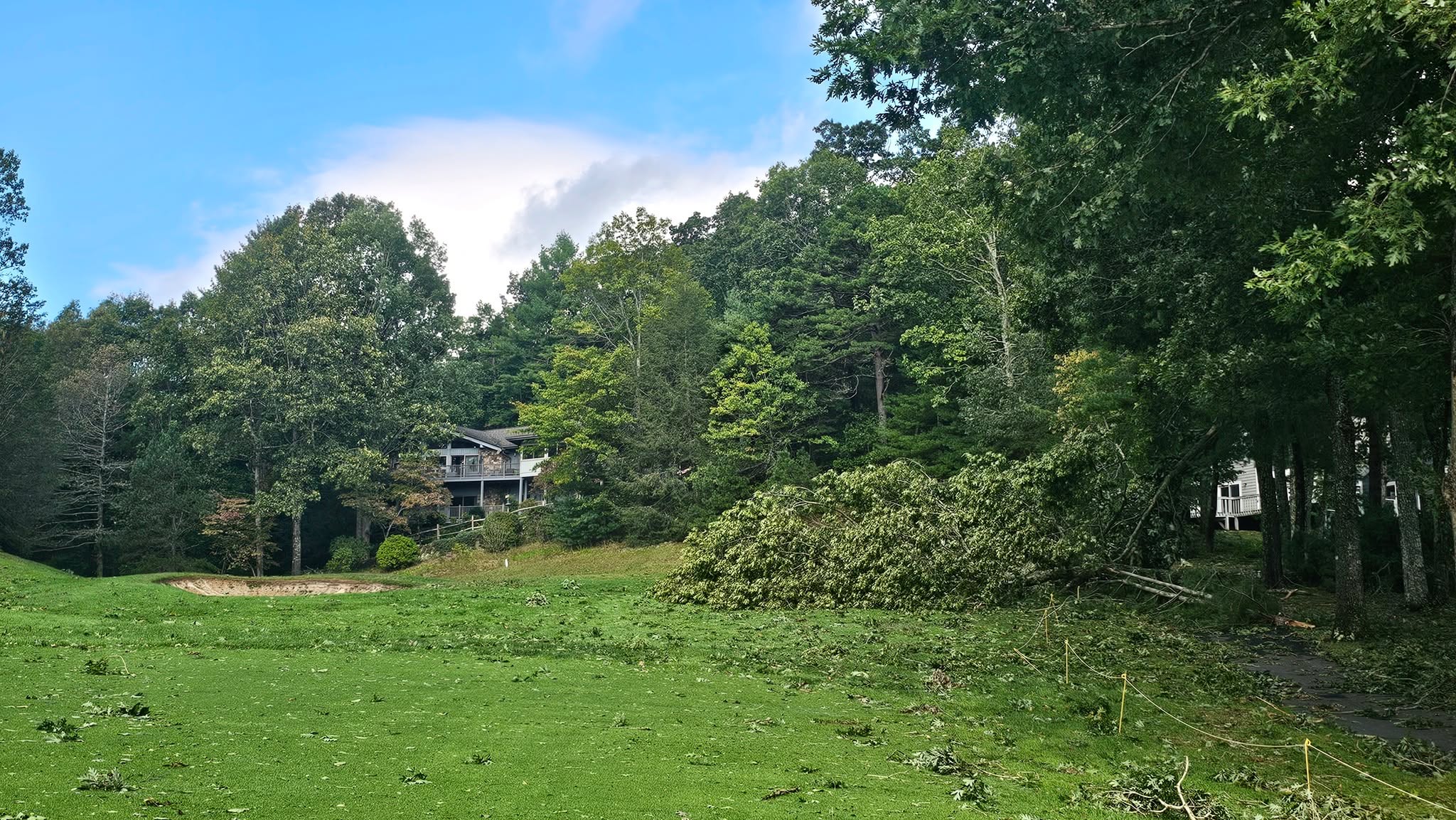

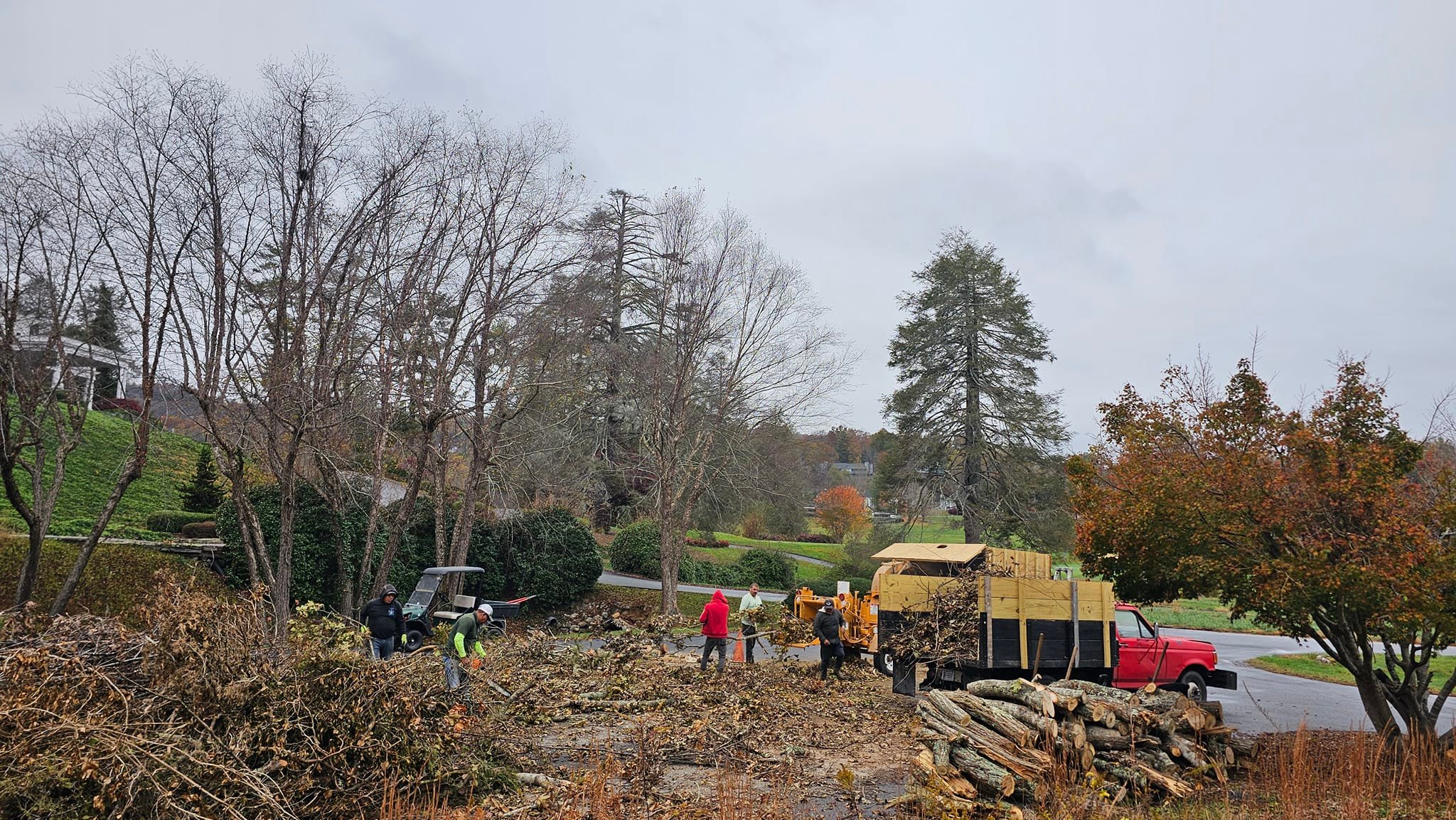

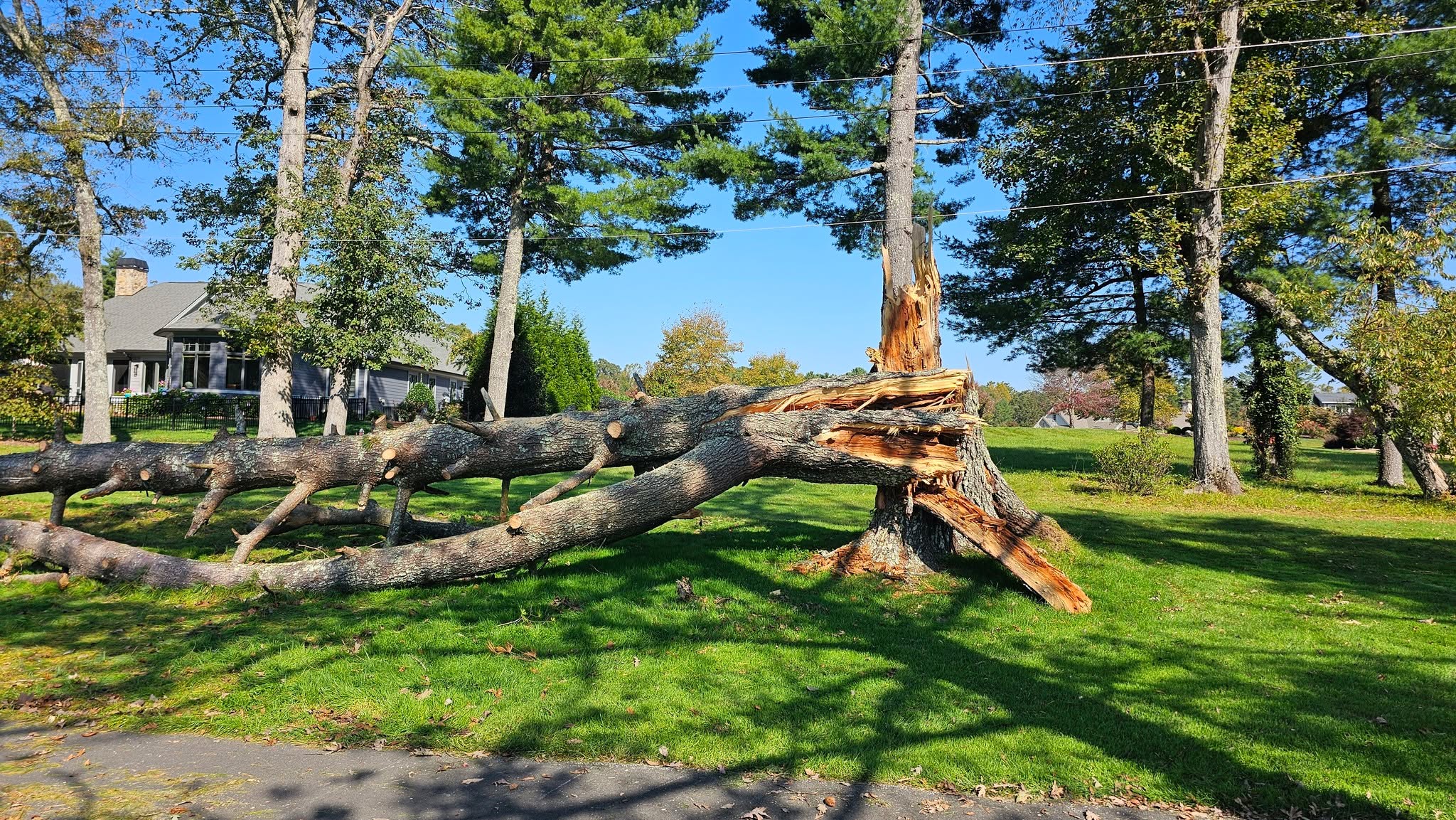

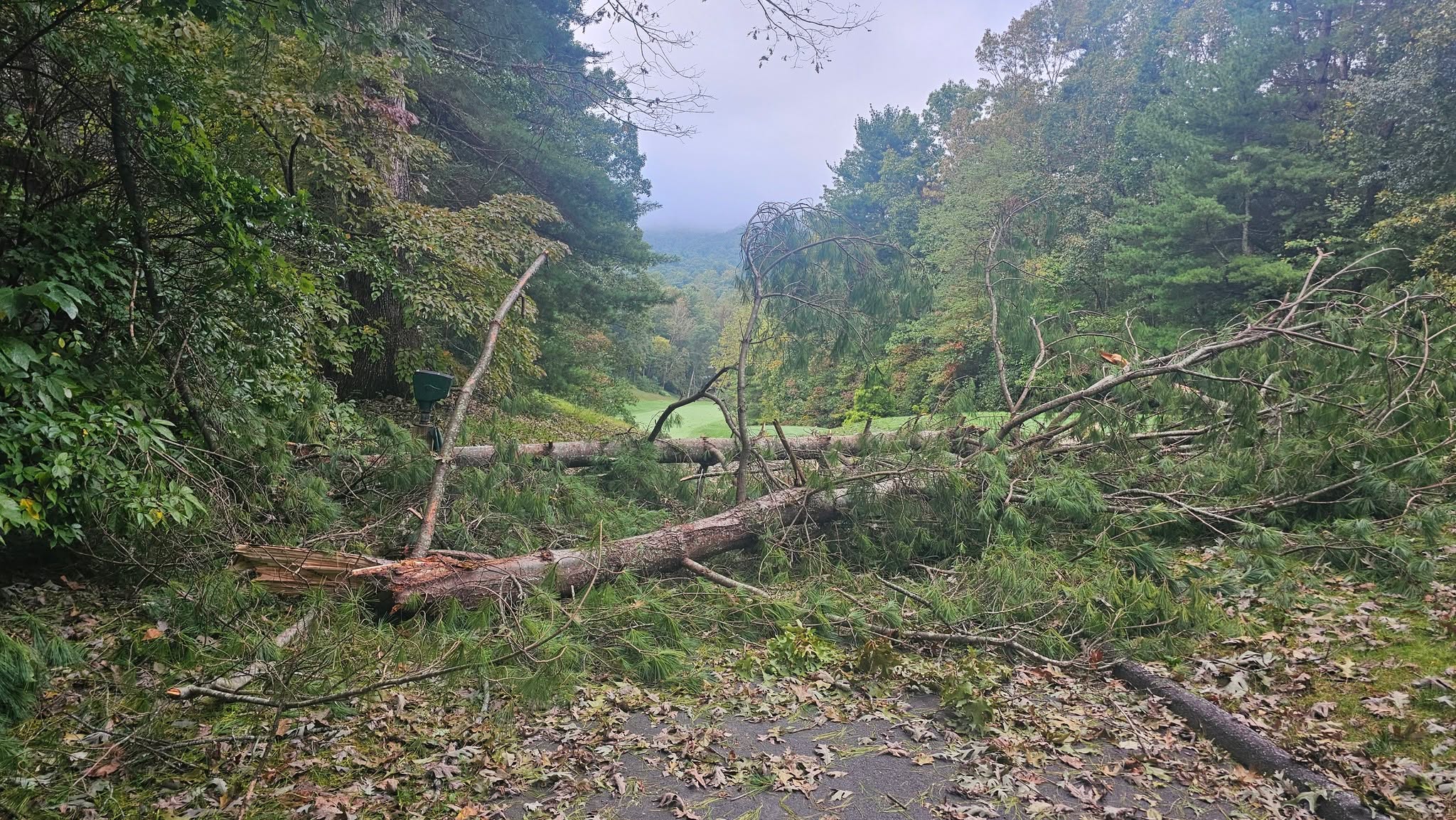

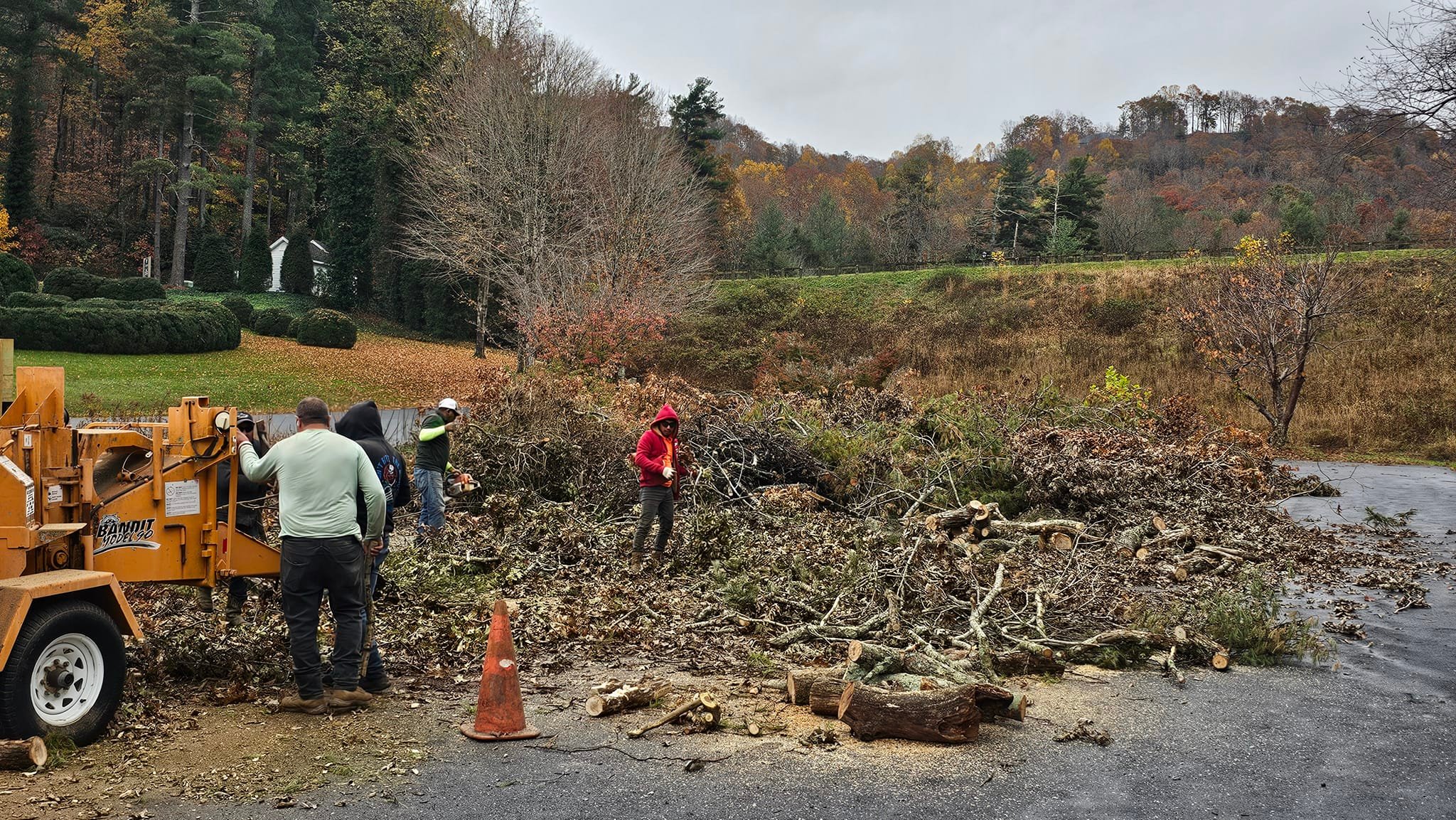

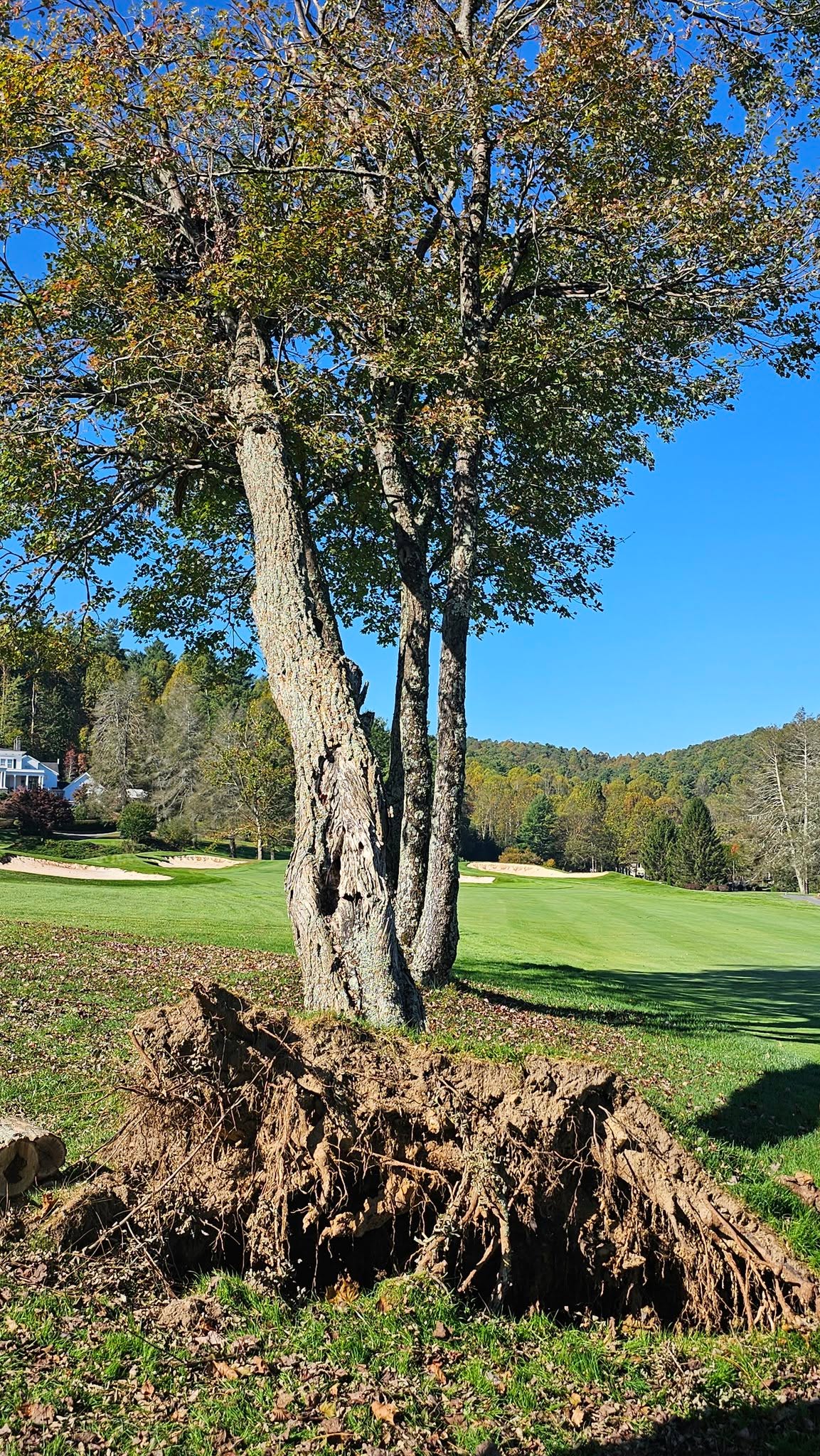

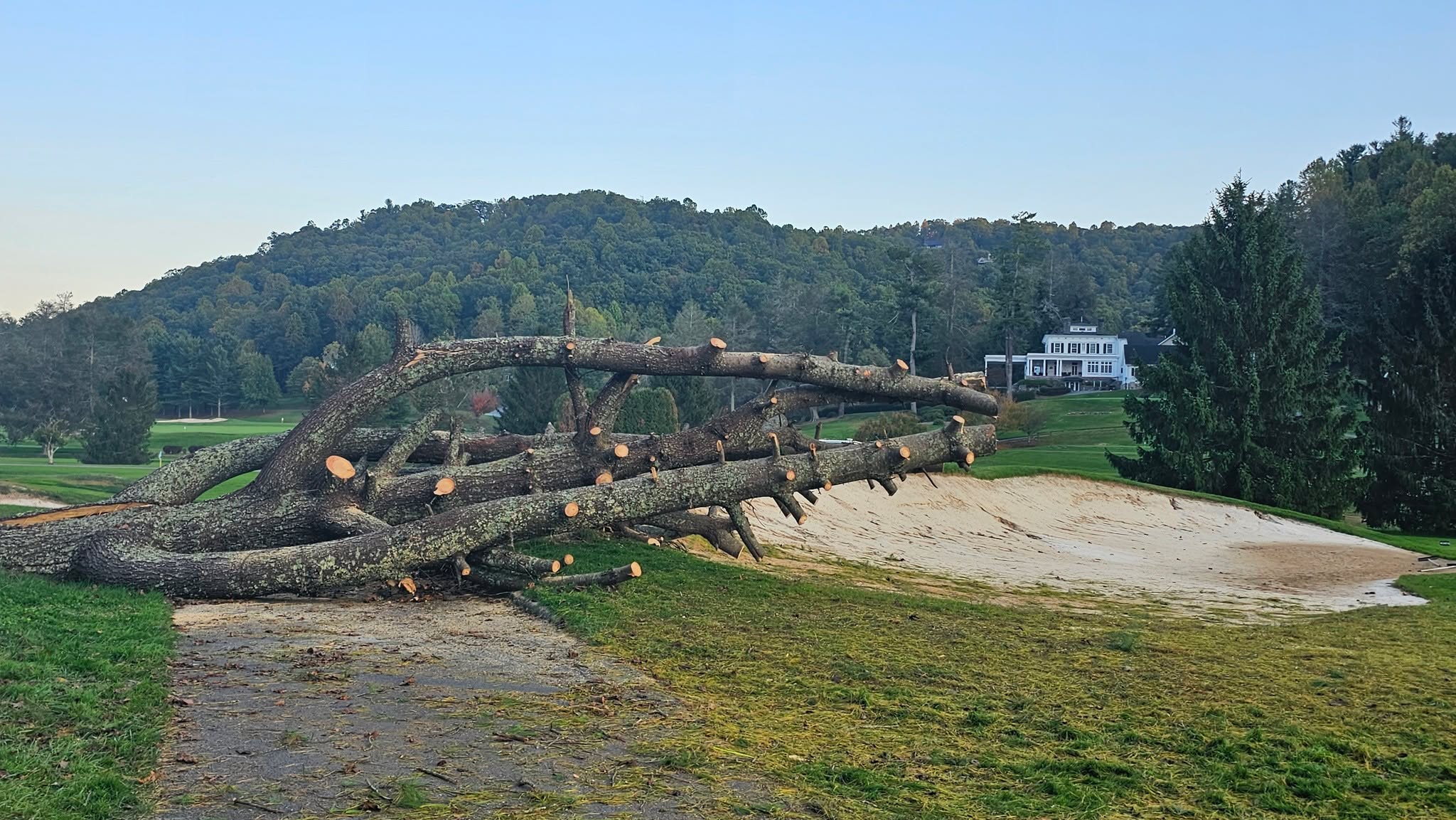

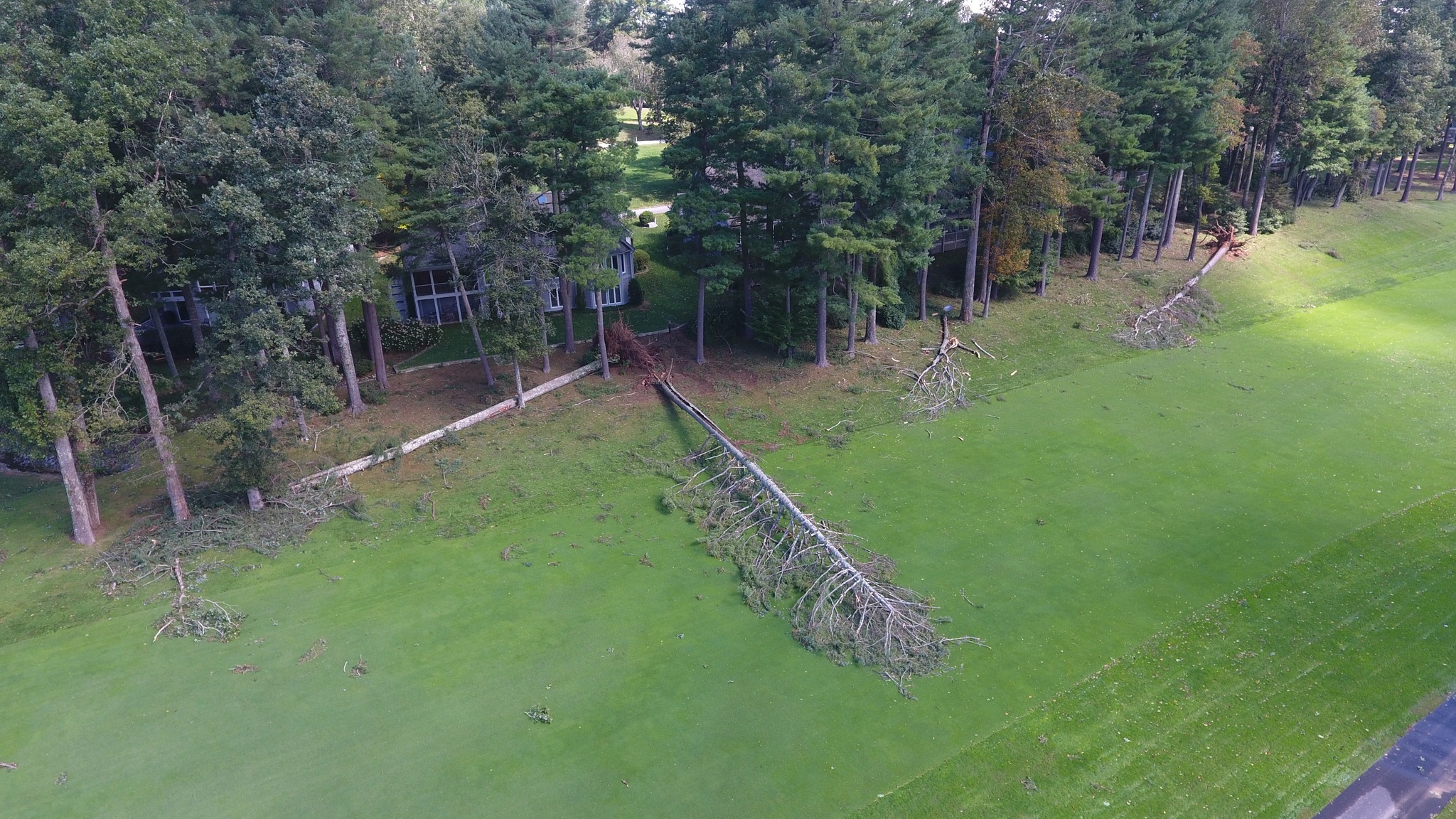

Debris cleanup was an ongoing effort throughout the winter. Several areas across the course received attention, and while significant progress has been made, there are still large stumps that we will remove this spring. Additionally, the large pile of logs on hole #17 will be removed soon, along with a few trees along the creek near the fitness center. There are also snags and trees along Kenmure Drive and a large piece hung up near hole #6 that need removal. Our tree company has been assisting and will continue in the coming months as their schedule allows.
Drainage Improvements

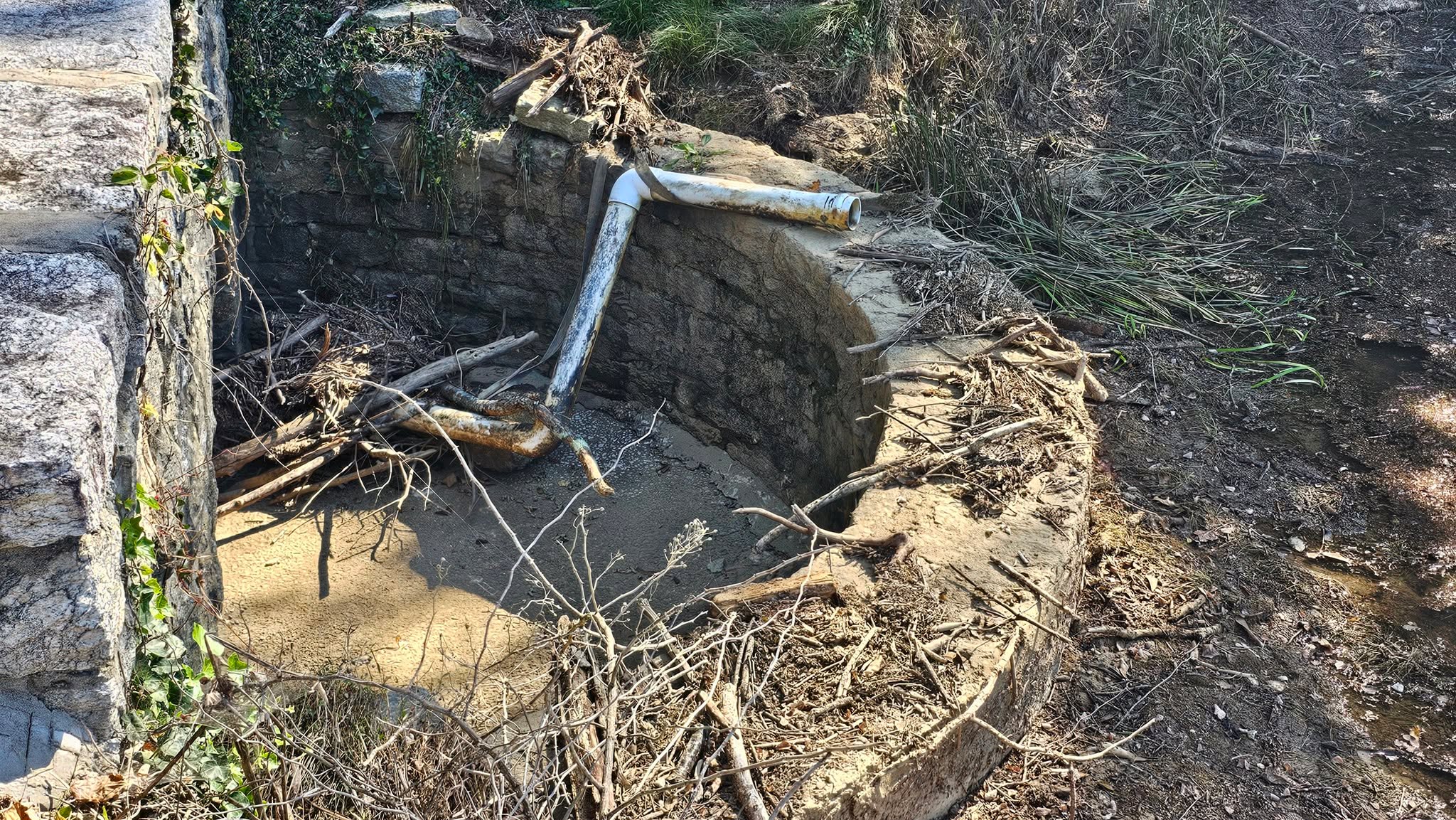

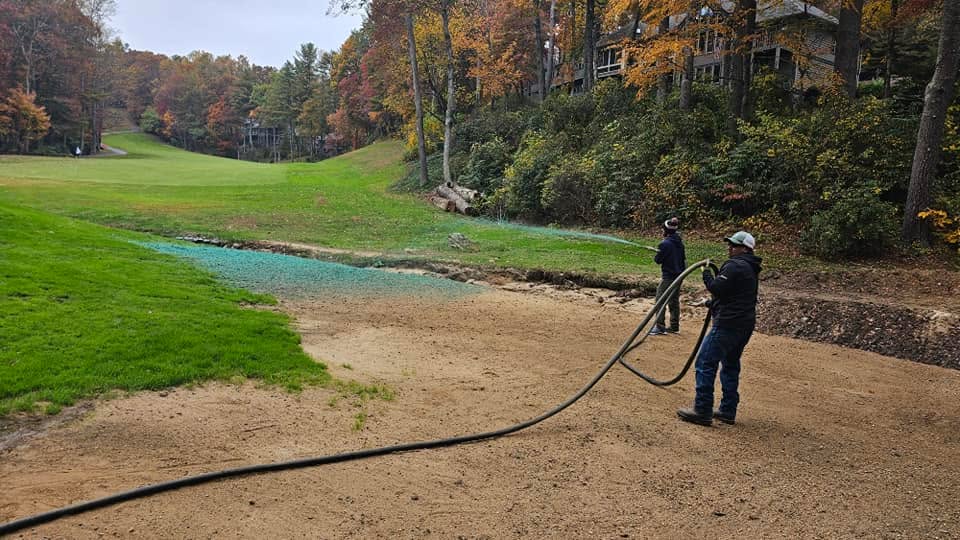

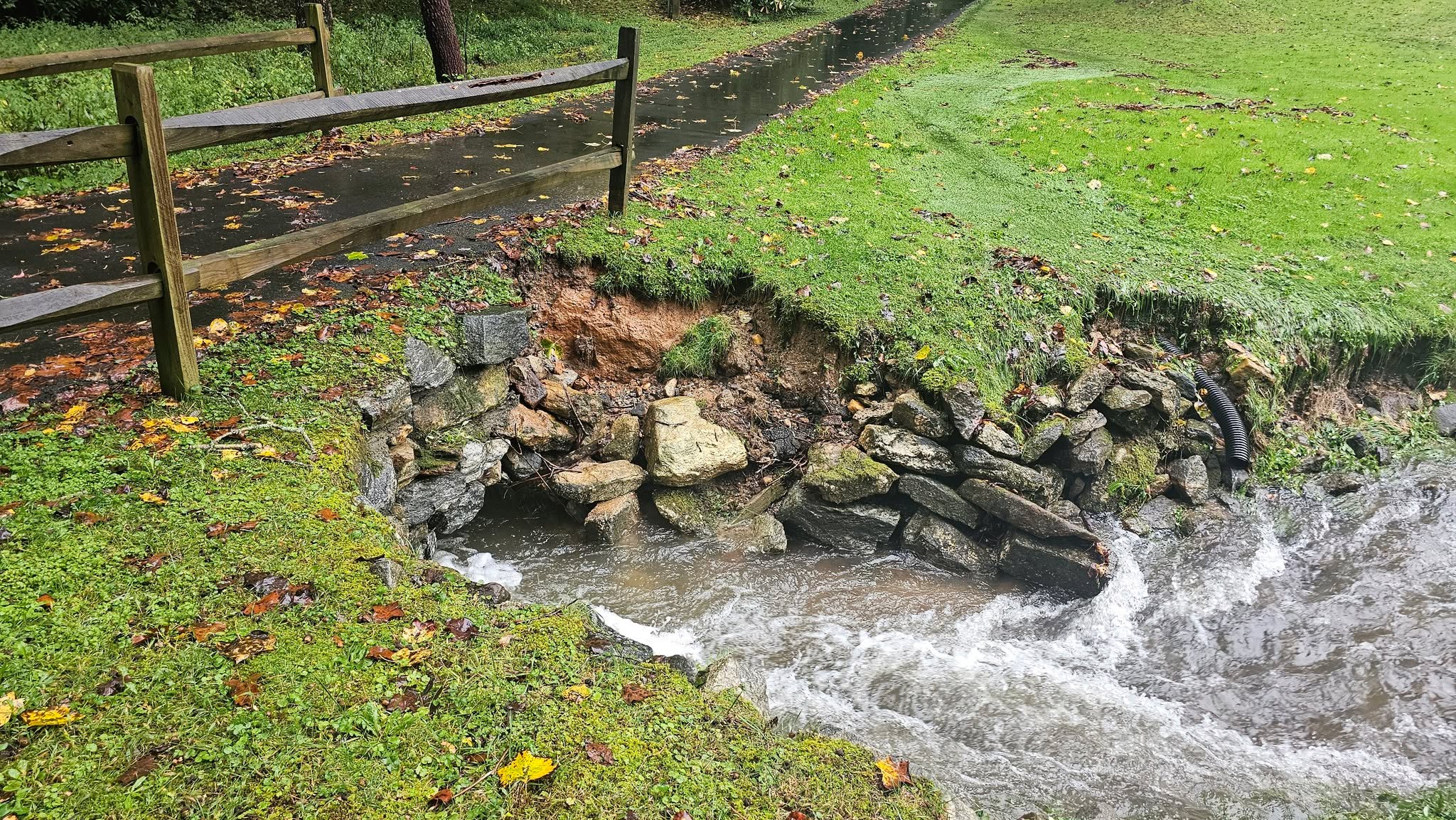

Each year, we address troublesome wet spots. This winter, we discovered a wet-weather spring on hole #4 fairway and took measures to mitigate its impact. Our repairs should be effective for a couple of seasons, though a permanent fix would require extensive drainage work. Additionally, we resolved recurring puddling issues further up the fairway.

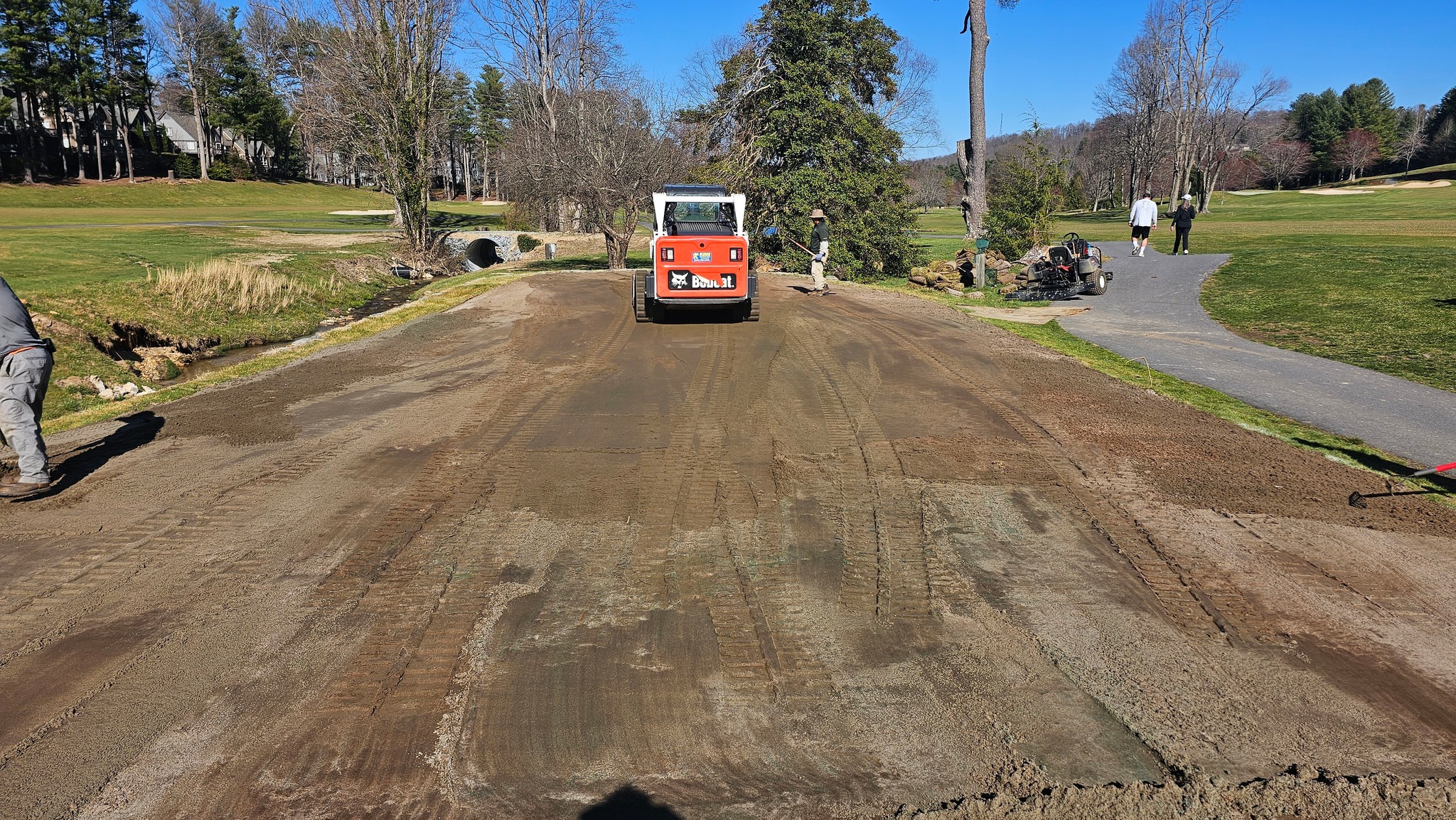

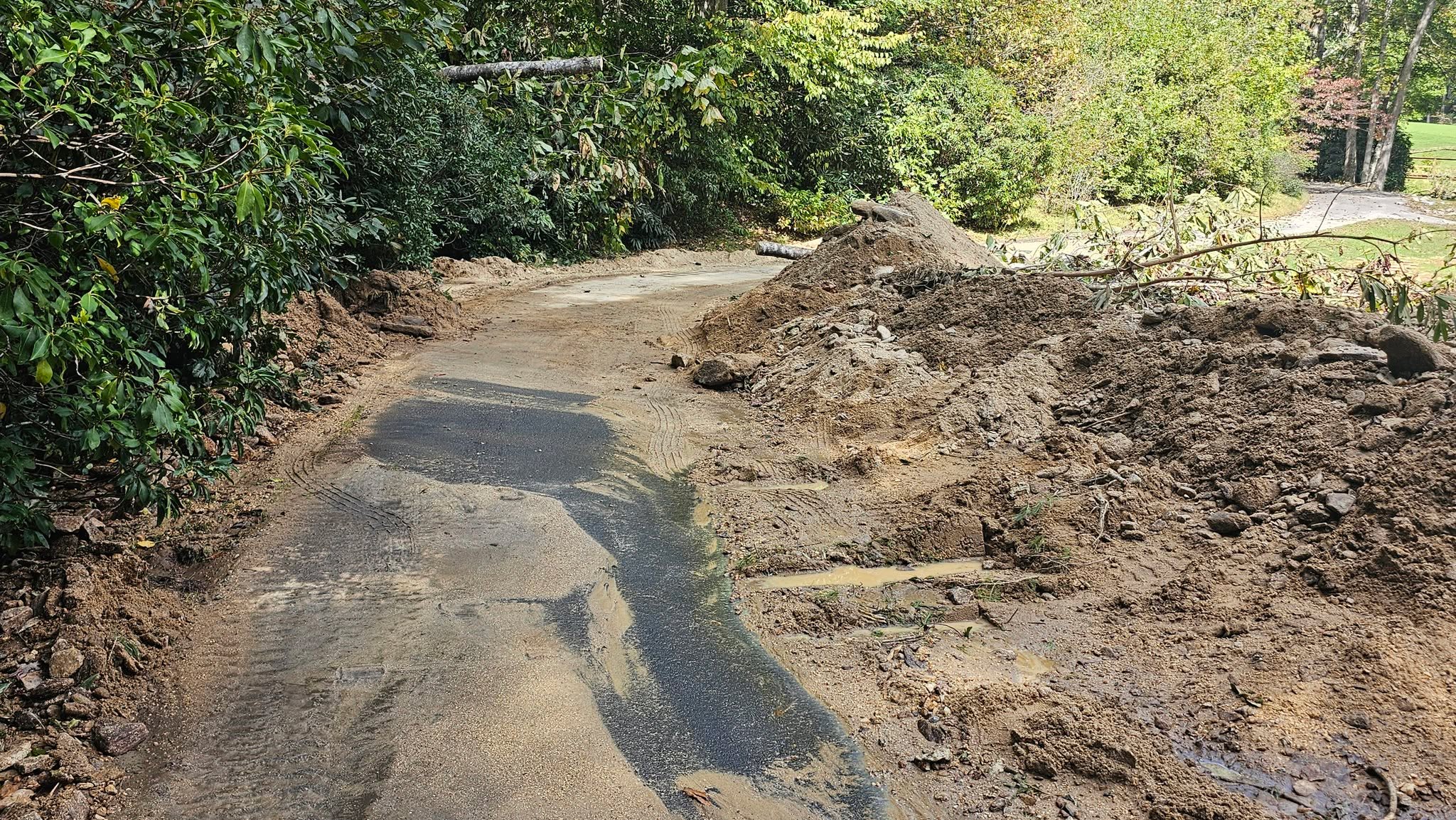

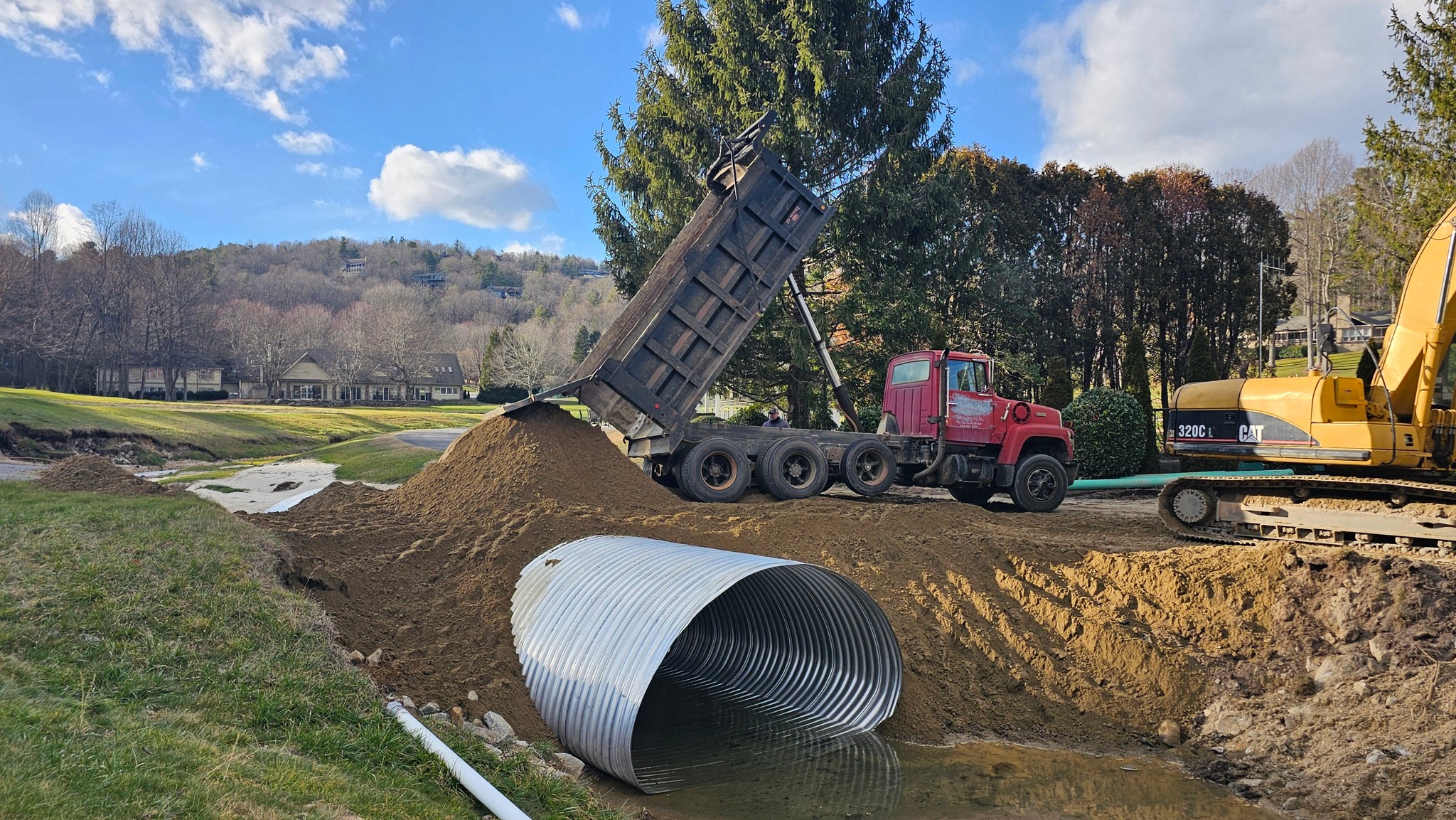

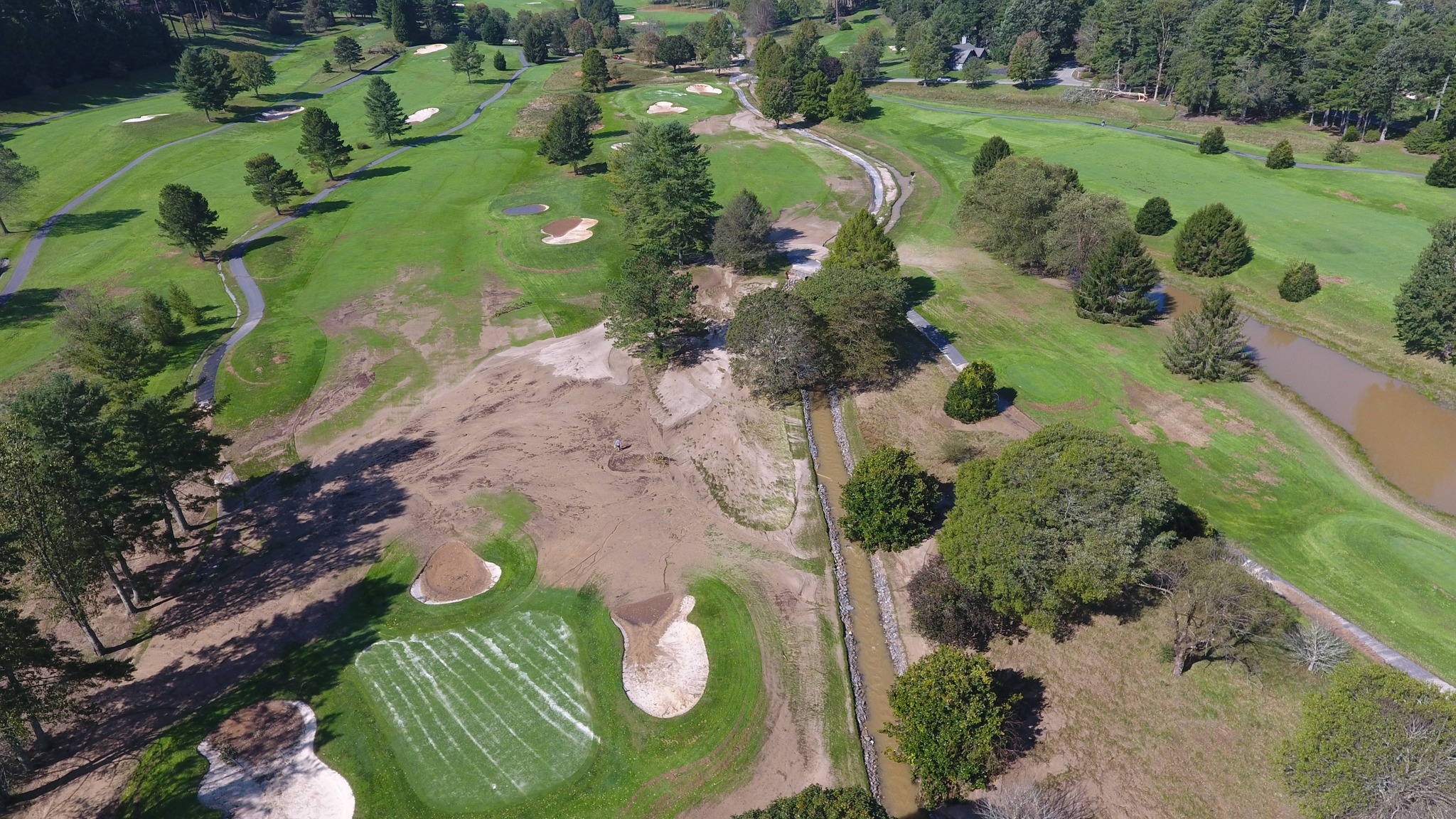

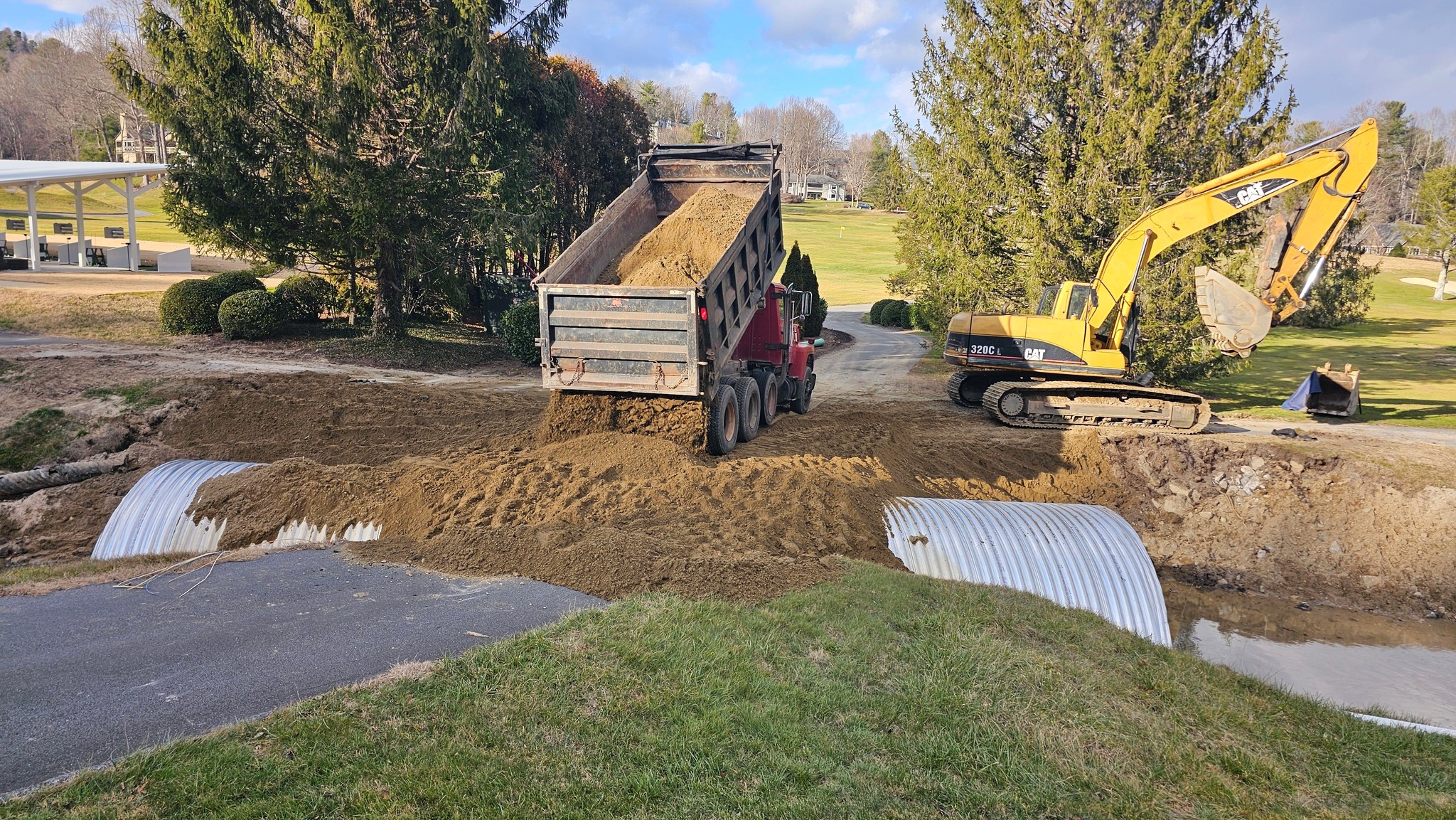

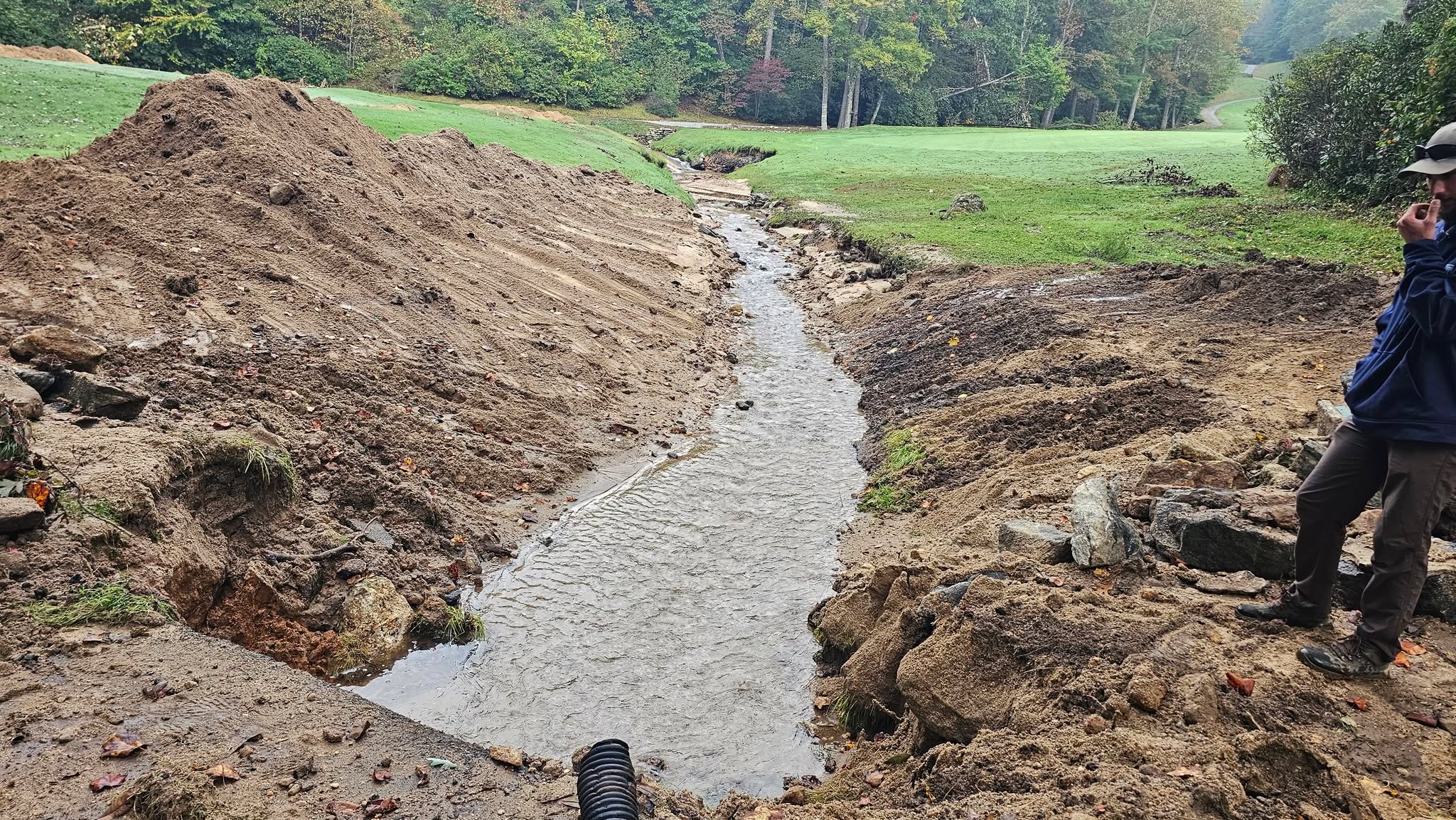

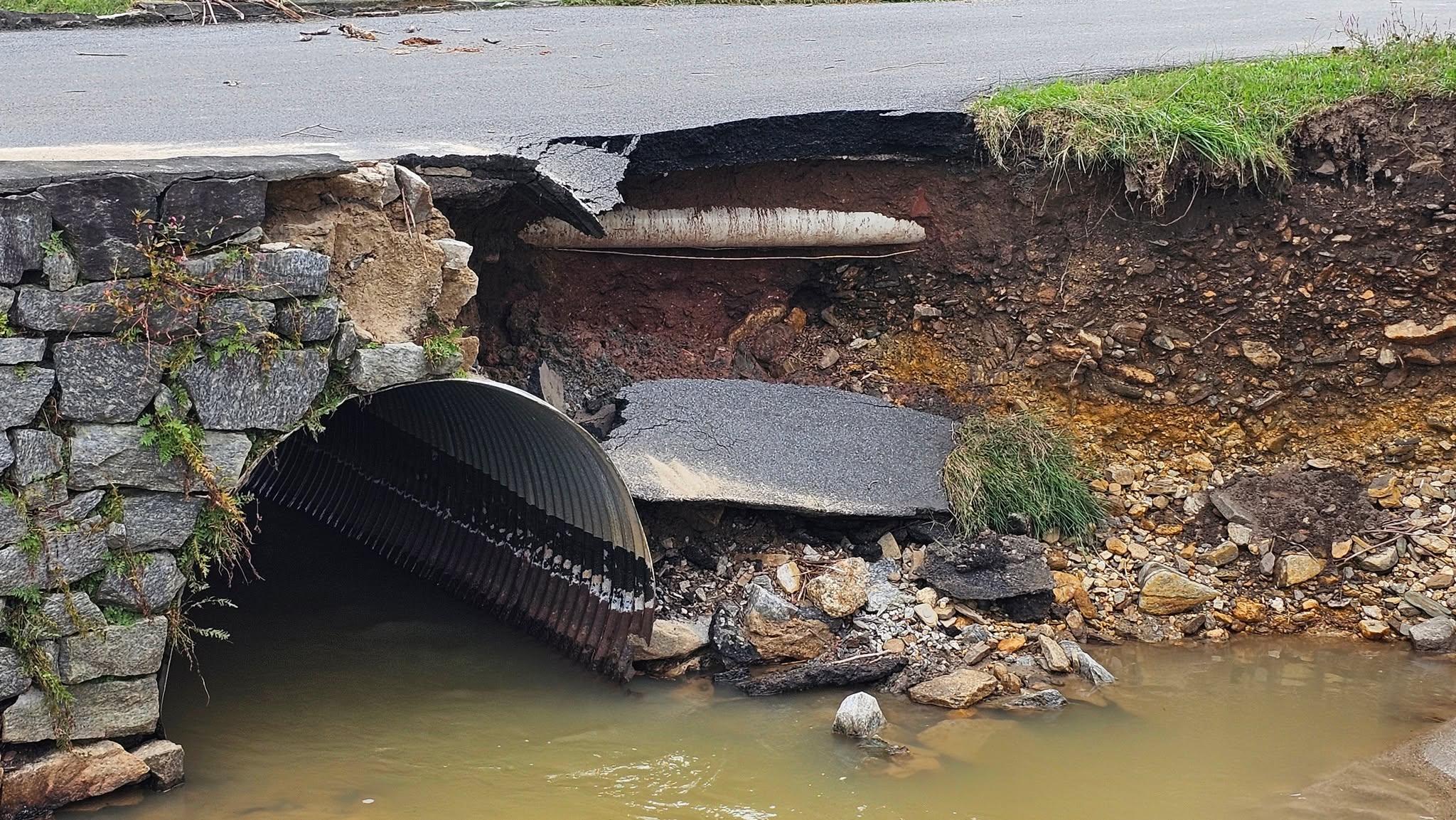

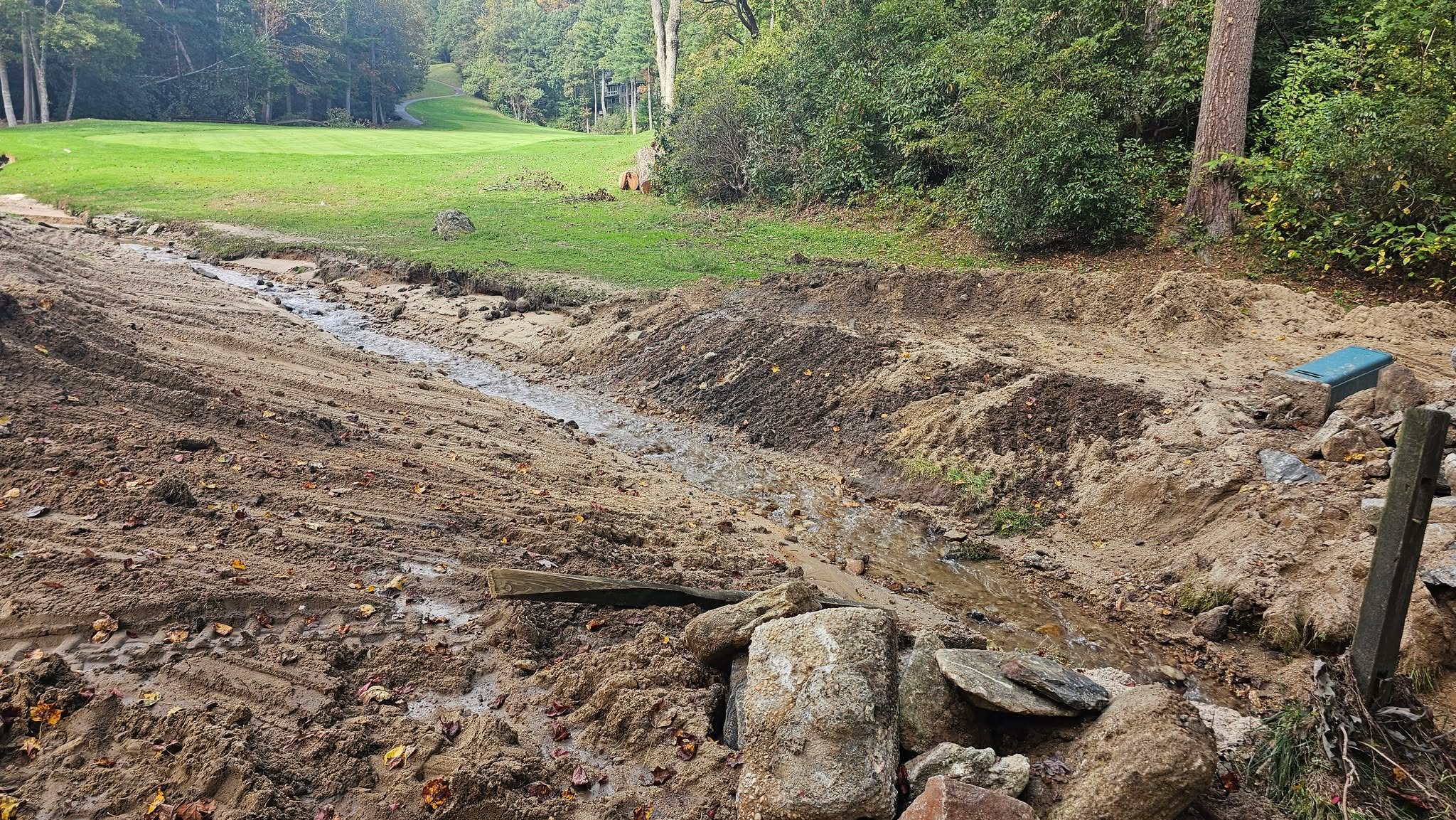

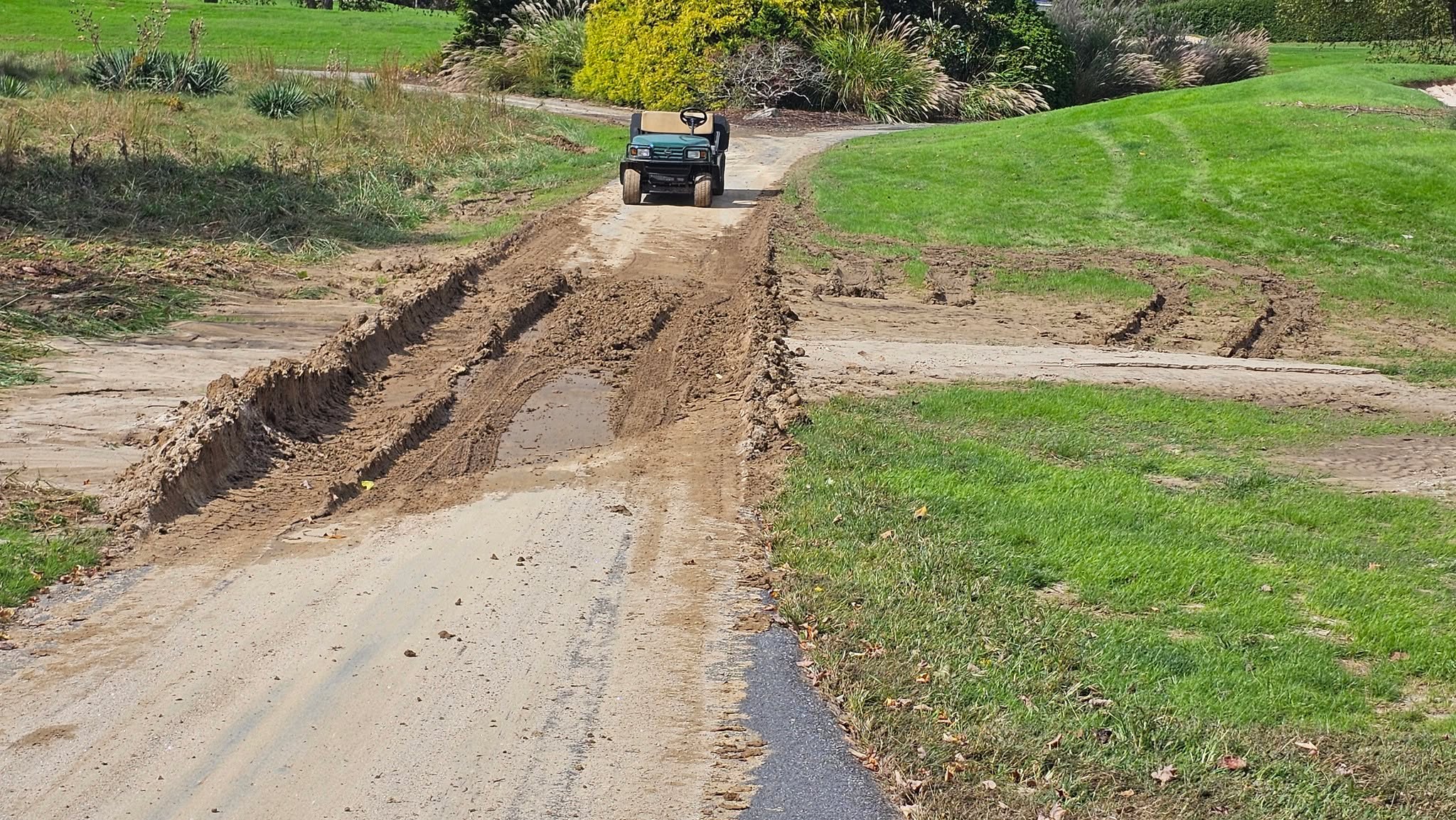

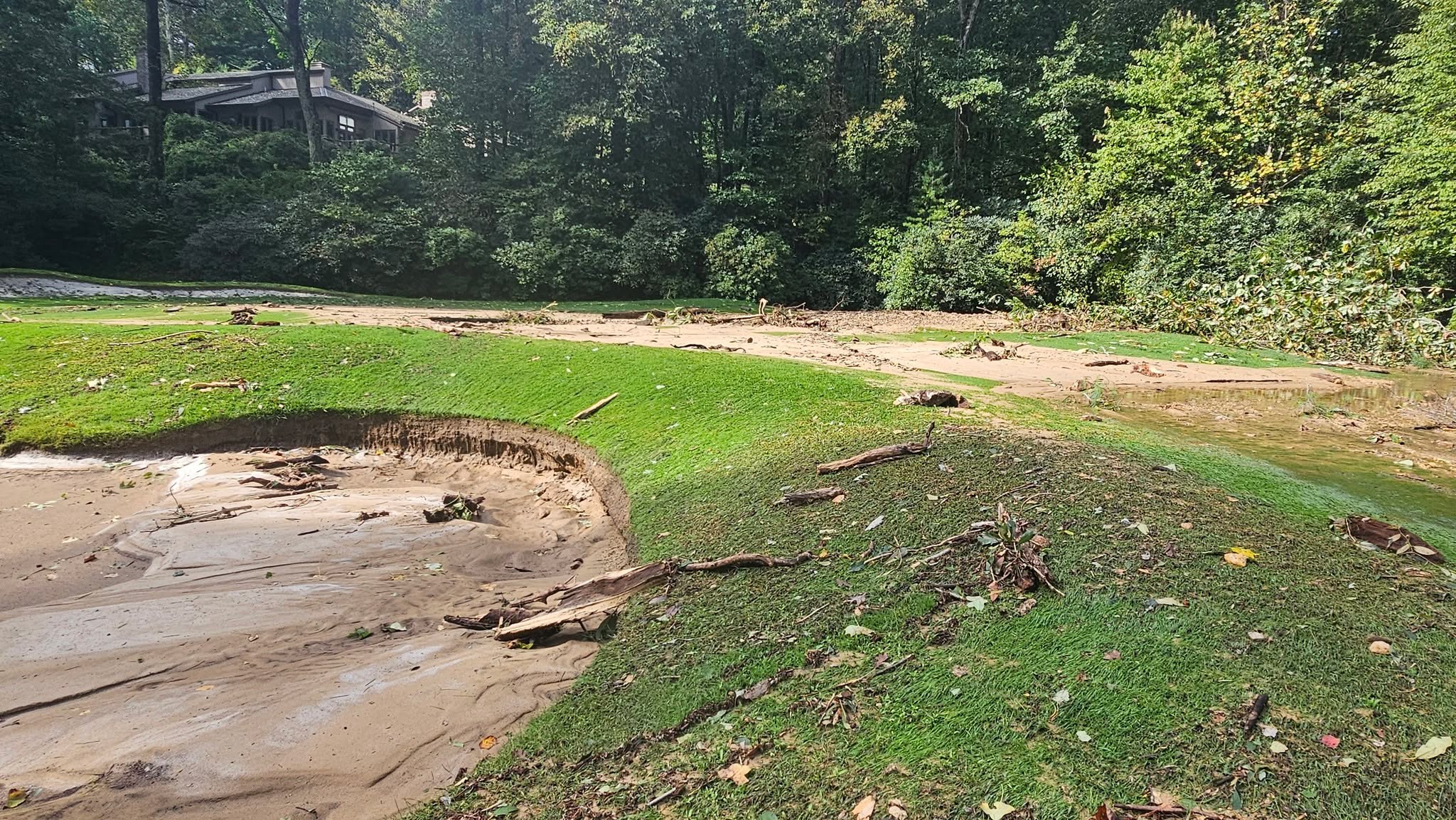

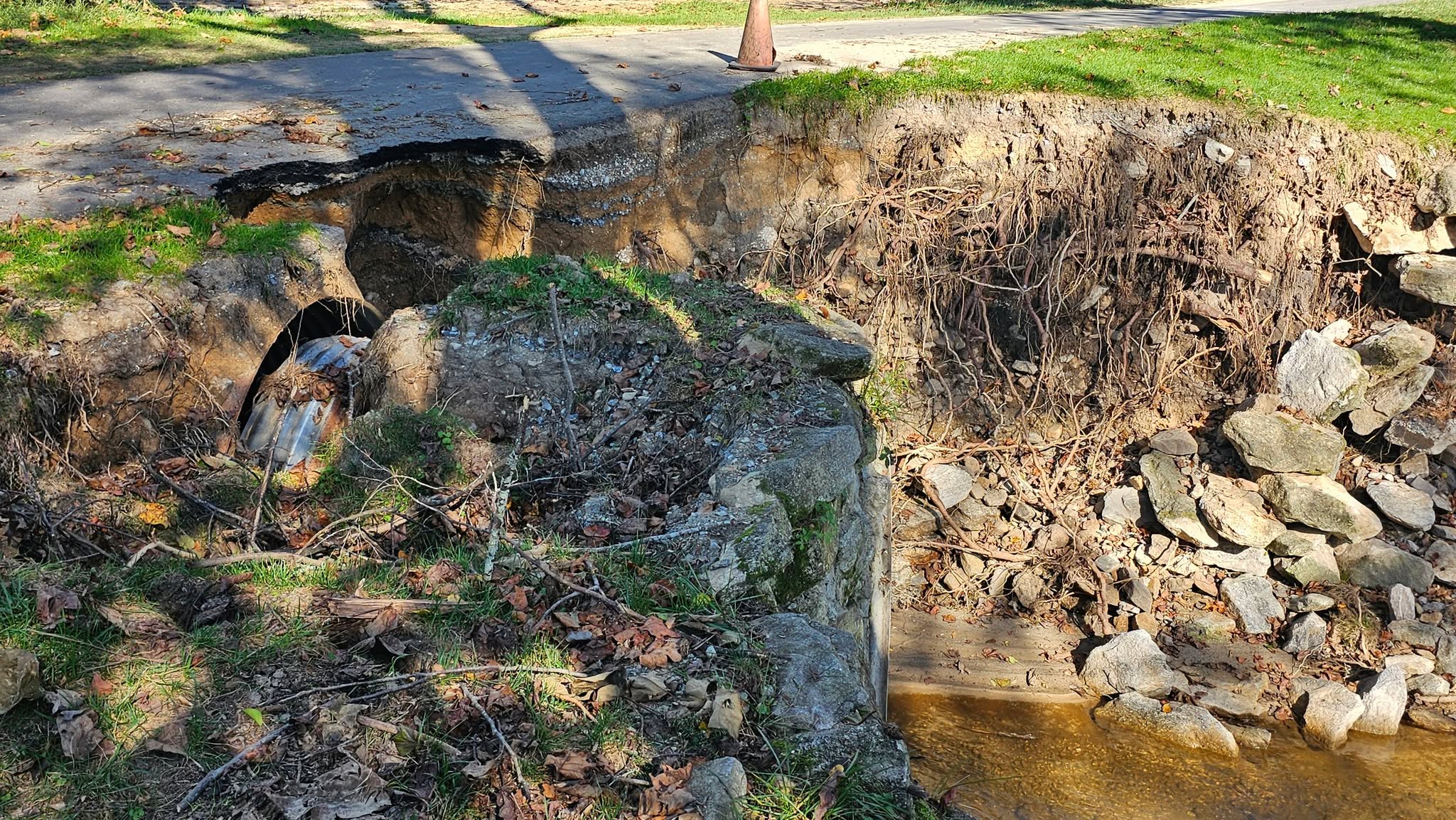

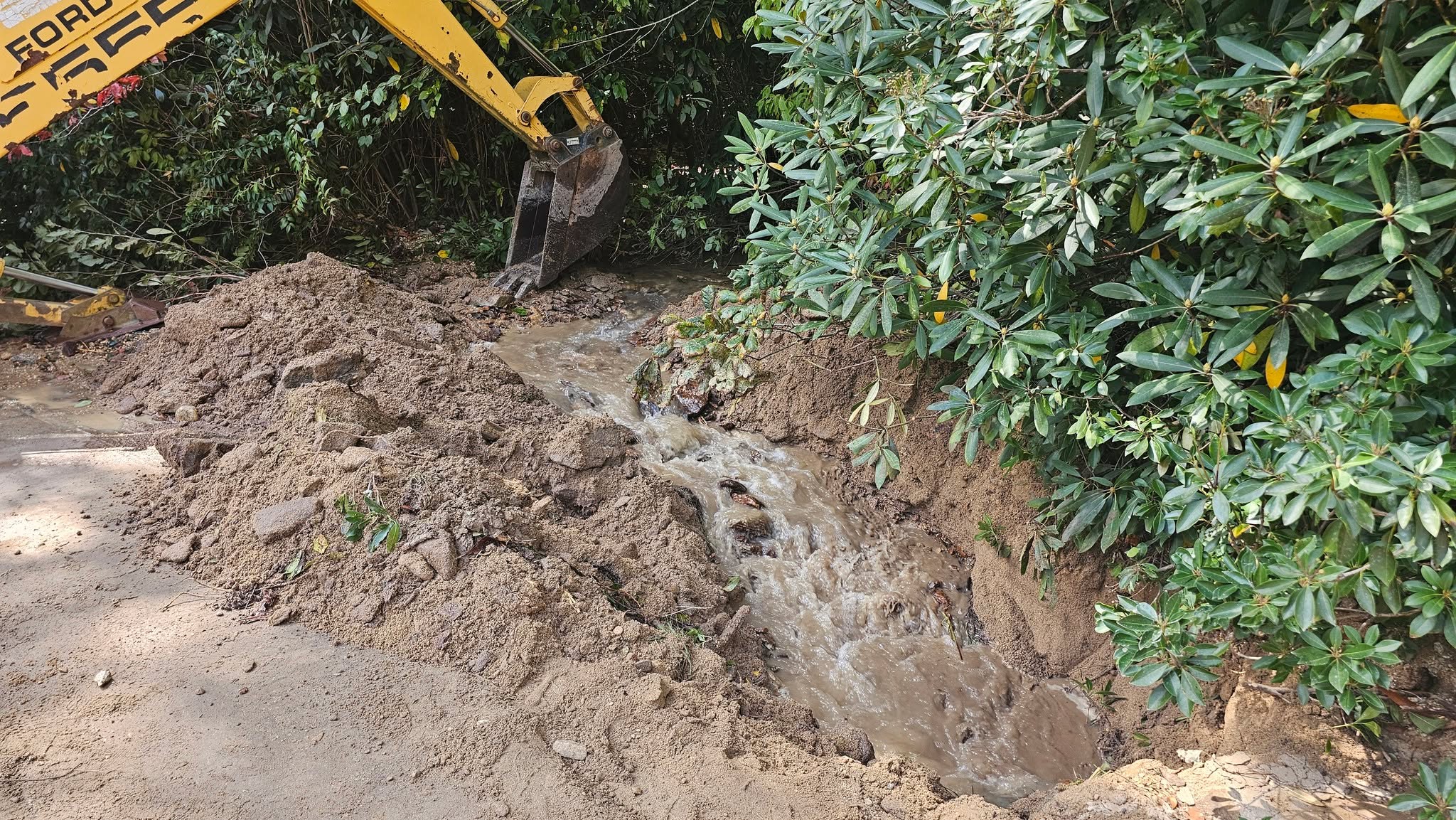

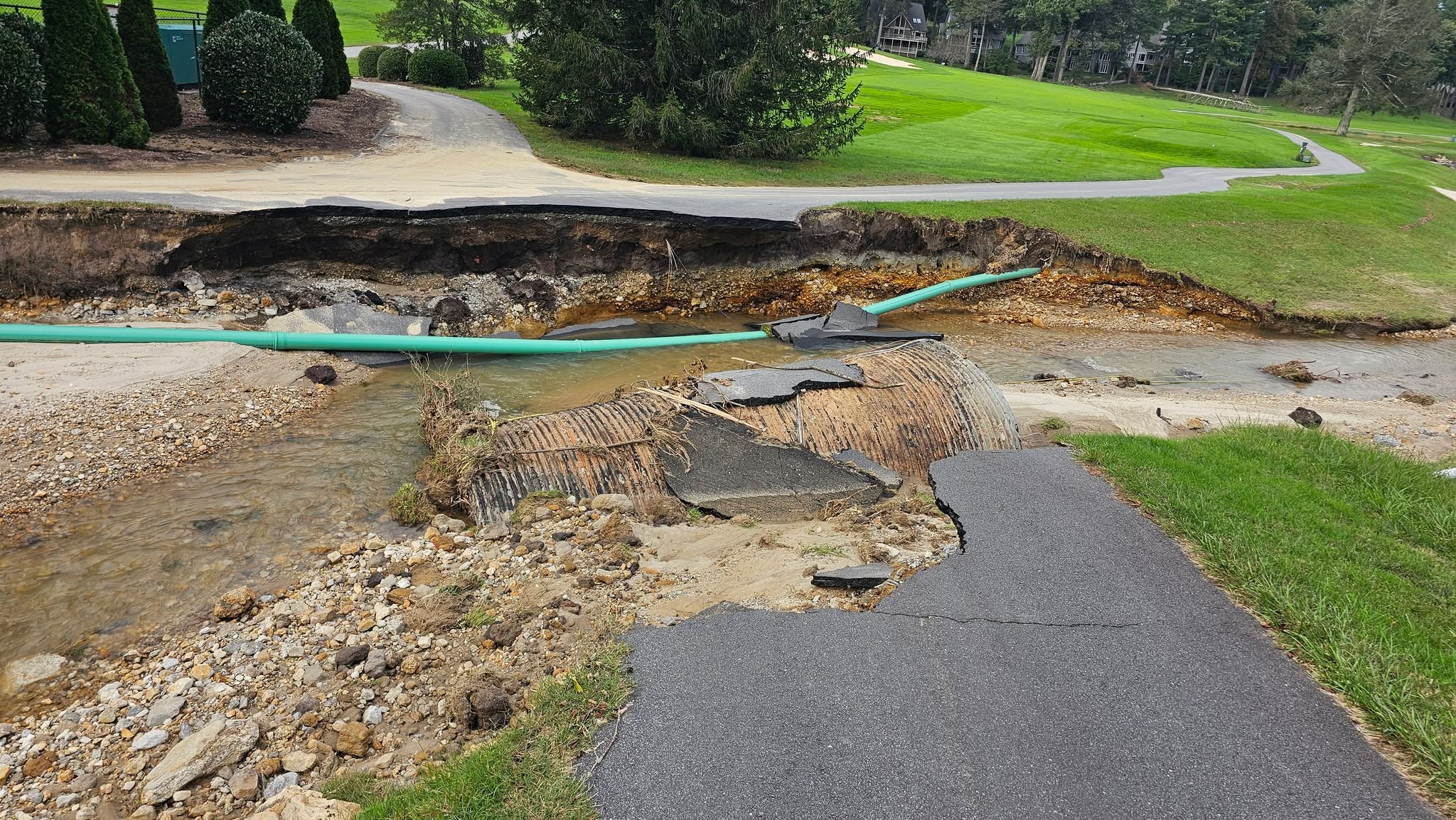

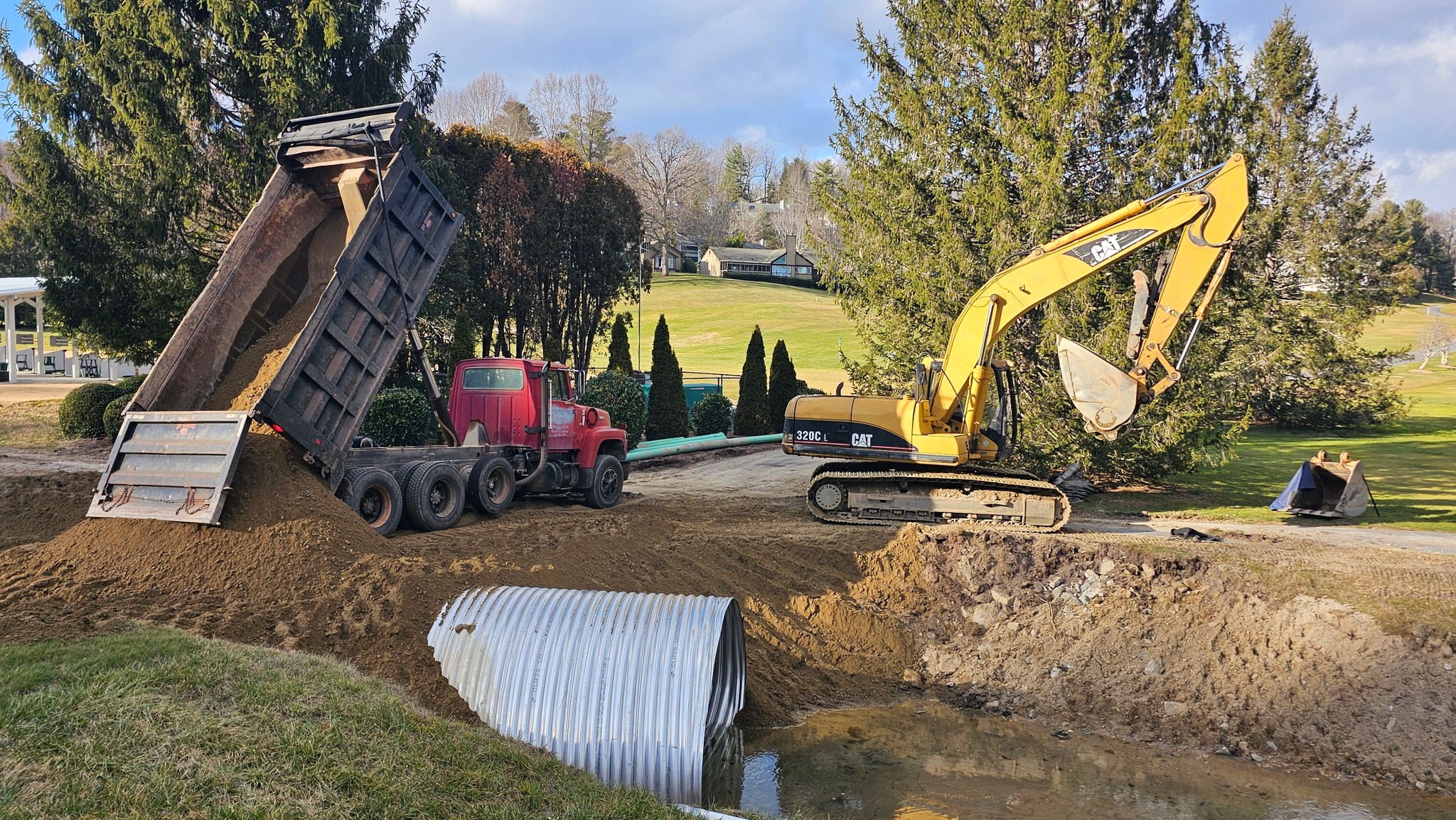

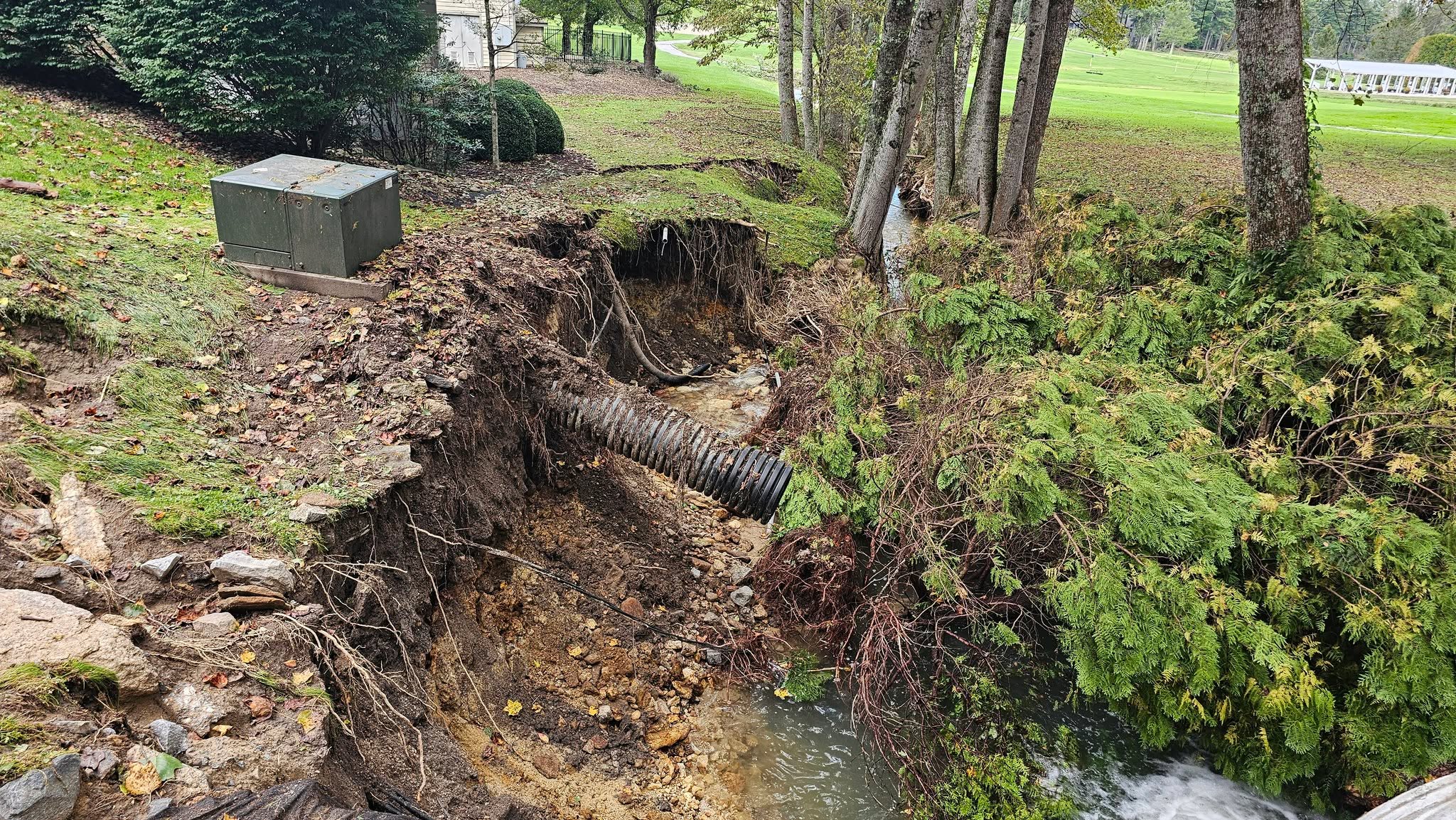

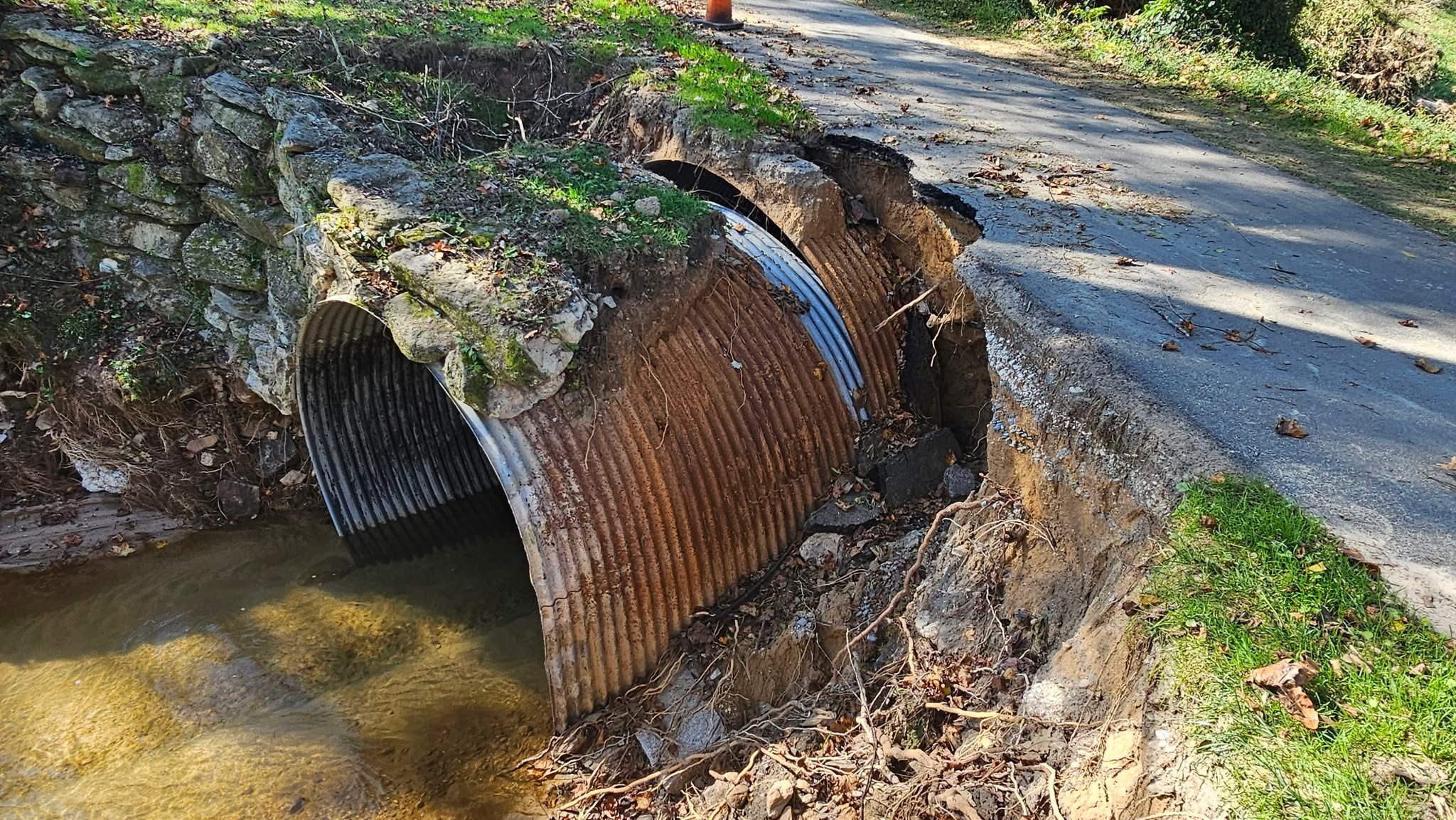

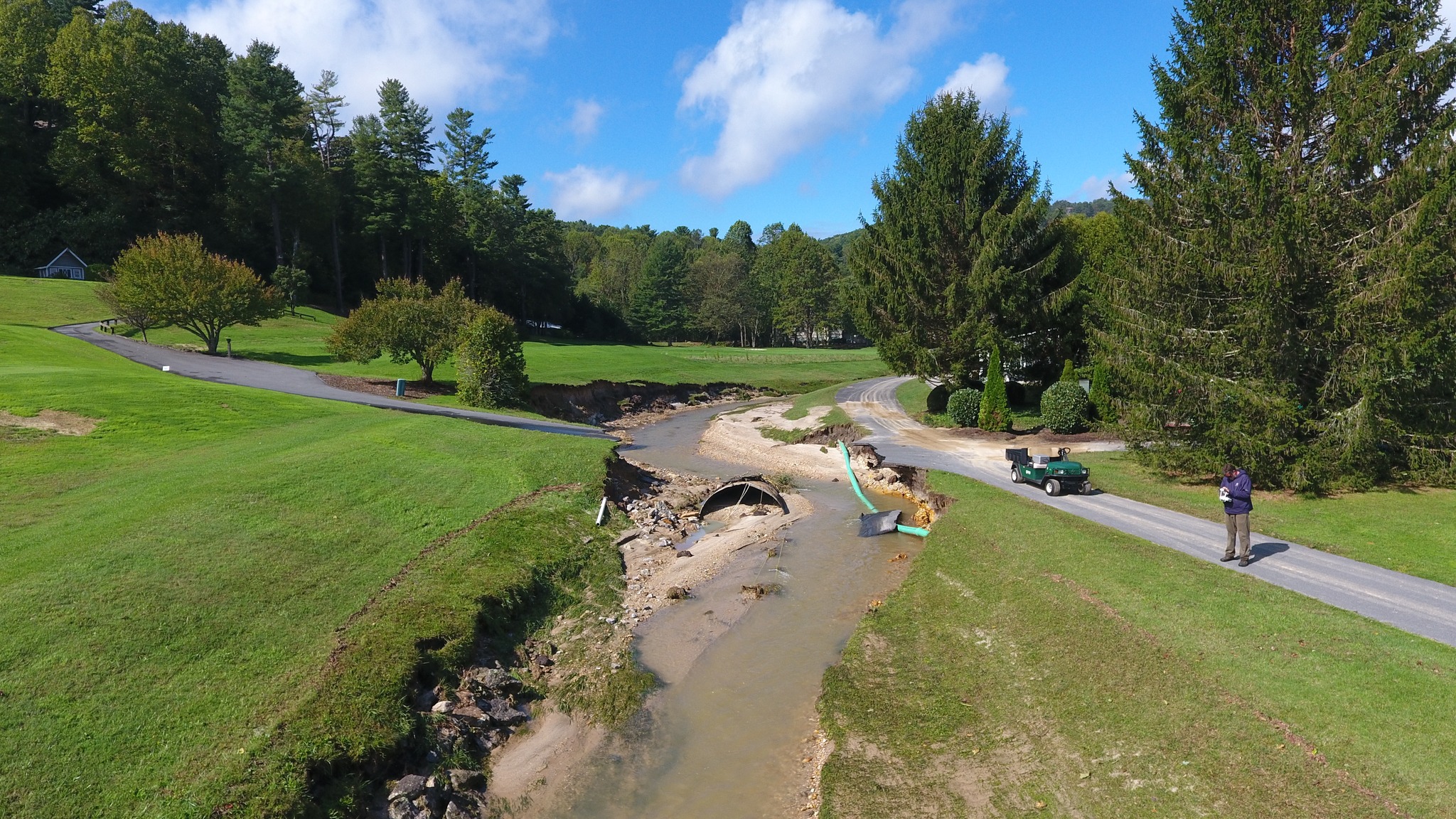

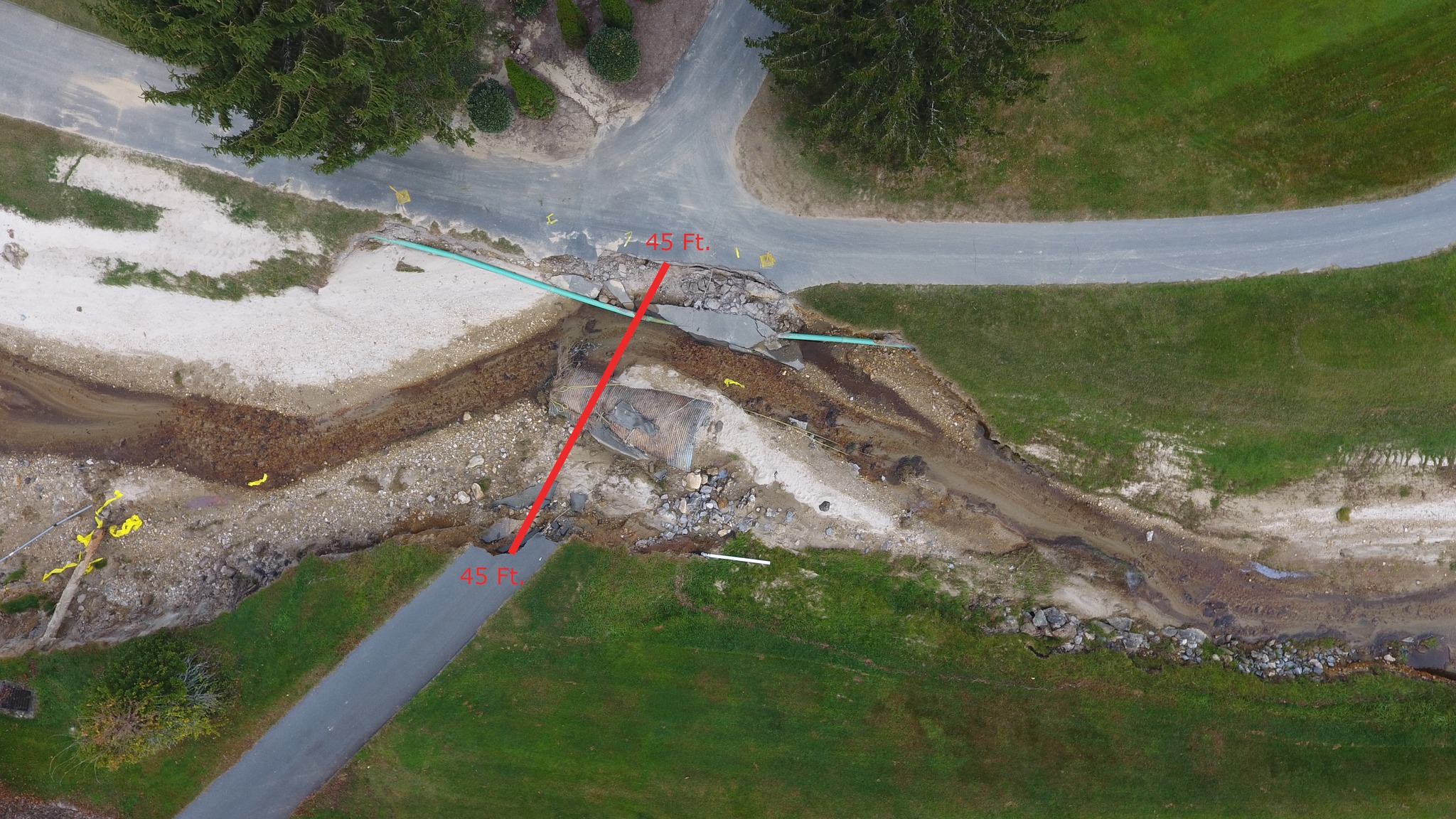

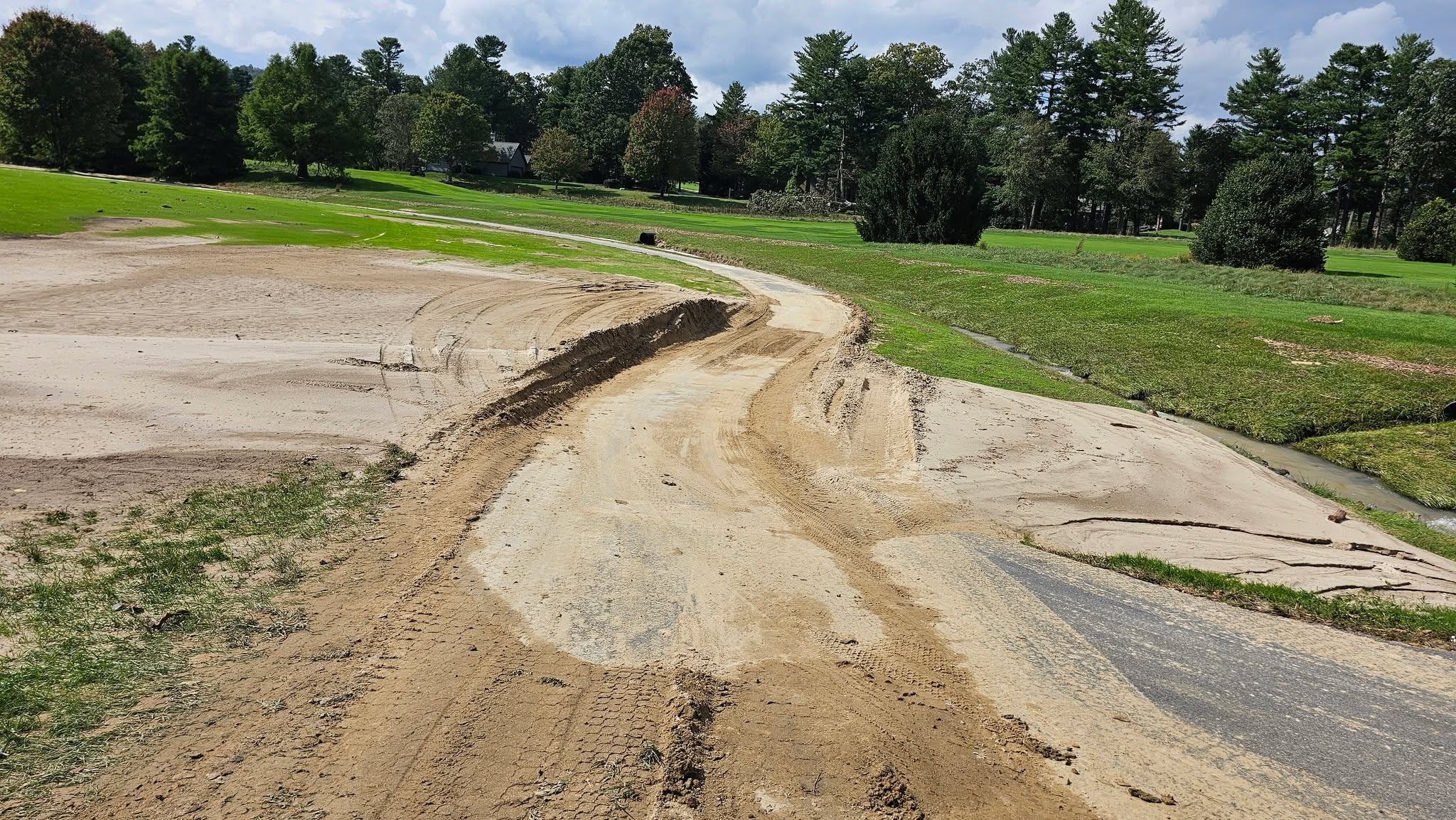

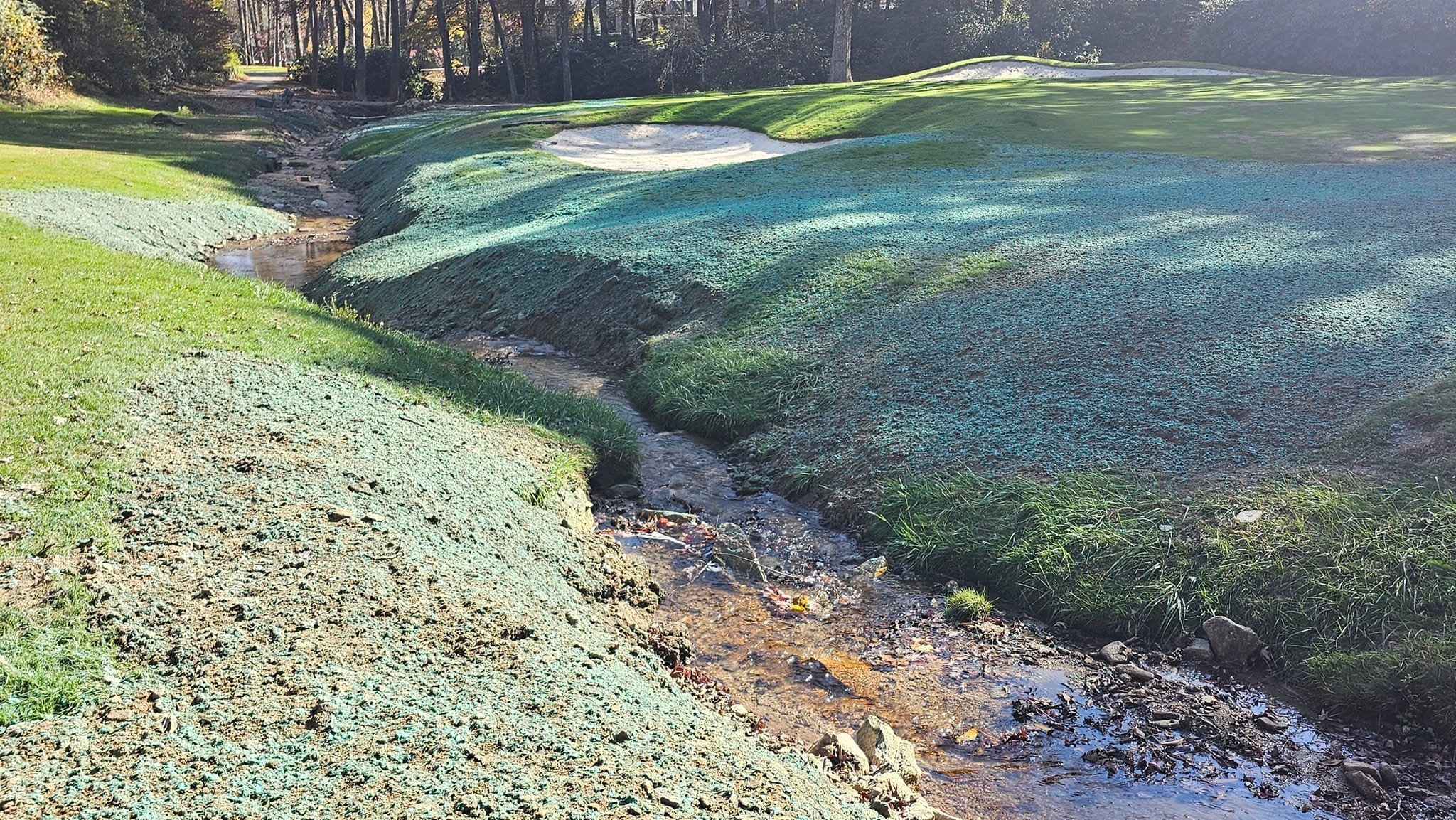

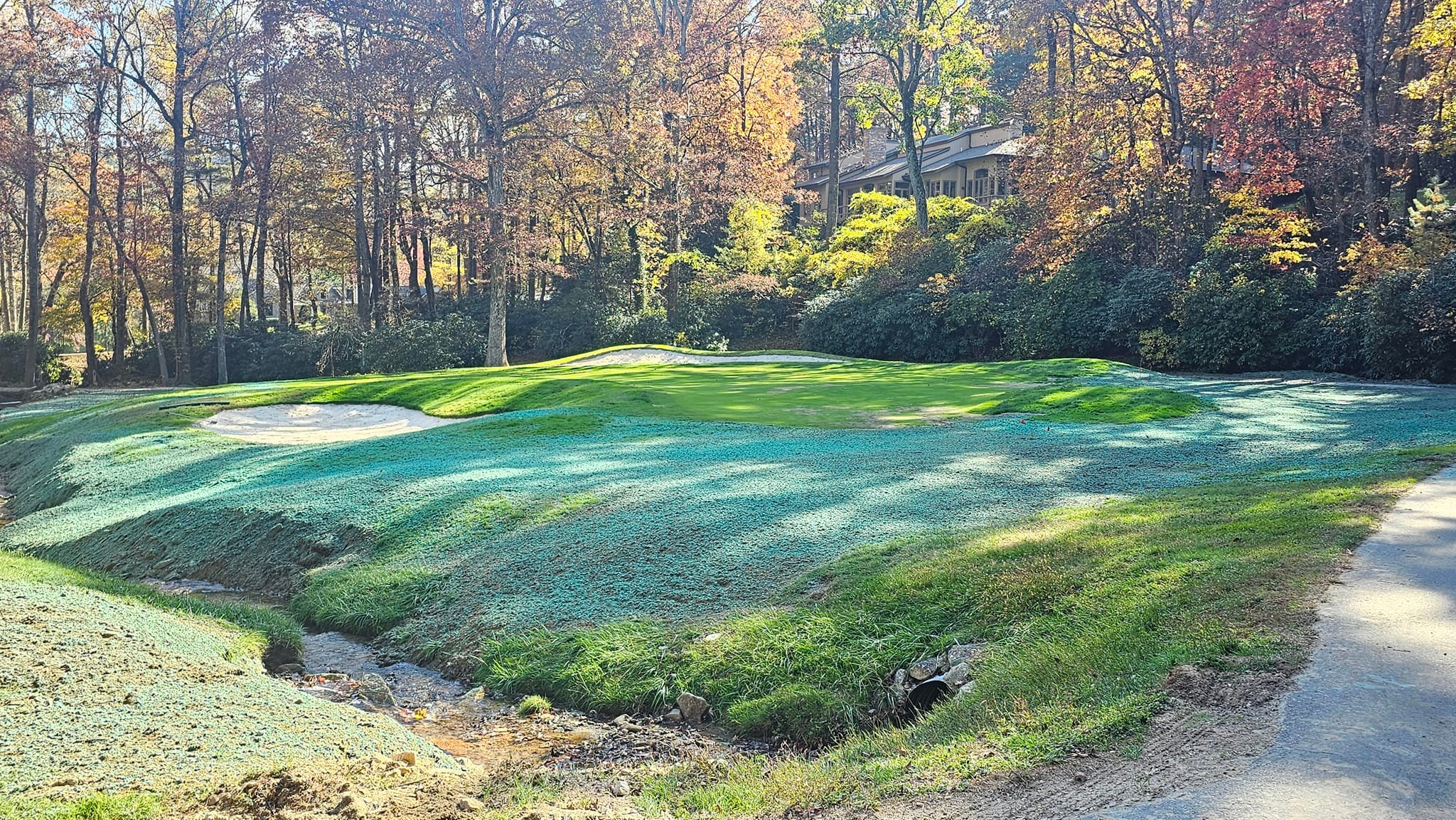

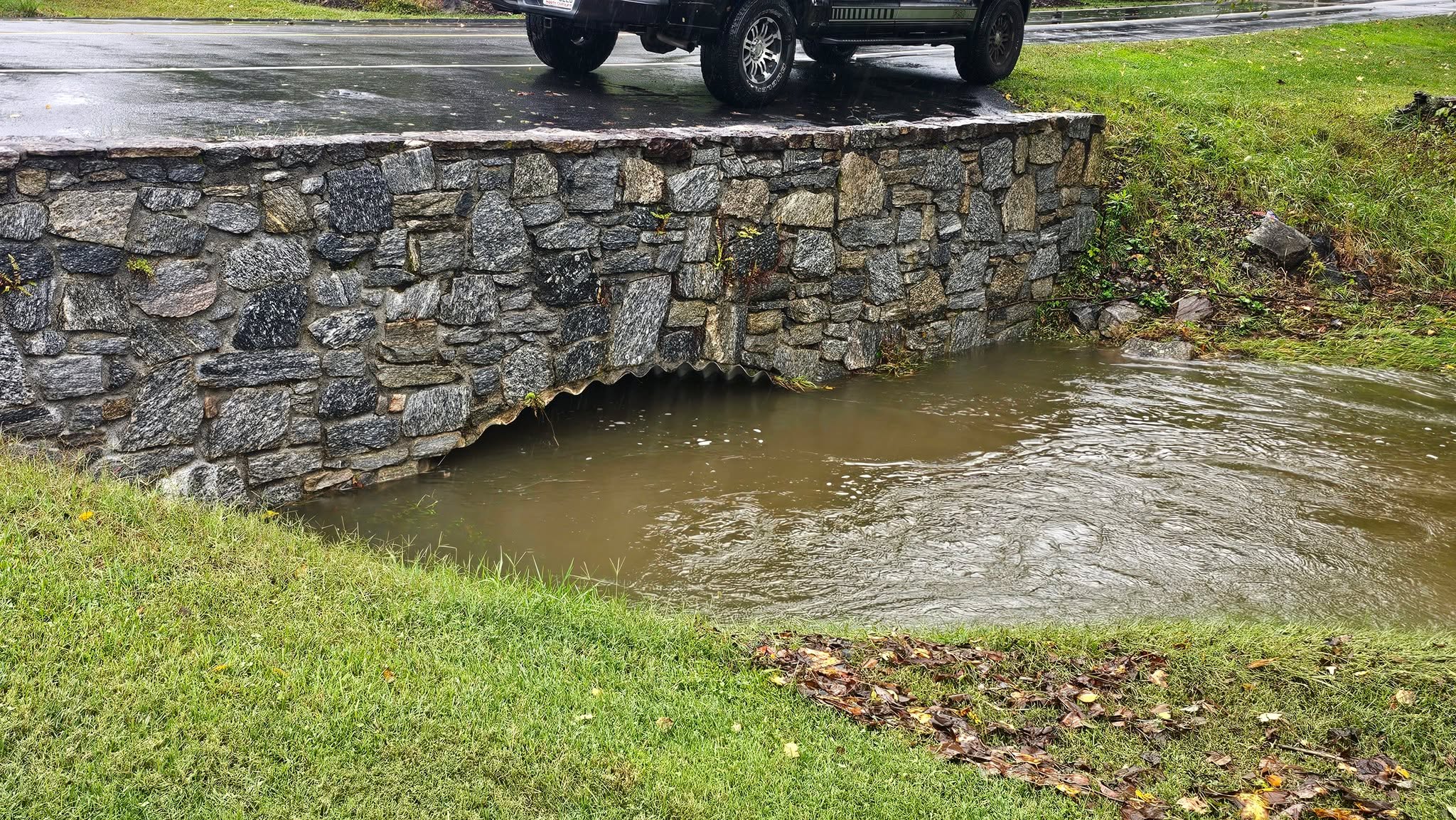

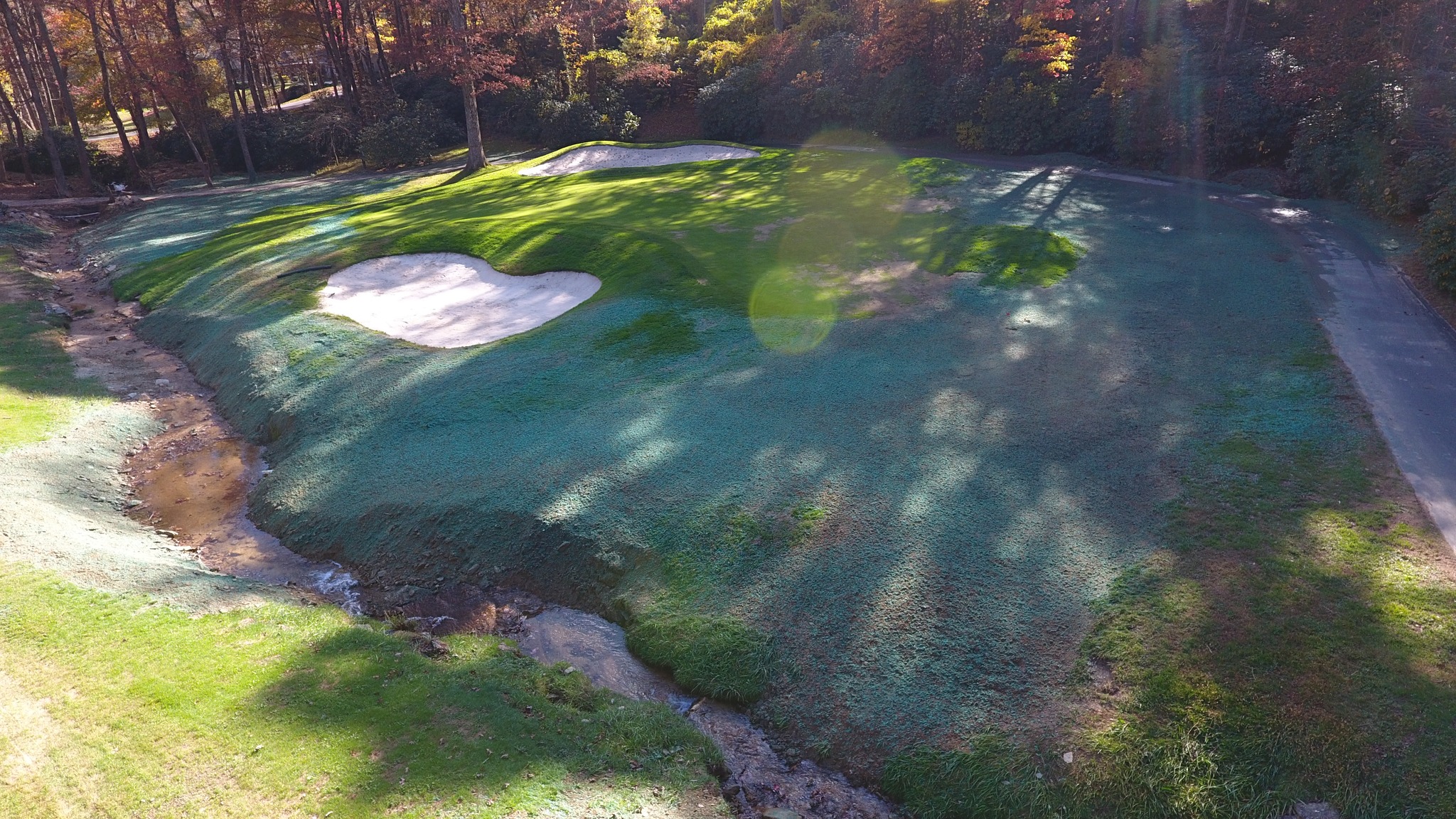

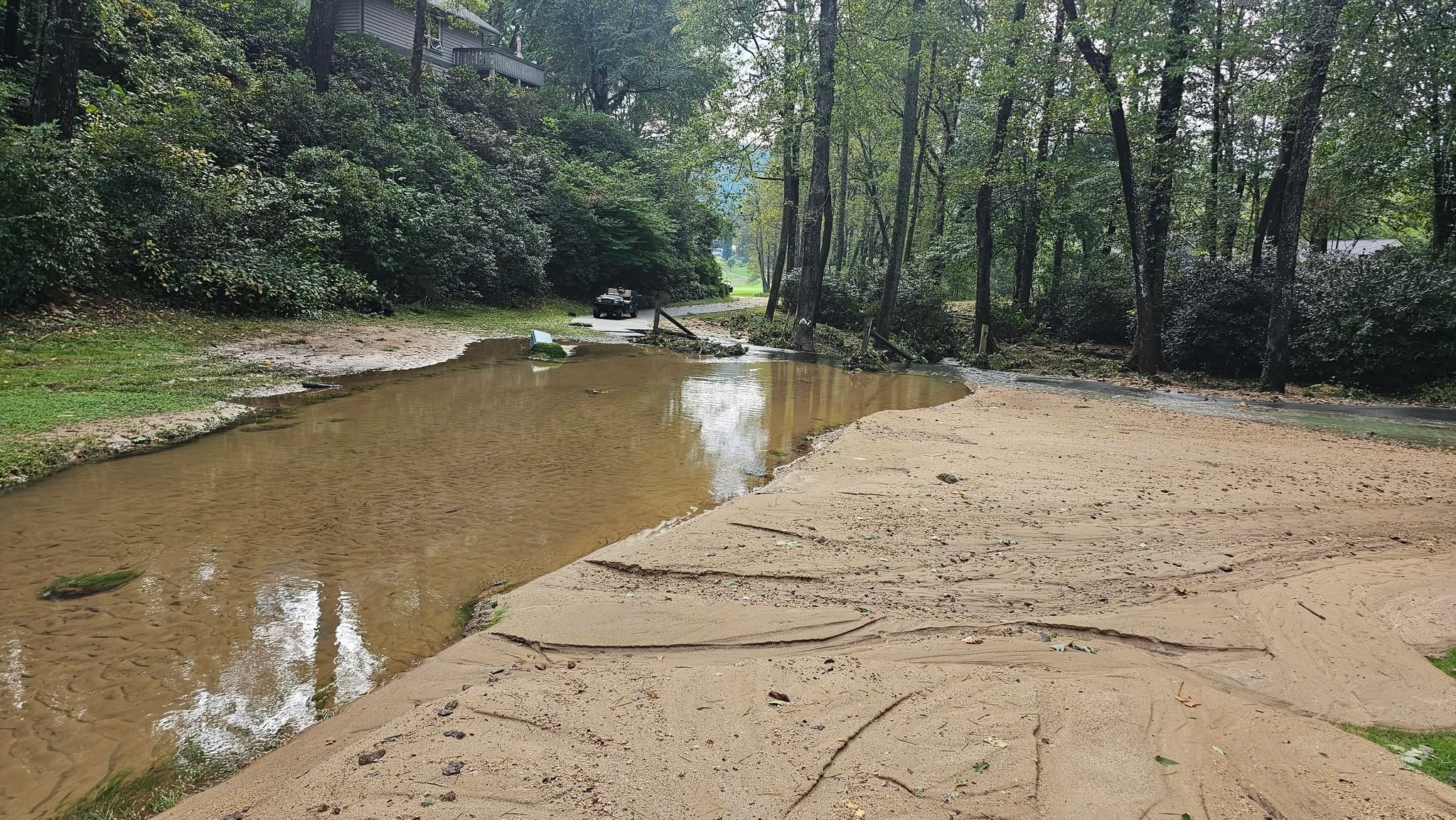

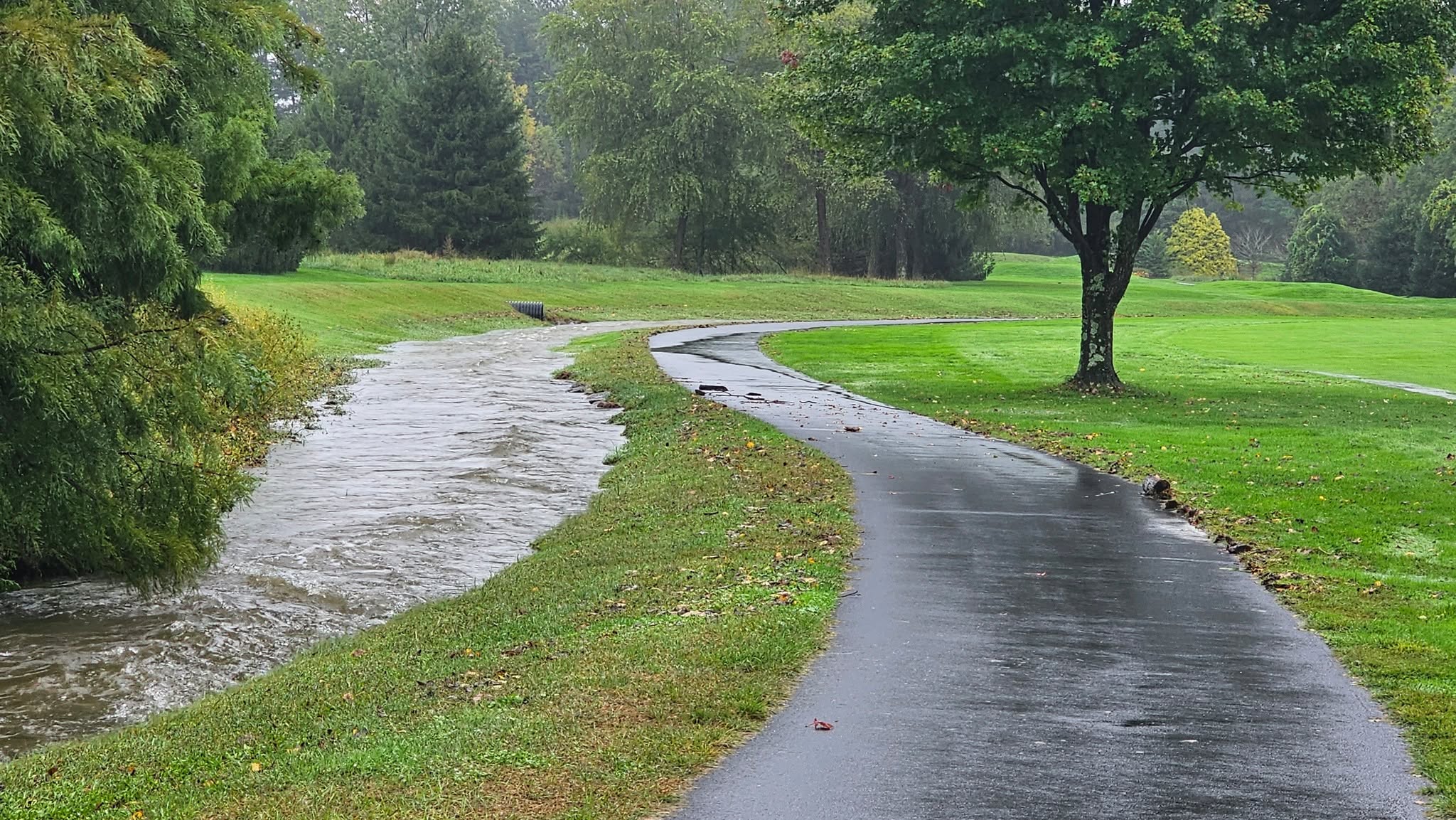

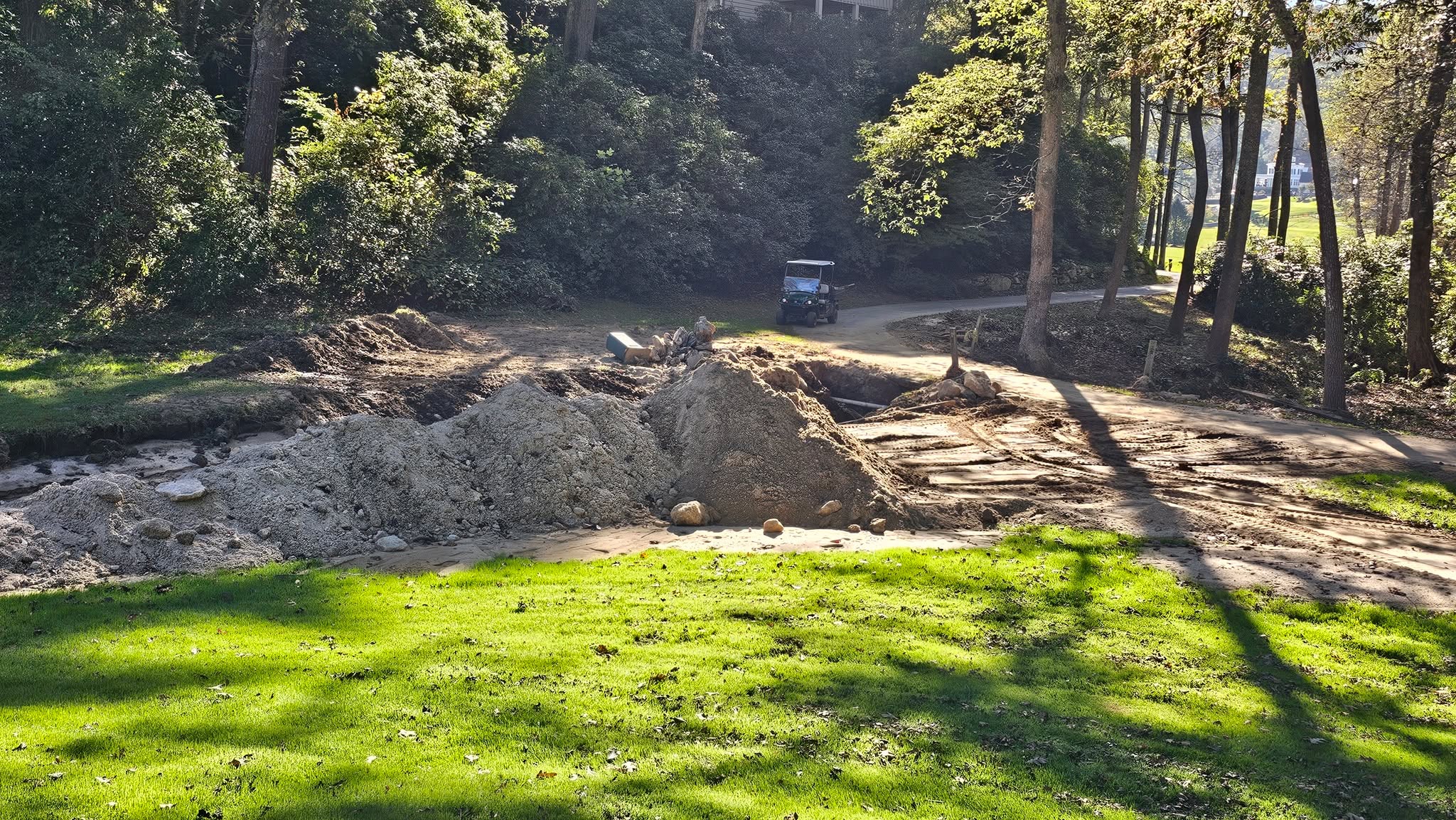

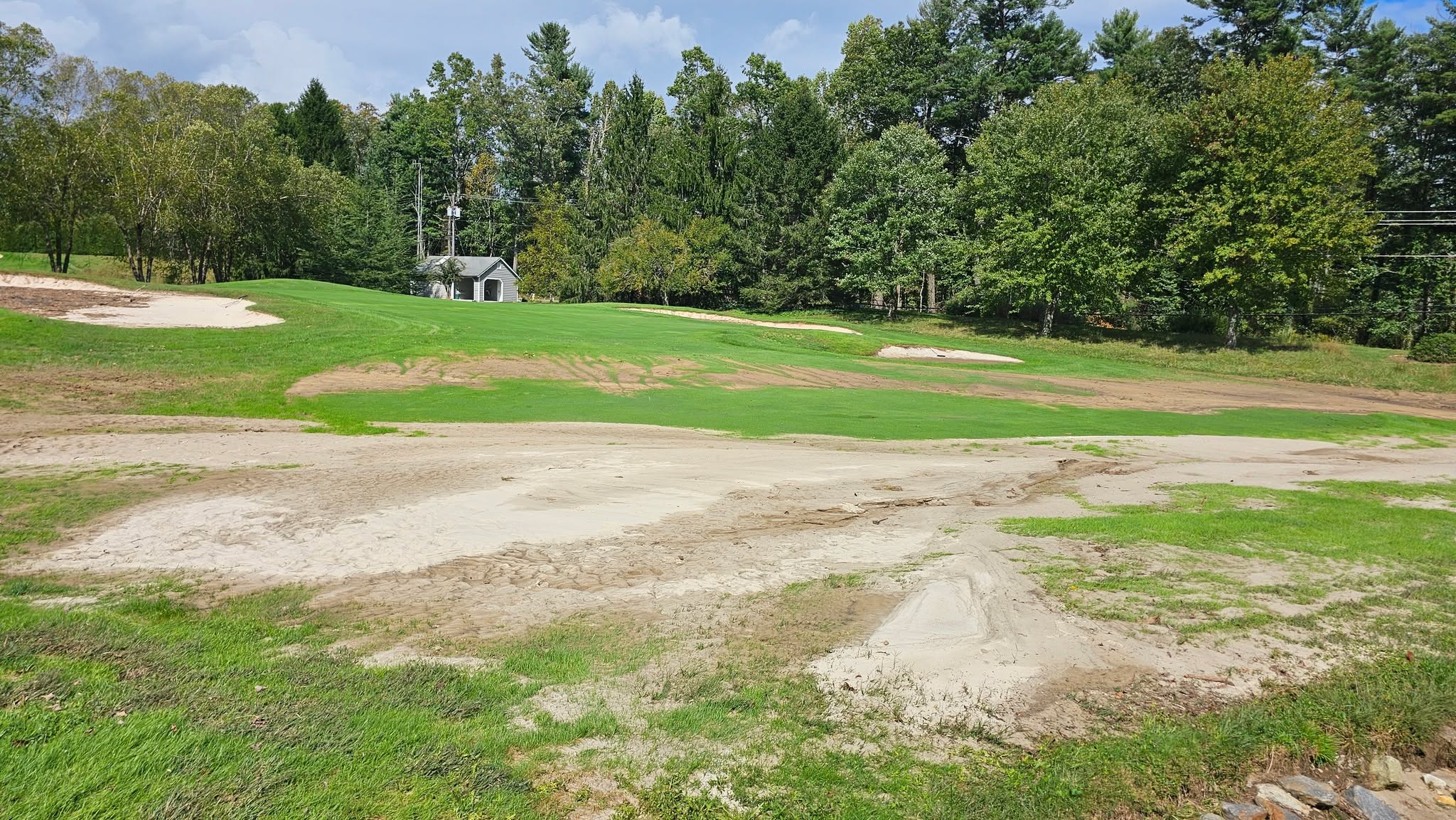

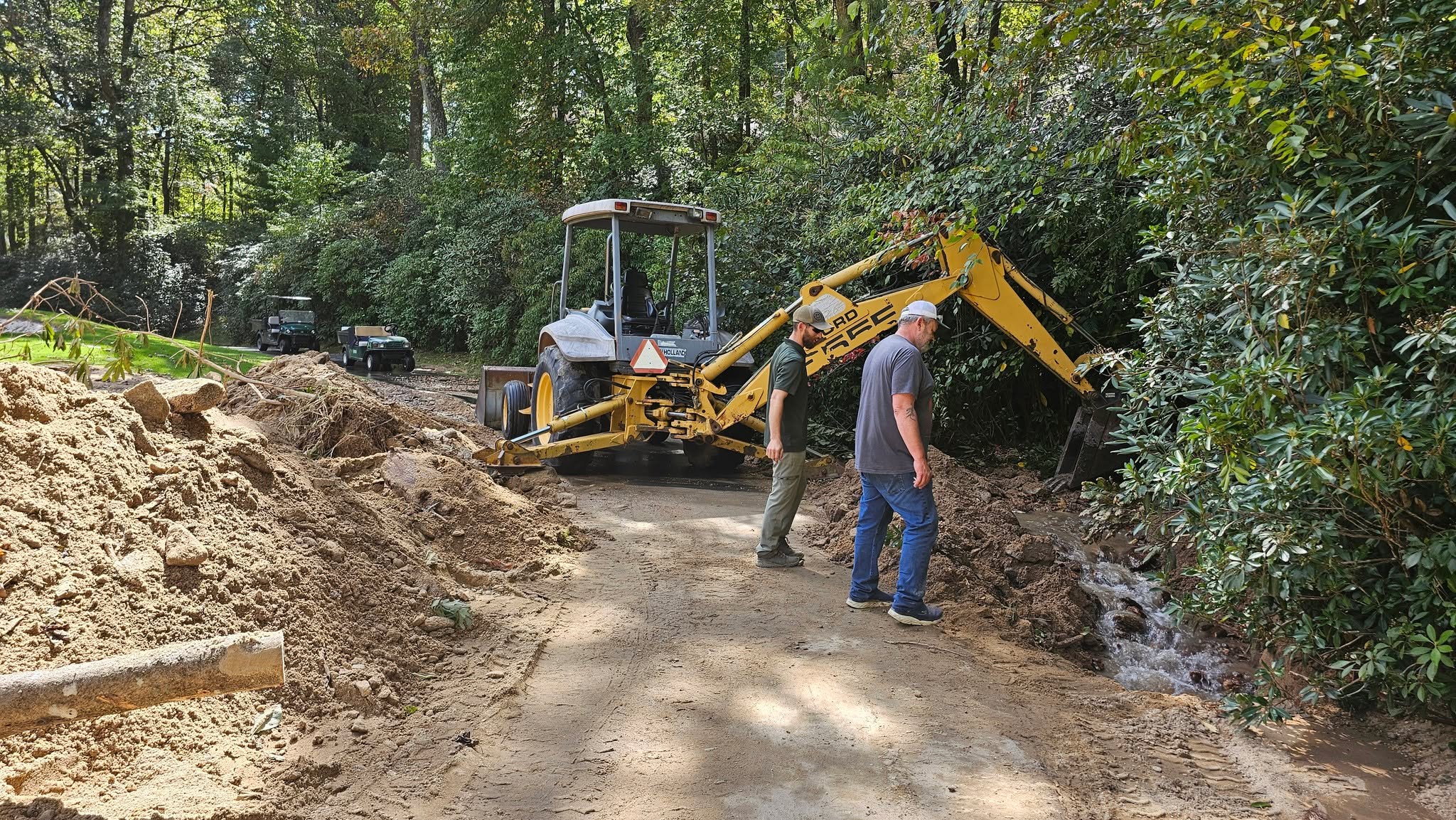

On hole #7, extensive drainage repairs were completed where the cart path was previously washed out and silted over. We installed new drains and laid sod to restore the rough.
Cart Path Paving

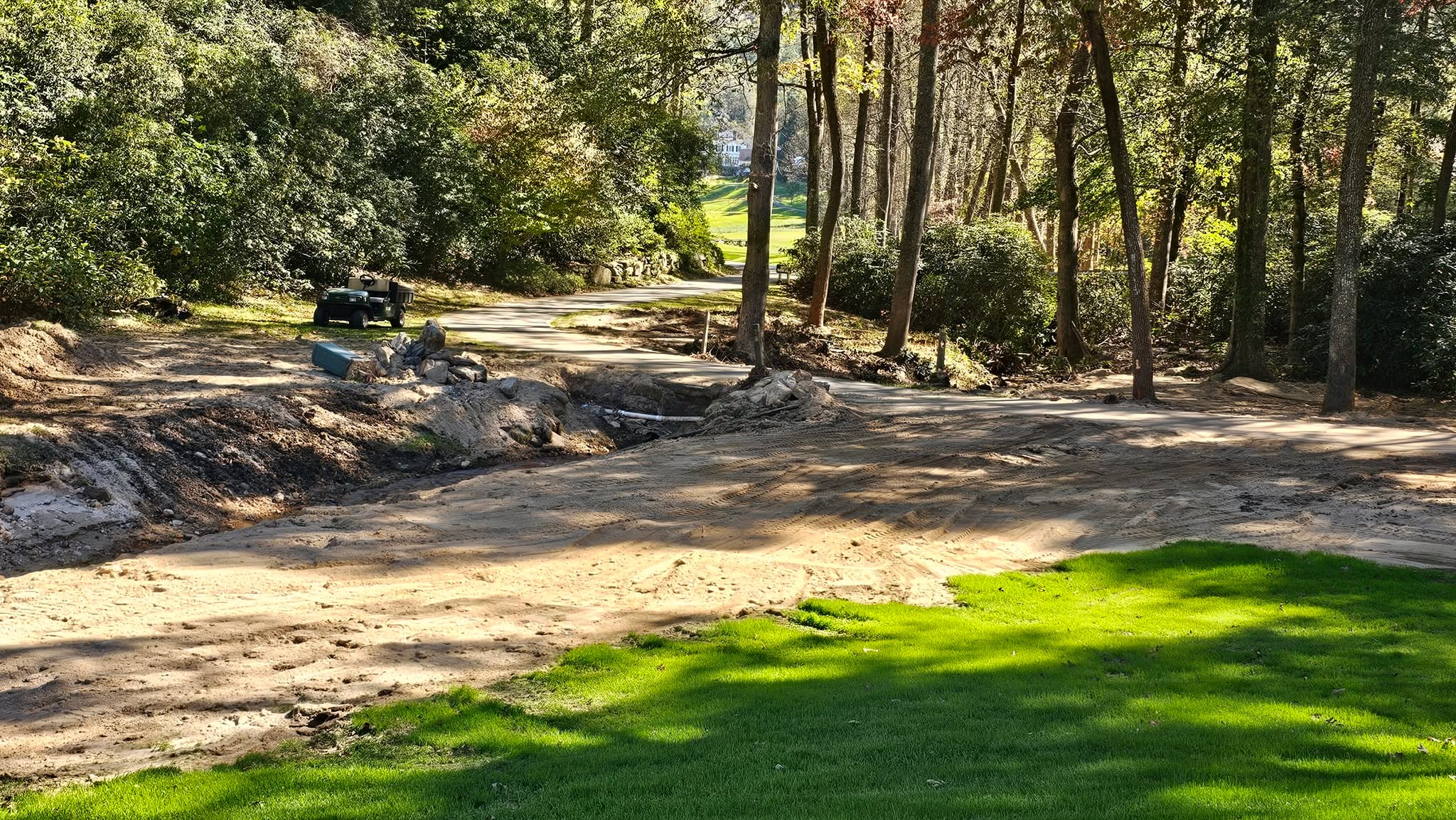

All cart path paving has been approved and will take place soon. While we do not yet have an estimated start date, all damaged areas will be addressed within the next couple of months.
Tee Resurfacing
Several tee projects were completed:

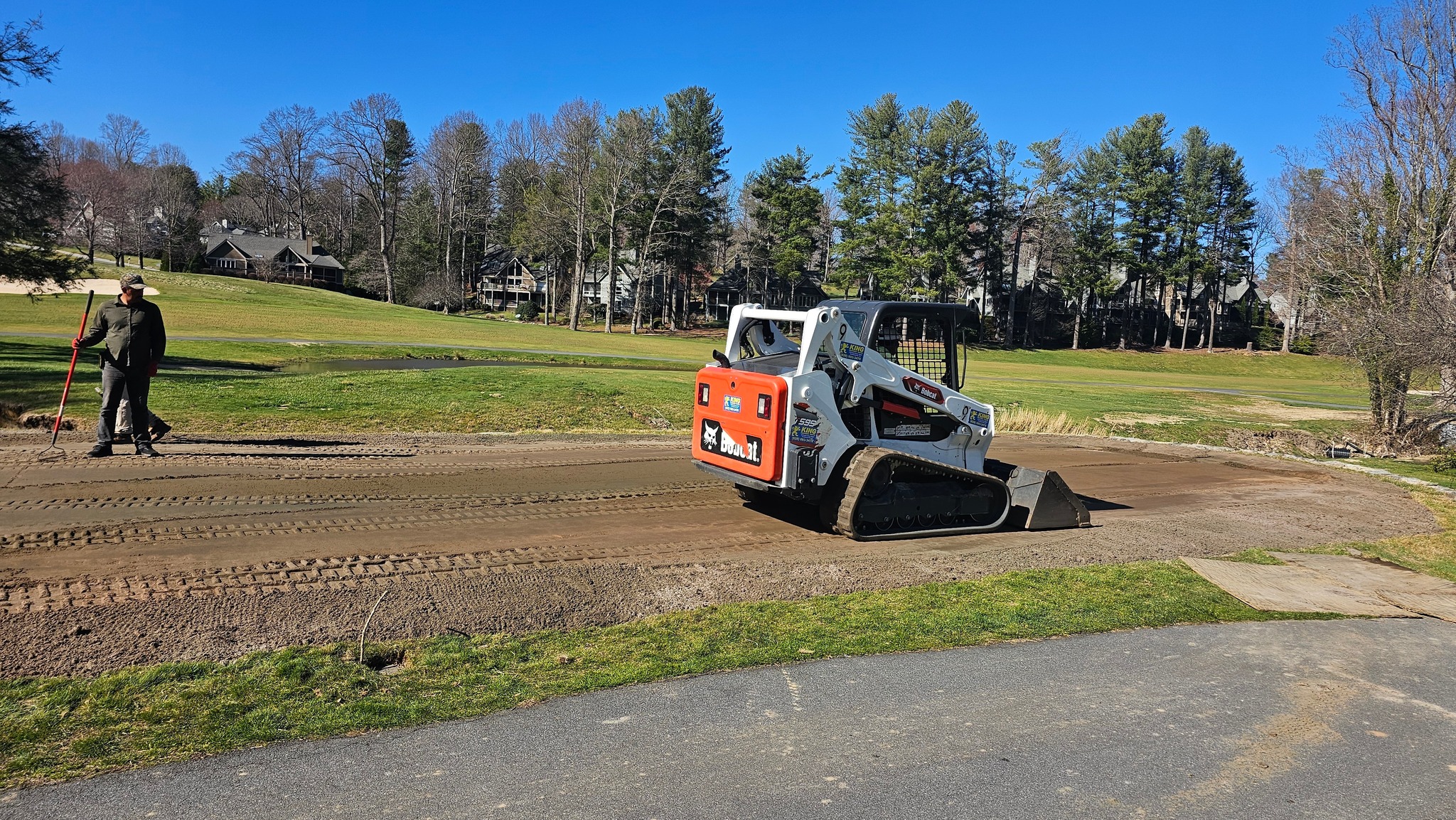

The white/gold tee on hole #8, previously too small for the traffic it received, has been significantly expanded.
The largest tee on hole #9, which was unusable due to its crowned shape, was fully flattened, providing much more playable space.

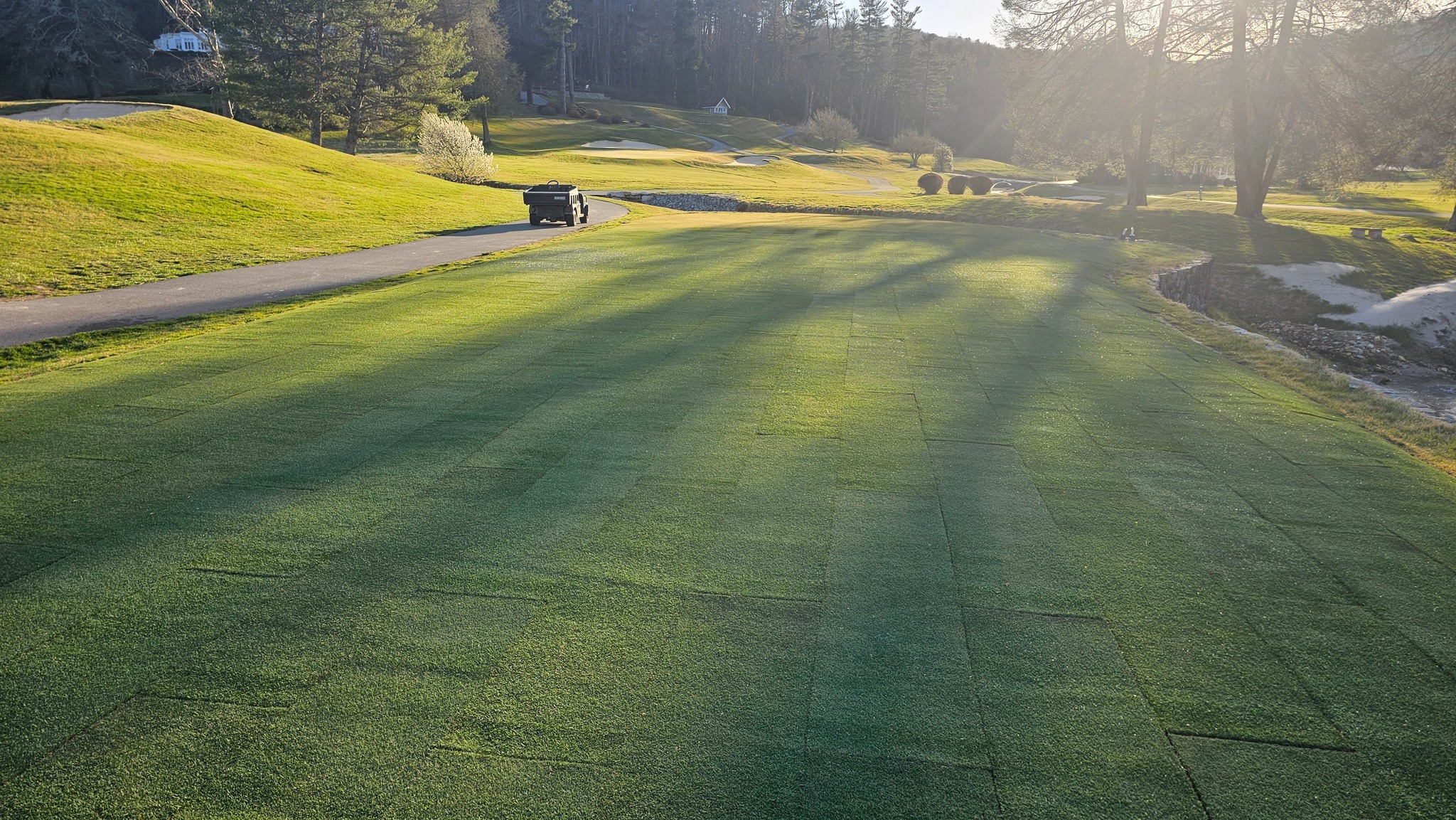

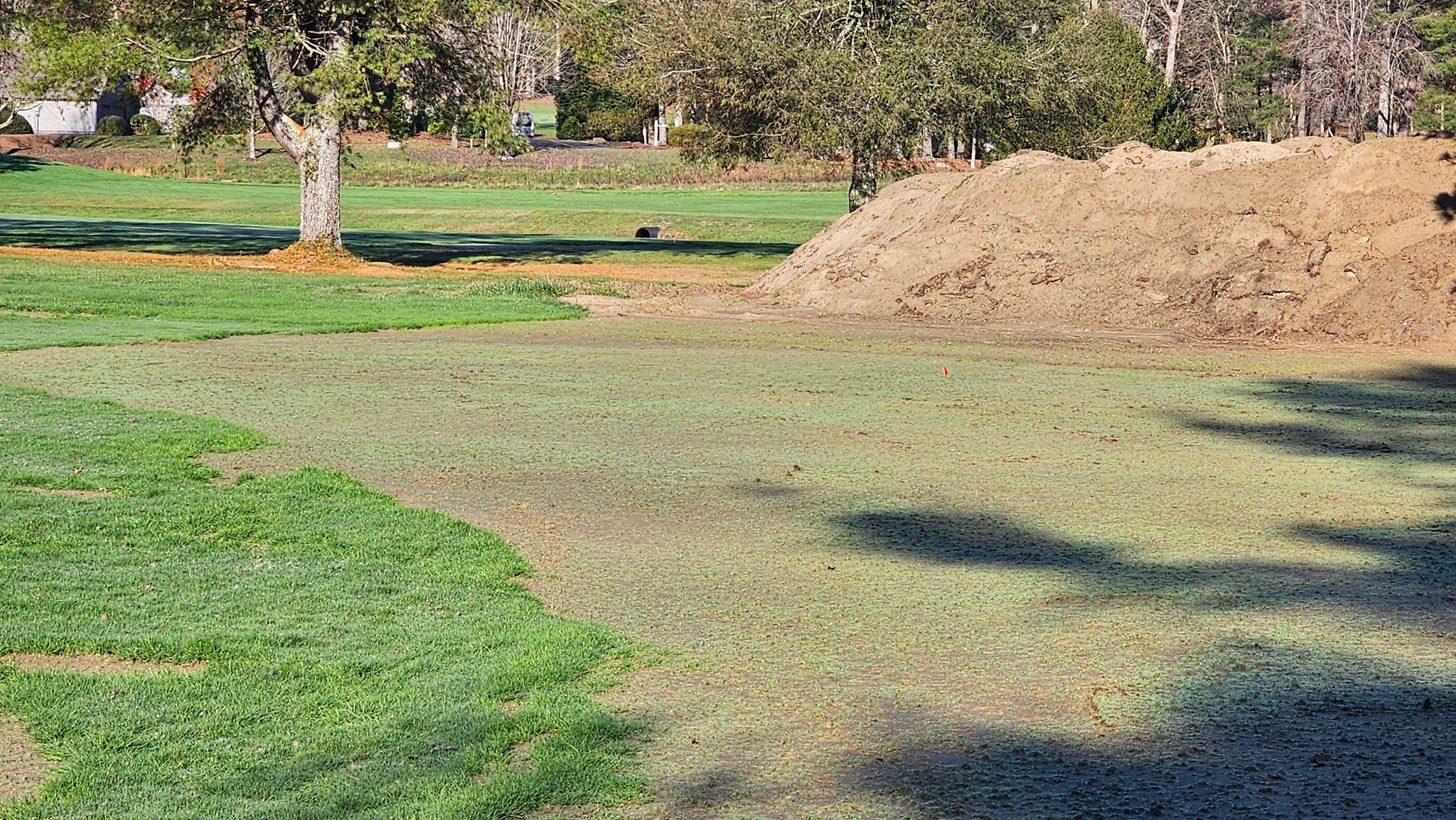

Extra sod was purchased for additional patching on hole #7 (blue/gold tee), hole #16 (blue/gold tee), and various other locations around the course.
Aerification

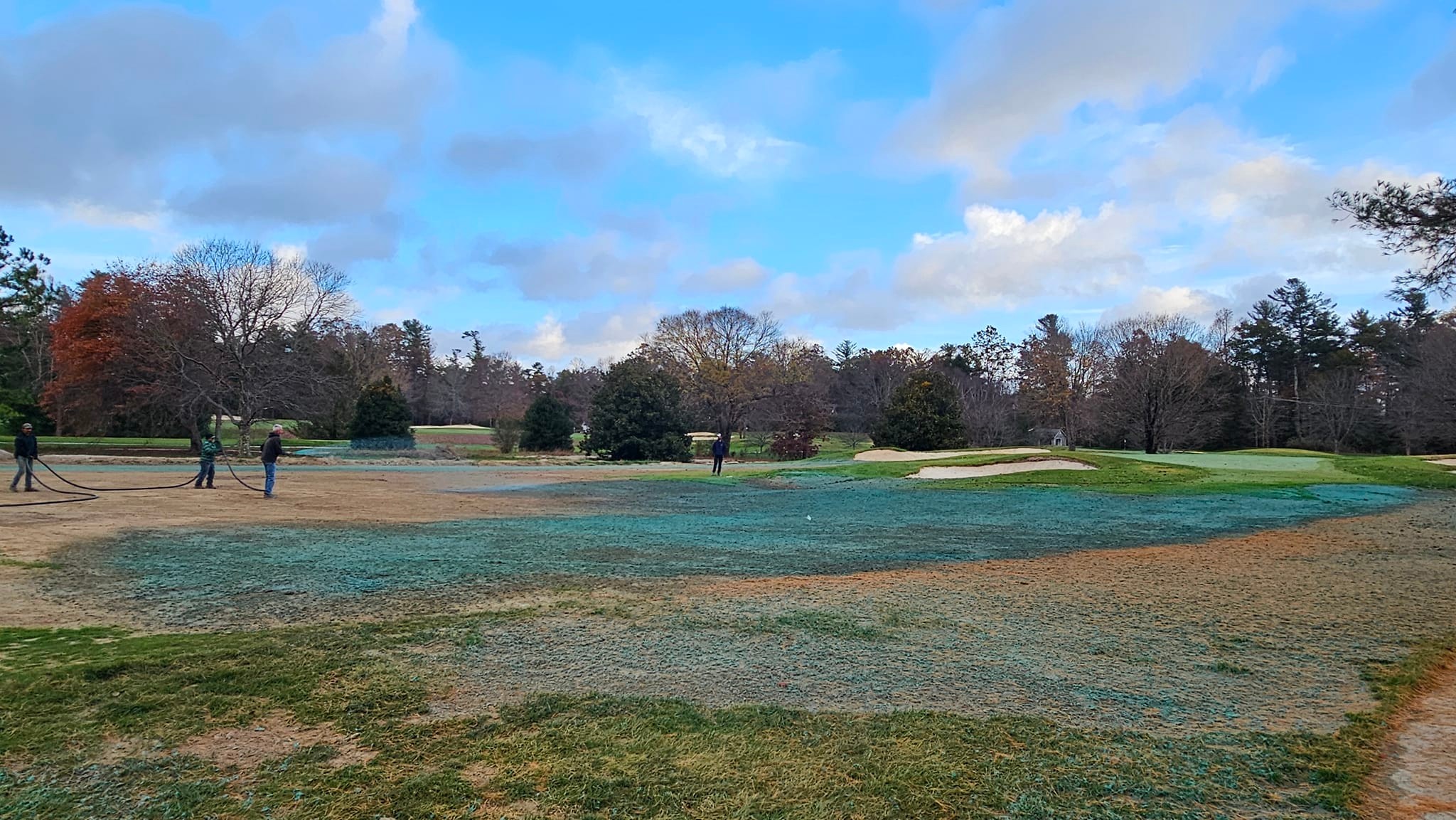

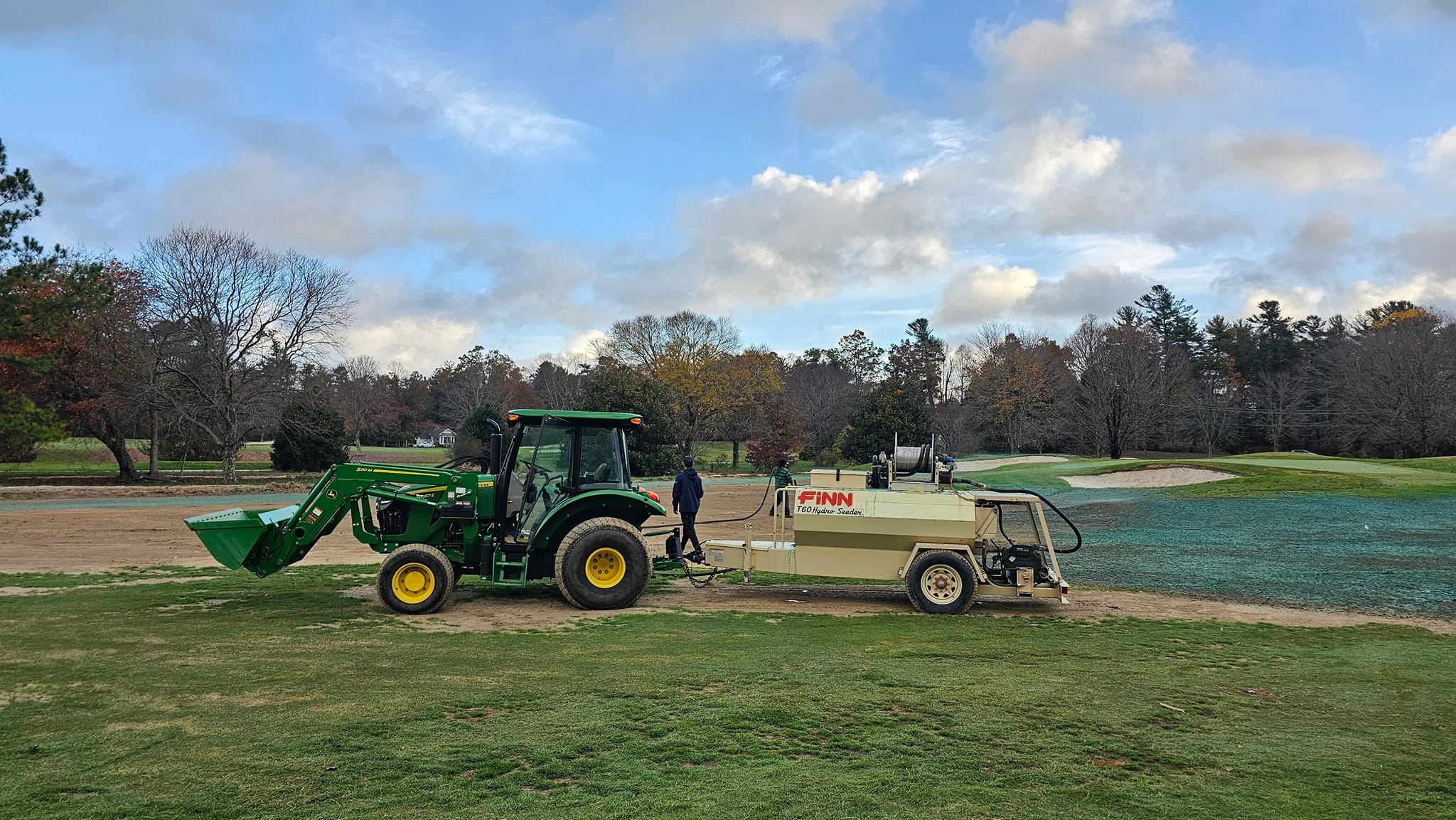

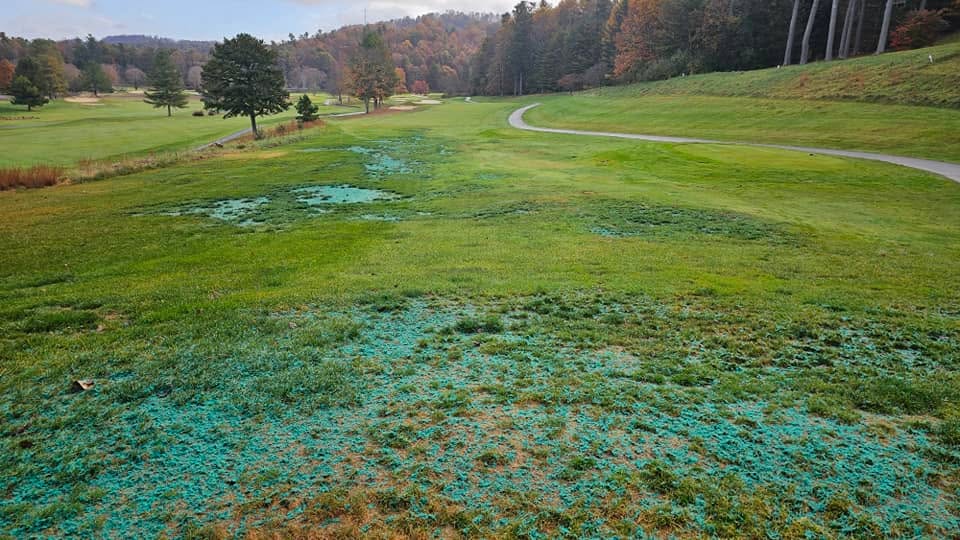

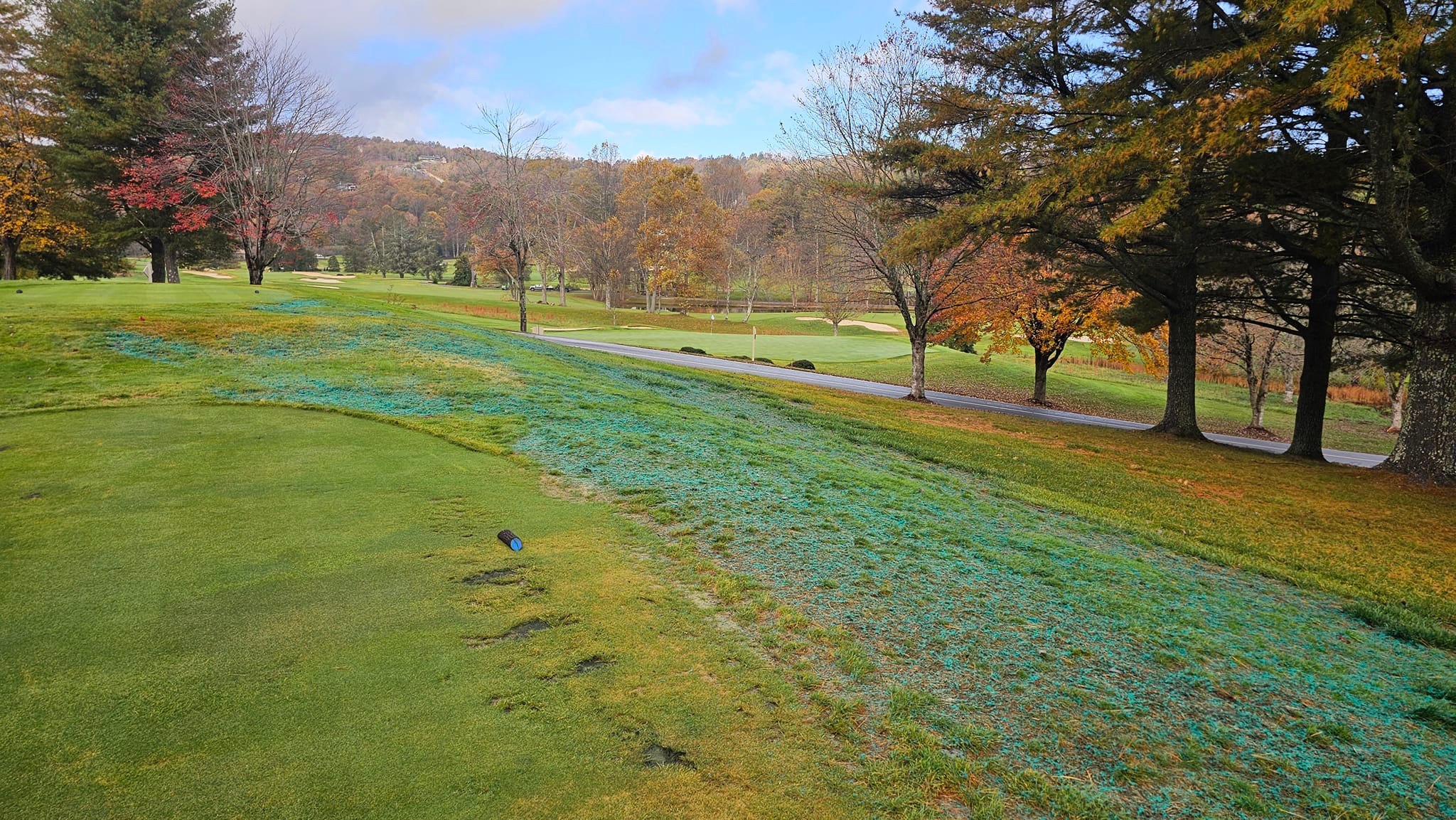

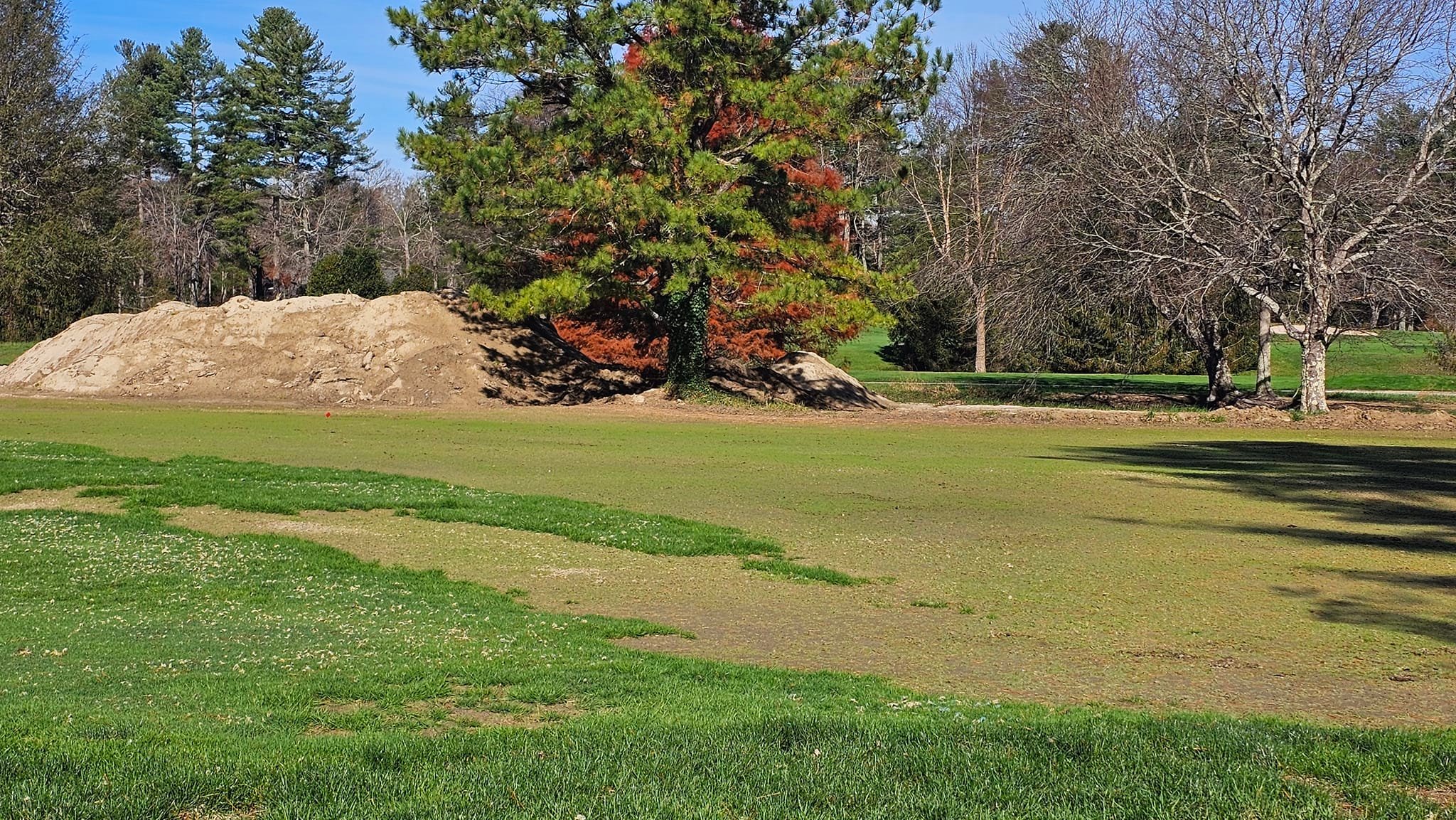

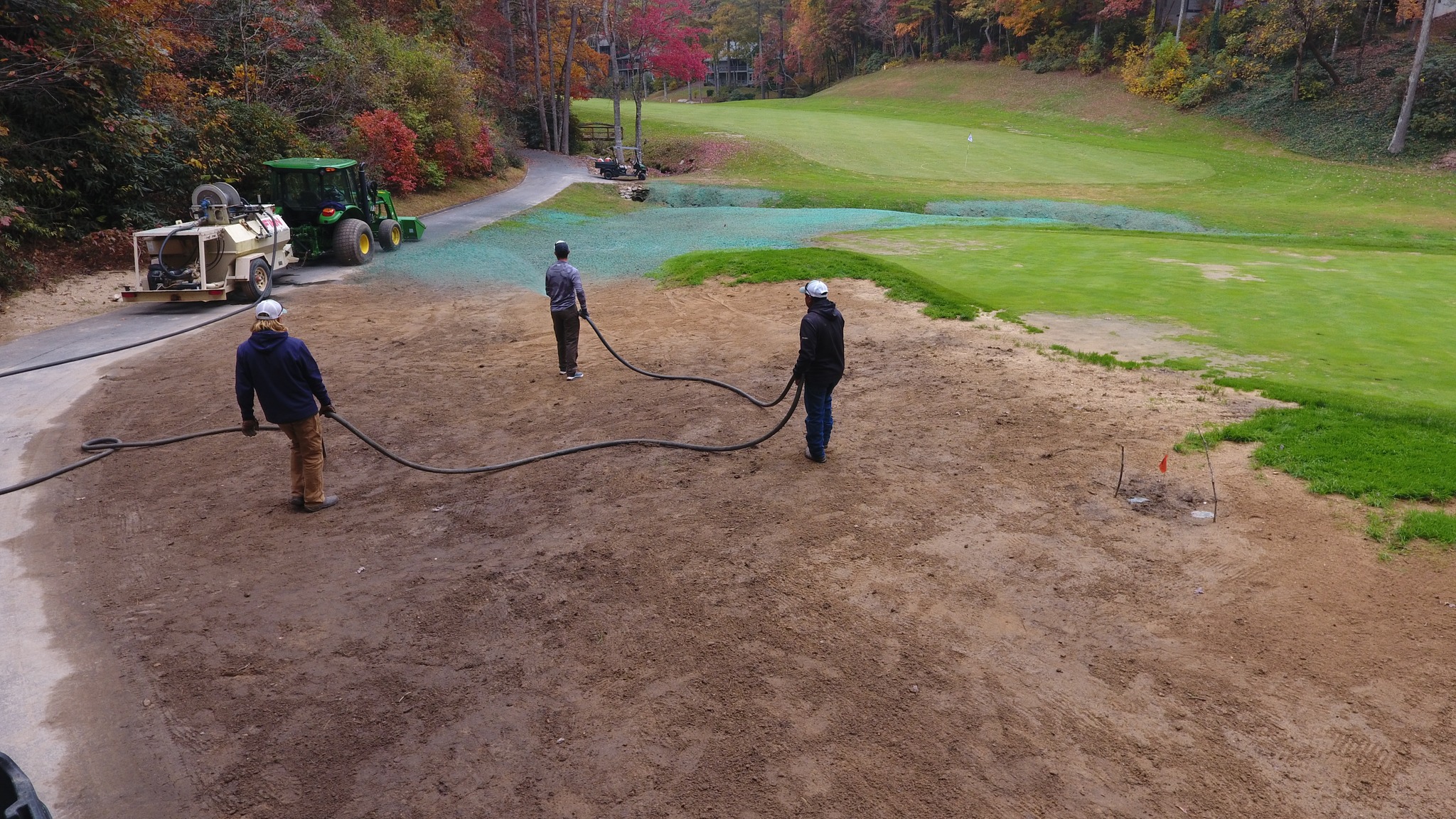

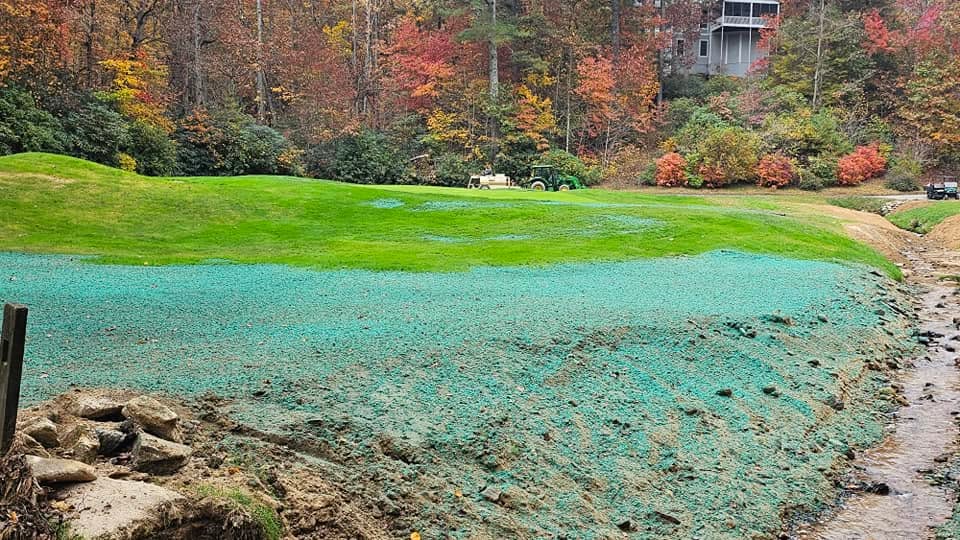

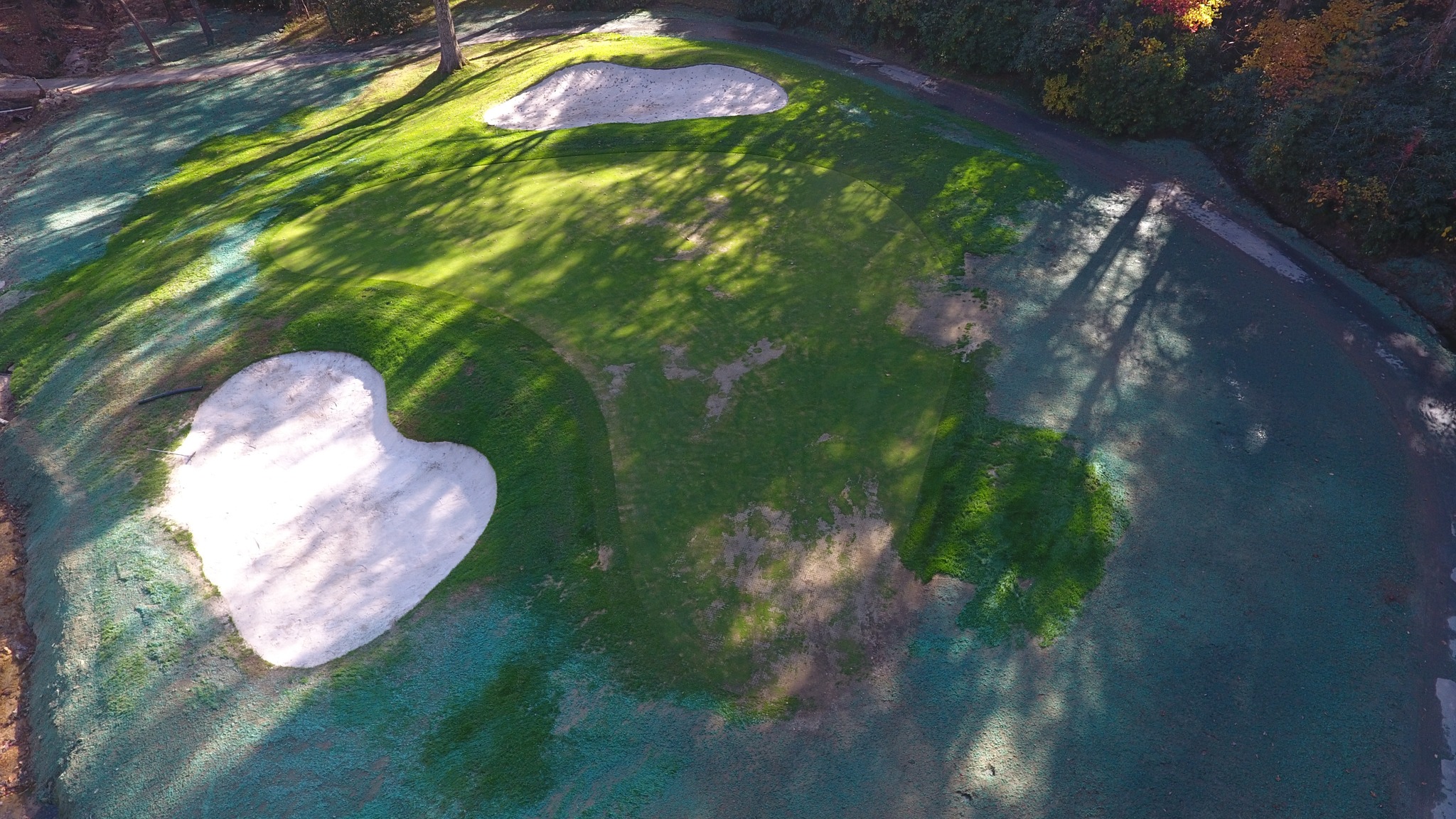

The week of March 17th was designated for aerification. As of Wednesday, aerification and topdressing of the greens have been completed, along with aerification of all fairways. The remaining work includes breaking up and removing the cores. The downtime also allowed us to complete the tee resurfacing project on hole #9, which is expected to wrap up by the end of the week.
Hydroseeding

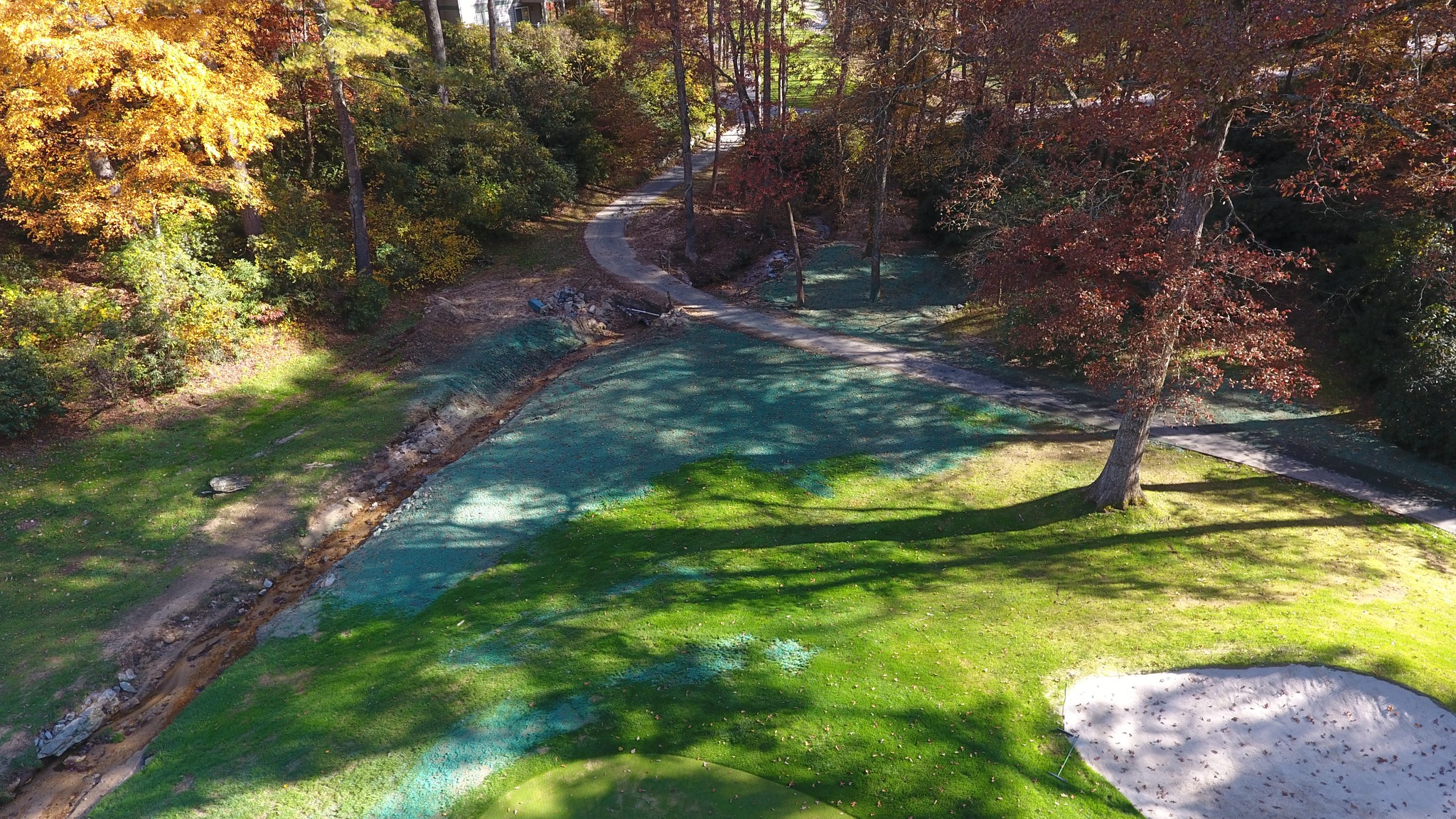

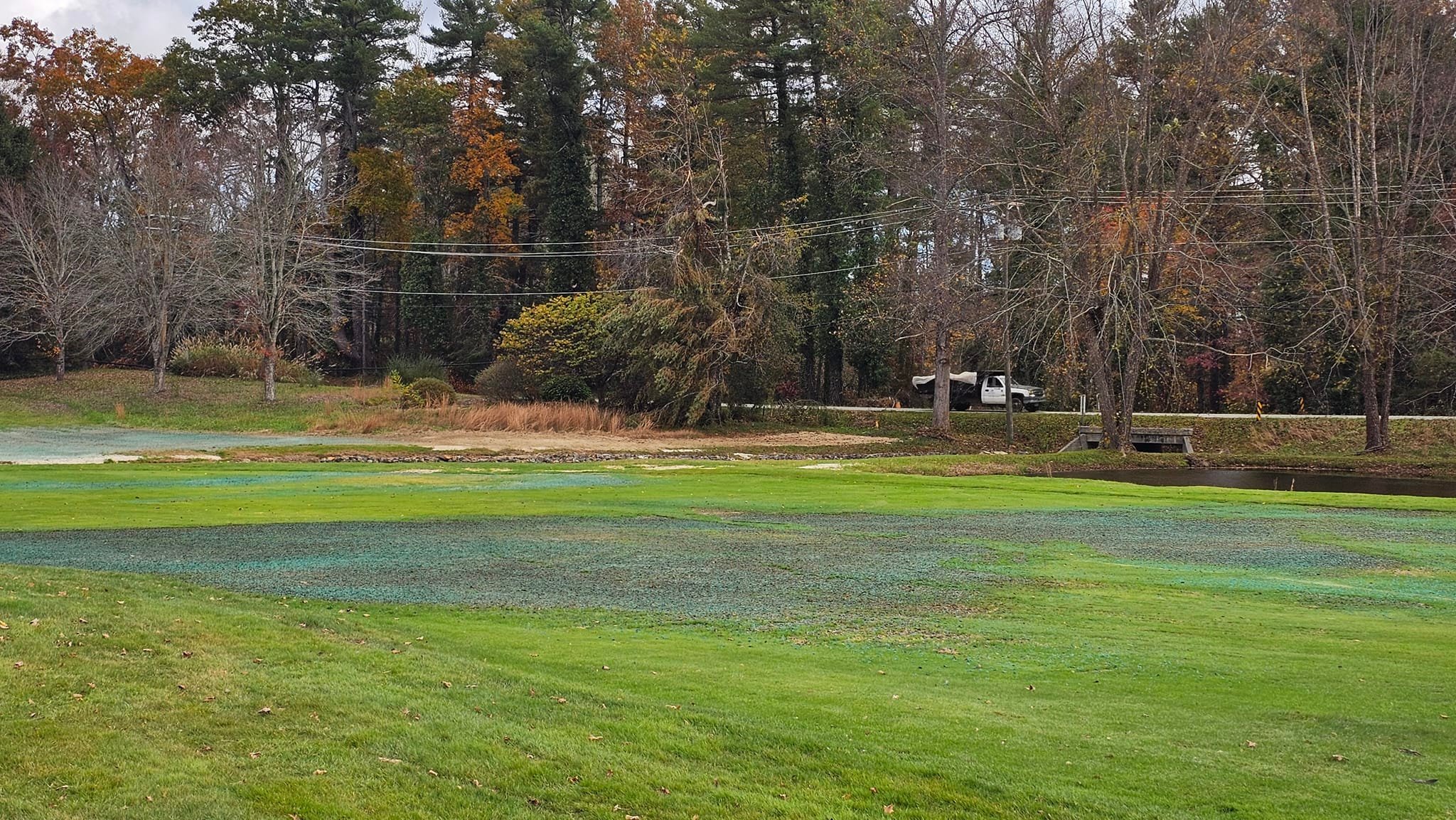

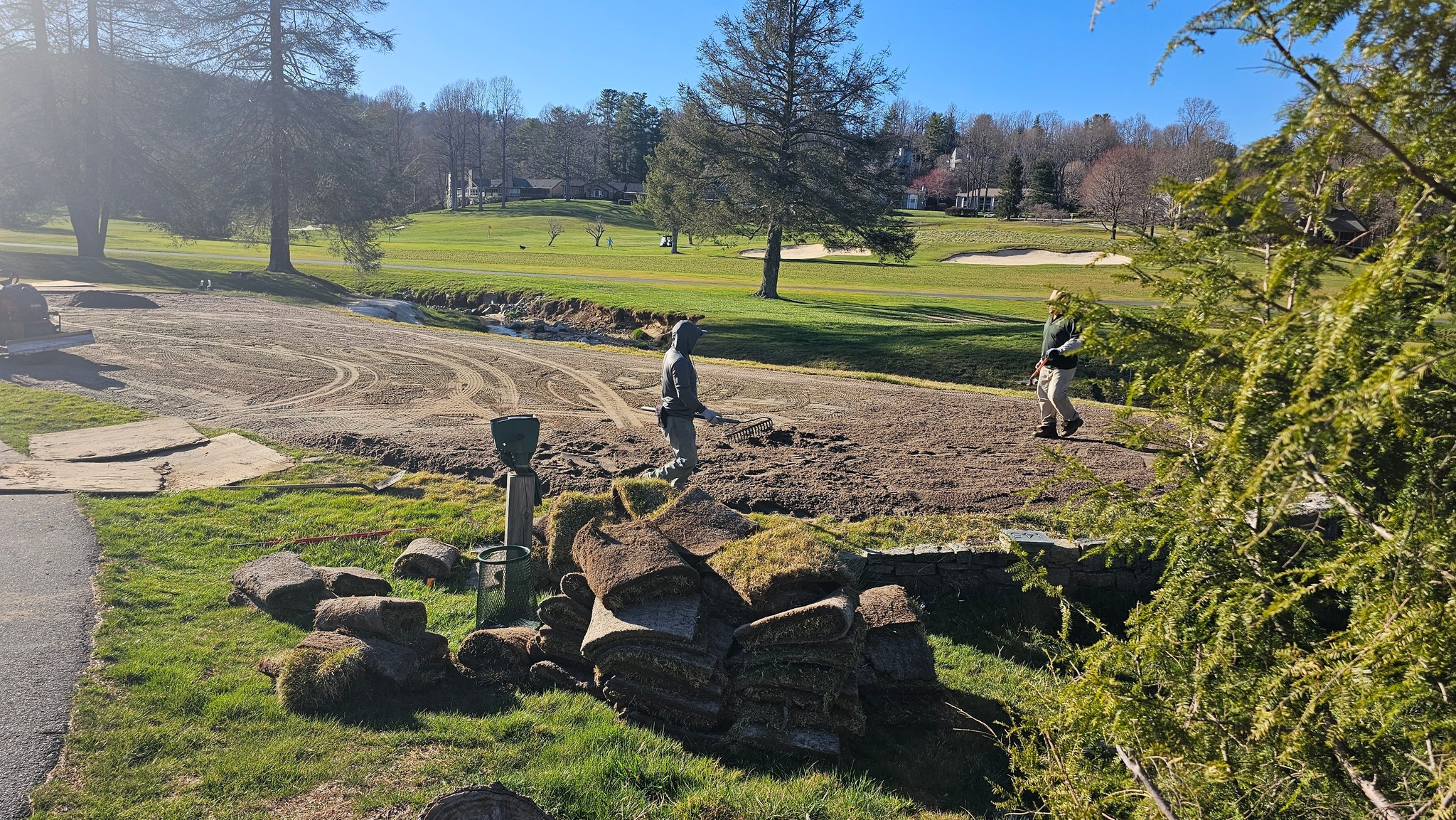

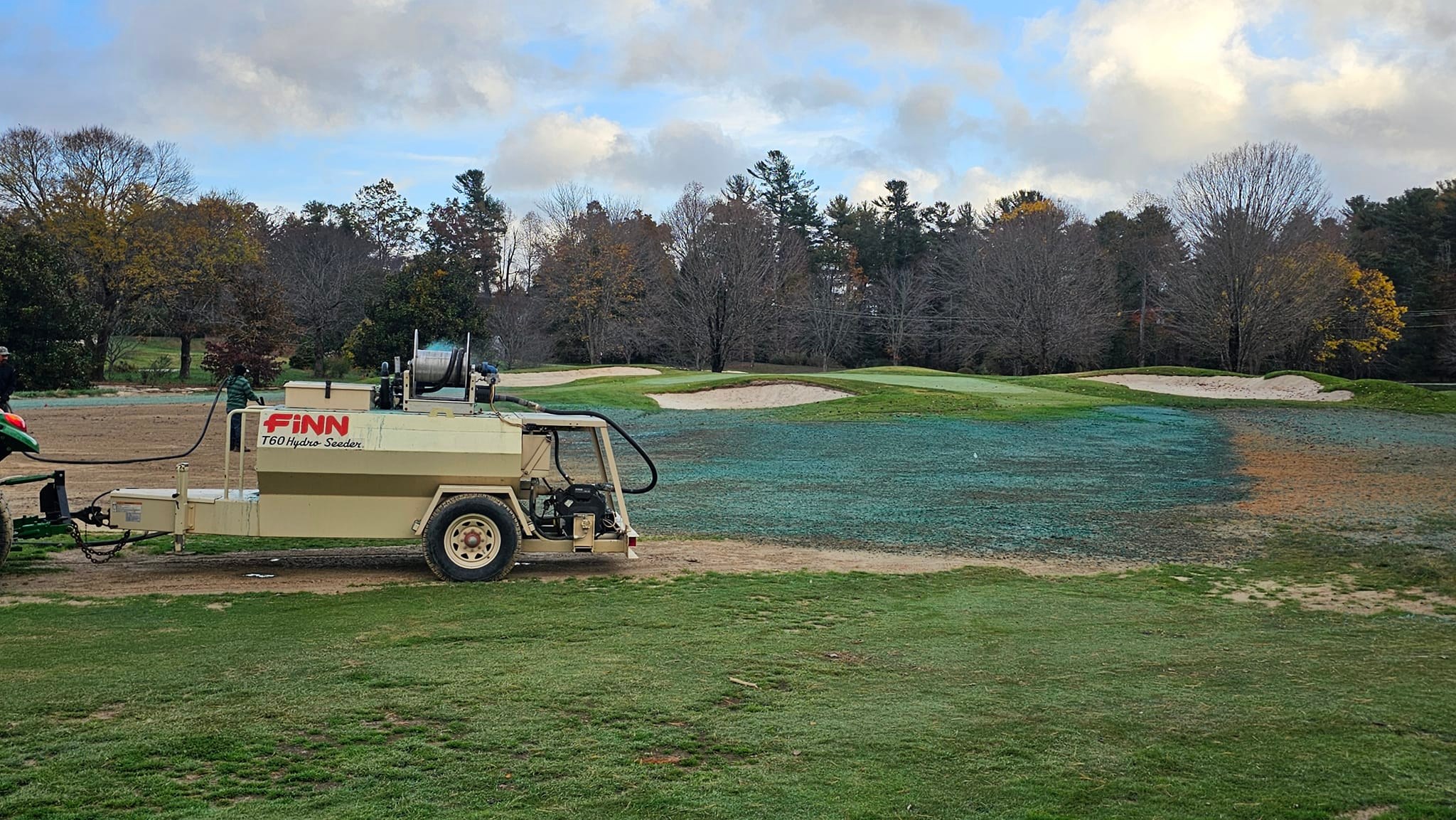

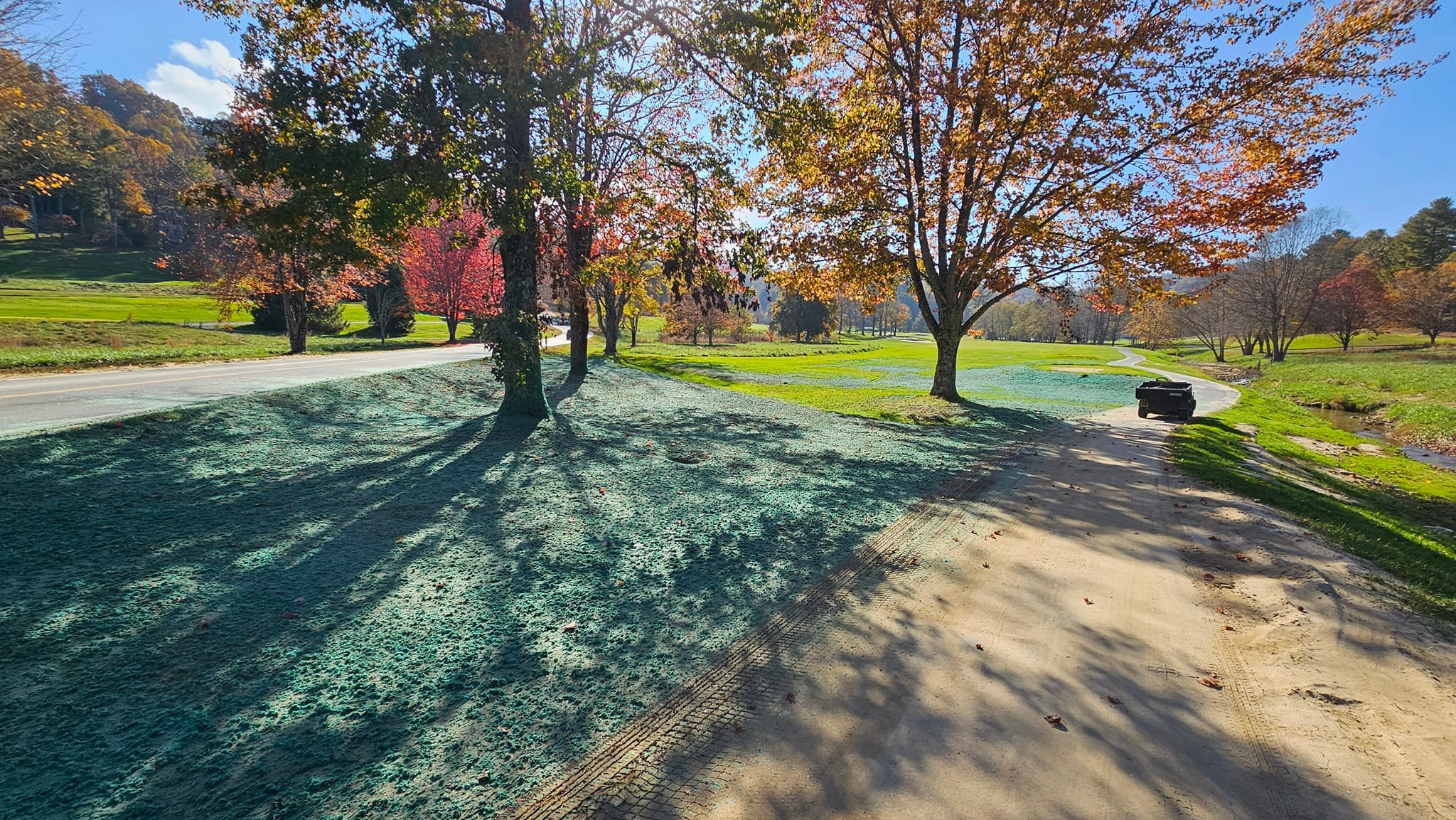

We will be hydroseeding the rough areas left of hole #4, including mounds and any bare spots caused by silt deposits. This project is scheduled within the next two weeks, depending on equipment availability. Since successful germination is dependent on soil temperatures, we are timing this carefully. Fortunately, last fall's seeding efforts were highly successful, and we expect strong turf coverage by May.
Irrigation System Upgrades

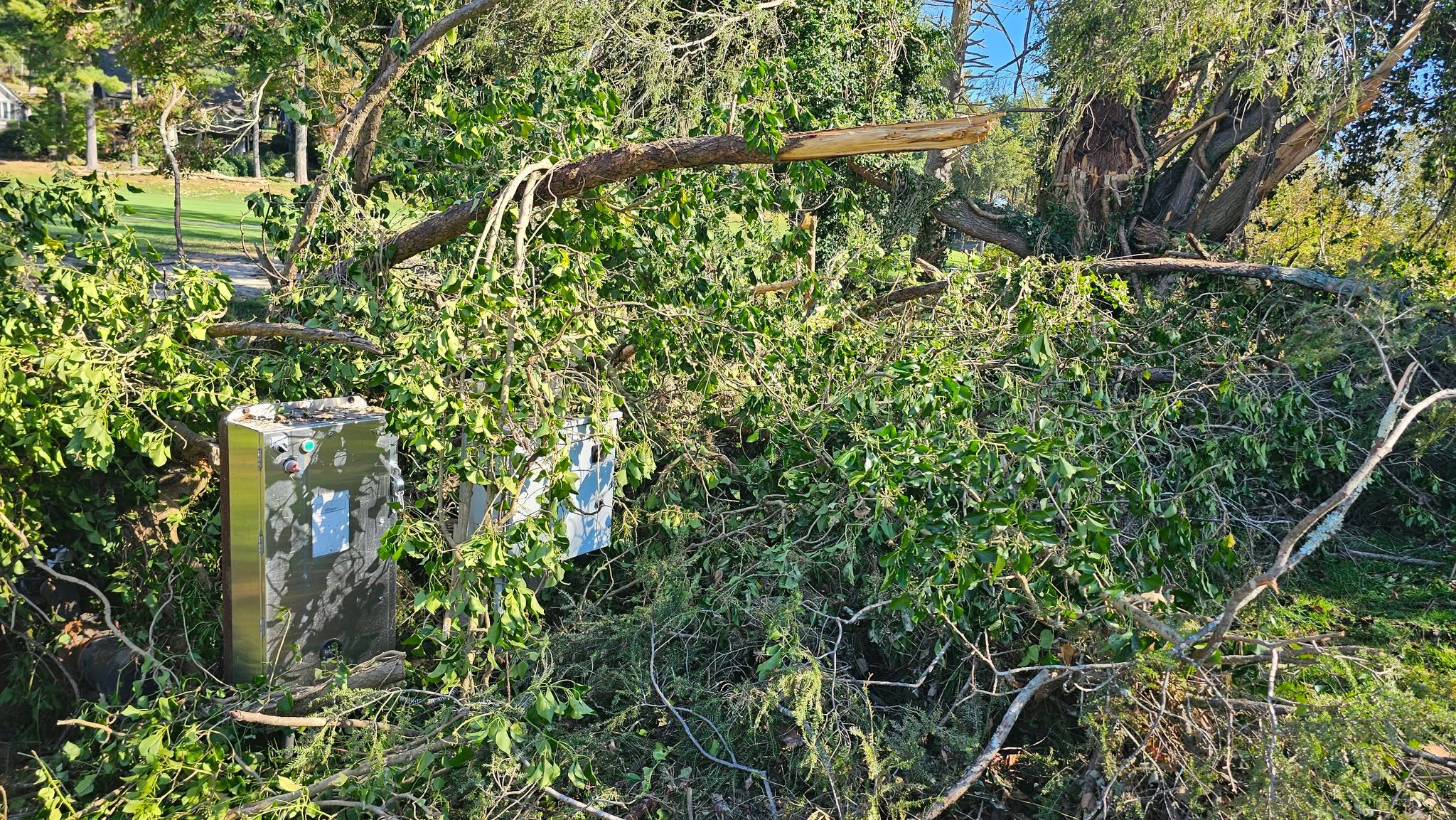

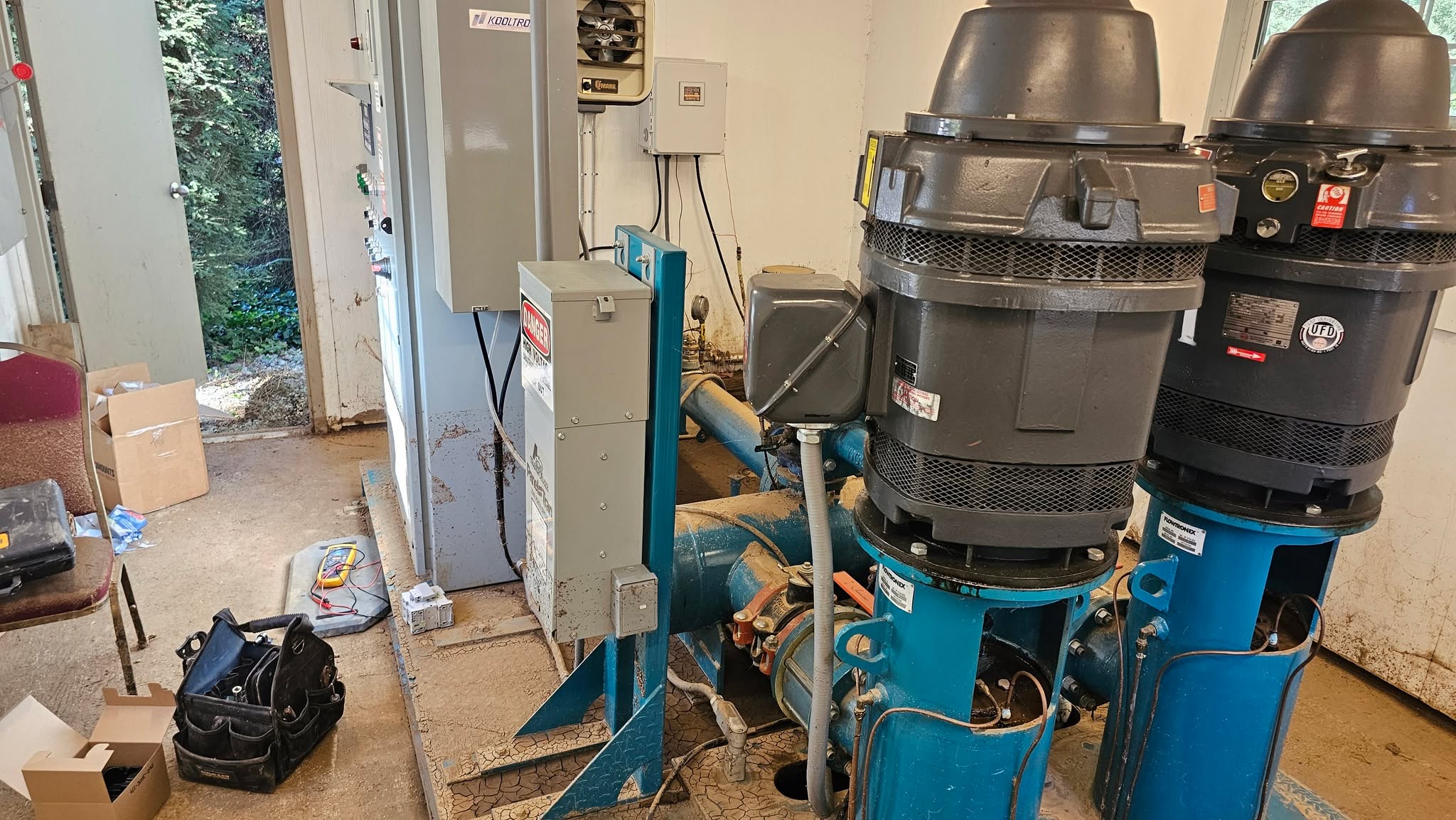

The hurricane severely damaged two satellite control boxes, which we have now replaced. Additionally, we relocated the box on hole #17 further from the creek to minimize future flood risk. As part of a buy-two-get-one-free deal, we also replaced the box on hole #8. This brings the total number of new boxes to three, with seven older boxes still in use. The old boxes are approaching 30 years of service, and we look forward to continued upgrades.

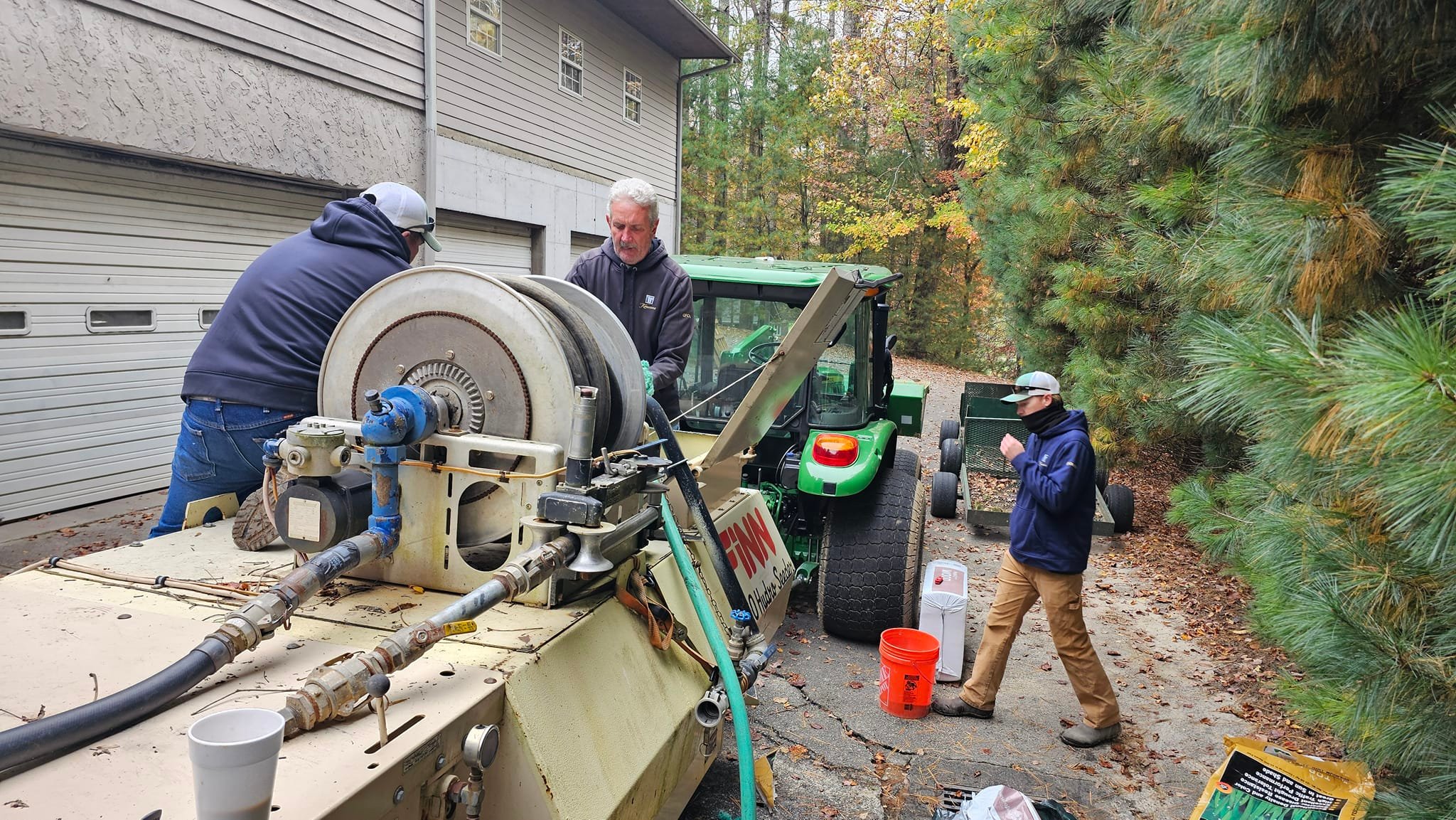

We are also conducting a full irrigation system audit, identifying and addressing minor repairs and sprinkler head issues to ensure optimal performance as we enter the growing season.
Fairway Seeding and Course Recovery

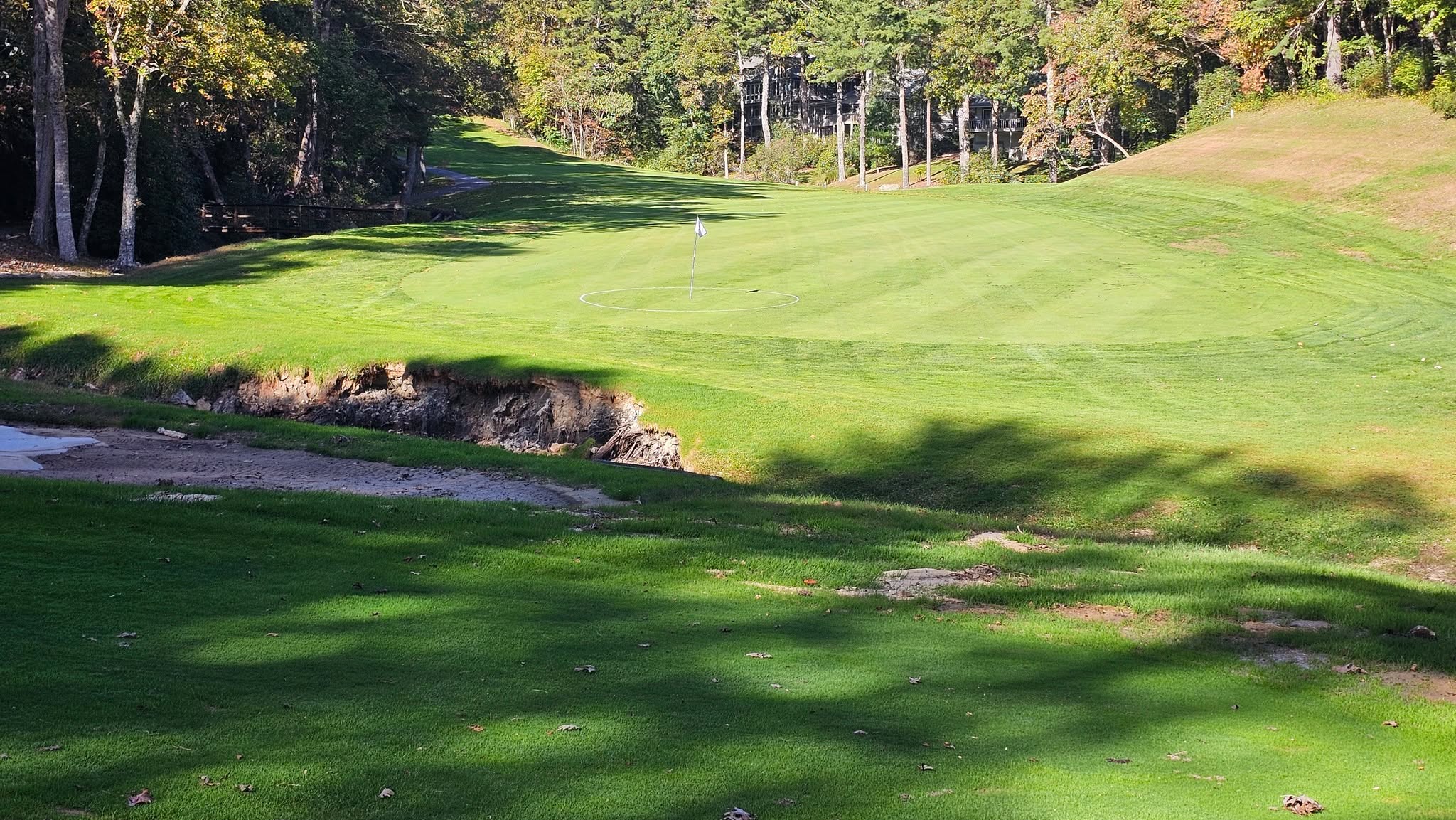

Last year, we seeded fairways on holes #4, #6, and #7. These areas are not yet being mowed, as the grass is still establishing. We expect full turf coverage once growth accelerates.

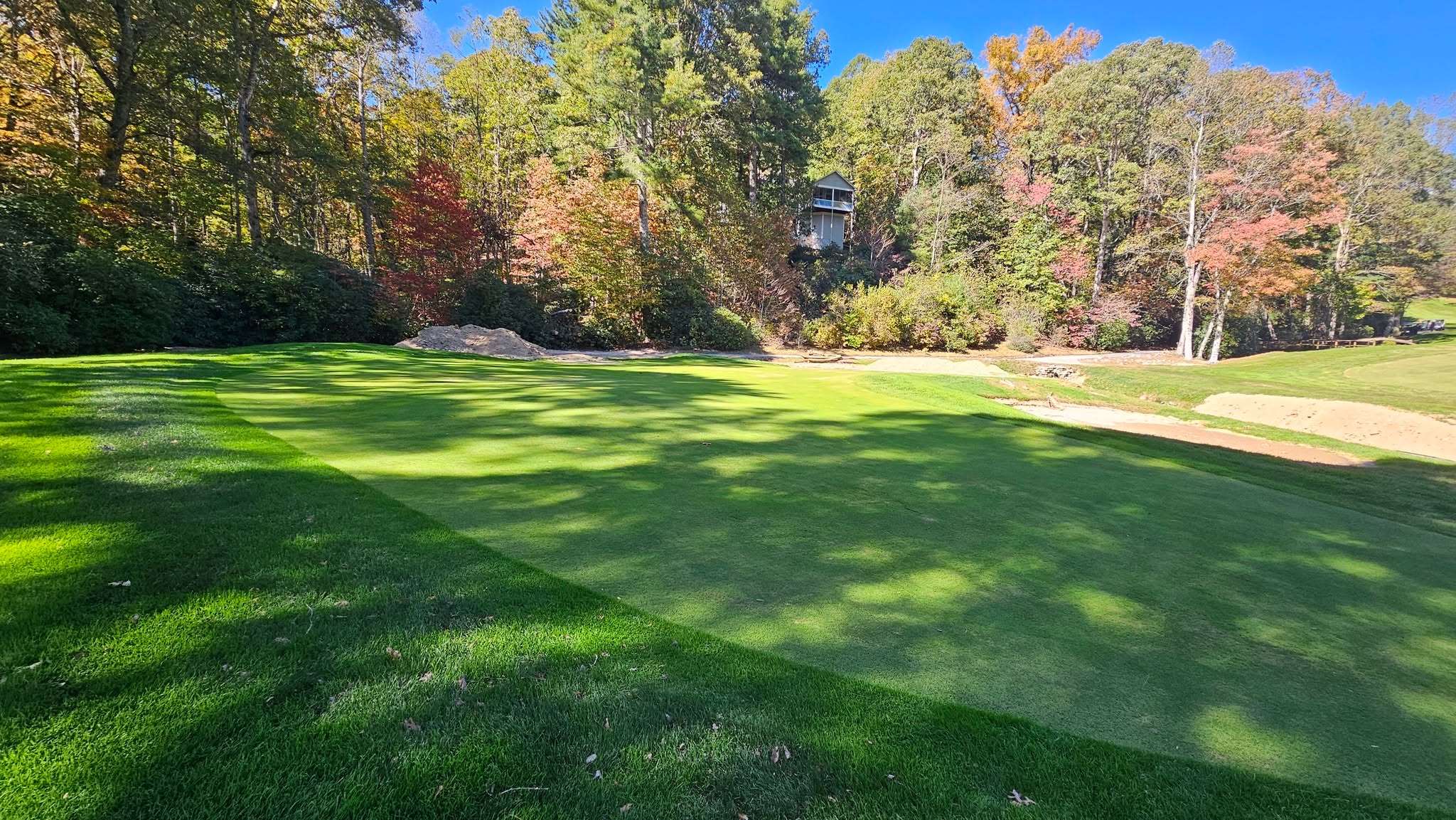

The closures of holes #17 and #4 greens have been primarily to protect newly seeded areas, rather than the greens themselves. While #17 had some surface scarring, it remained playable. We took advantage of a late-season temperature window to complete extensive seeding last fall, putting us ahead of schedule this spring. As soil temperatures rise, air temperatures increase, and daylight extends, these areas will recover well. We anticipate reopening them for play around mid-April, once the turf has developed stronger root systems.
Thank you for your continued support. We are excited about the progress made and look forward to an excellent spring season.
Sincerely,
Josh Laughridge
